Can a 40-Foot Container Truck Reach This Factory? Malaysia Site-Access Checklist | 40尺货柜车能不能进厂?马来西亚工业地产通行检查清单

A practical route, gate, turning, clearance, yard and loading-bay review for factory buyers, warehouse tenants, manufacturers and logistics operators.

Aug 6, 2026
Can a 40-Foot Container Truck Reach This Factory? Malaysia Site-Access Checklist | 40尺货柜车能不能进厂?马来西亚工业地产通行检查清单

A factory may be close to a highway yet remain unsuitable for container operations. Buyers and tenants should test the actual tractor-trailer route, junctions, restrictions, gate approach, swept path, vertical clearance, pavement, waiting area, loading bay and fire access before committing.

BOMBA Fire Certificate factoryfactory CCC and BOMBA approvalfactory truckcontainer truck

Can a 40-Foot Container Truck Reach This Factory? Malaysia Site-Access Checklist40尺货柜车能不能进厂?马来西亚工业地产通行检查清单

A practical route, gate, turning, clearance, yard and loading-bay review for factory buyers, warehouse tenants, manufacturers and logistics operators.为厂房买家、仓库租户、制造商和物流企业准备的路线、闸门、转弯、净空、场院及装卸区实用检查指南。

The answer first/ 先说结论

Do not assume a factory is container-accessible because it is five minutes from a highway or because a 40-foot container appears in the listing photos. A container is only the cargo box. The complete vehicle includes the prime mover, trailer configuration, wheelbase, overhang and turning behaviour; its operating space can be much greater than the container length.不要因为厂房距离高速公路只有五分钟,或房源照片出现过40尺货柜,就认定该物业适合货柜车。 货柜只是载货箱体;完整车辆还包括牵引车、拖架、轴距、前后悬及转弯特性,真正需要的操作空间会远大于货柜长度。

Before buying or leasing an industrial property in Malaysia, test the full journey from the intended highway exit or port route to the loading position. Verify public-road restrictions, bridges and underpasses, junction geometry, residential bottlenecks, gate approach, trailer cut-in and rear swing, overhead clearance, culverts and yard pavement, reversing distance, dock arrangement, waiting space, pedestrian separation and fire-appliance access.
购买或租赁马来西亚工业地产前,应测试从预定高速出口或港口路线到装卸位置的完整行程。核实公共道路限制、桥梁和地下通道、路口几何、住宅区瓶颈、闸门进场角度、拖架内轮差及车尾外摆、上方净空、涵洞和场院路面、倒车距离、装卸台、等候区、人车分流和消防车通道。

The most reliable sequence is:
1. define the actual design vehicle and operating pattern;
2. trace the complete route at the hours the business will operate;
3. measure the gate, turns, clearances, structures and loading apron;
4. run a swept-path assessment or controlled vehicle trial;
5. confirm authority, safety and fire-access requirements; and
6. put unresolved access works and approvals into the offer or tenancy conditions.

最可靠的顺序是:
1. 定义实际使用的设计车辆和营运方式;
2. 在企业真正会营运的时间检查完整路线;
3. 测量闸门、转弯、净空、结构和装卸场;
4. 进行车辆轨迹分析或受控实车测试;
5. 确认政府、安全和消防通道要求;
6. 把尚未完成的通道工程和批准写入要约或租赁条件

A 40-foot container is not a vehicle specification40尺货柜不等于车辆规格
Two vehicles carrying the same nominal container can have different prime movers, trailer types, axle arrangements, wheelbases, front and rear overhangs and turning paths. A site that works for one haulier's combination may not work for another.
两辆运载同样货柜的车辆,可能采用不同牵引车、拖架、车轴、轴距、前后悬和转弯轨迹。适合某一家运输公司的组合,不一定适合另一辆车。

Malaysia's Road Transport Department (JPJ) vehicle engineering process records fields such as overall length, height and width, wheelbase, overhang, gross vehicle and combination weight, and permissible axle weights. The official JPJ Weight Certificate guidance illustrates why the complete vehicle specification—not the box length—is the correct starting point.
马来西亚陆路交通局(JPJ)的车辆工程程序会记录车辆总长度、高度和宽度、轴距、悬长、车辆/组合总重量及允许车轴重量等资料。官方JPJ重量证书说明显示,正确起点是完整车辆规格,而不是货柜箱长度。

Prepare a “design vehicle” sheet showing:
- prime-mover make and configuration;
- trailer type and axle arrangement;
- container type, including standard or high-cube where relevant;
- total vehicle length, width and operating height;
- wheelbase and overhangs;
- turning-circle or swept-path data;
- gross combination and axle loads for loaded movements;
- frequency of daily or weekly arrivals;
- whether vehicles arrive loaded, empty or both;
- reversing, side-loading or dock-loading requirement; and
- whether two trucks must pass or queue simultaneously.

应准备一份“设计车辆”资料表,包括:
- 牵引车型号和配置;
- 拖架类型和车轴配置;
- 标准柜或高柜等货柜类型;
- 车辆总长度、宽度和操作高度;
- 轴距及前后悬;
- 转弯圆或车辆轨迹资料;
- 满载时的组合总重和车轴负荷;
- 每日或每周抵达次数;
- 满载、空载或两种情况;
- 倒车、侧面装卸或装卸台需求;
- 是否需要两辆车同时交会或排队。

Obtain the dimensions from the intended haulier, vehicle documents or a qualified transport professional. Do not invent them from a generic internet diagram.
资料应来自拟使用的运输公司、车辆文件或合资格交通专业人士,不要从网上通用示意图自行猜测。

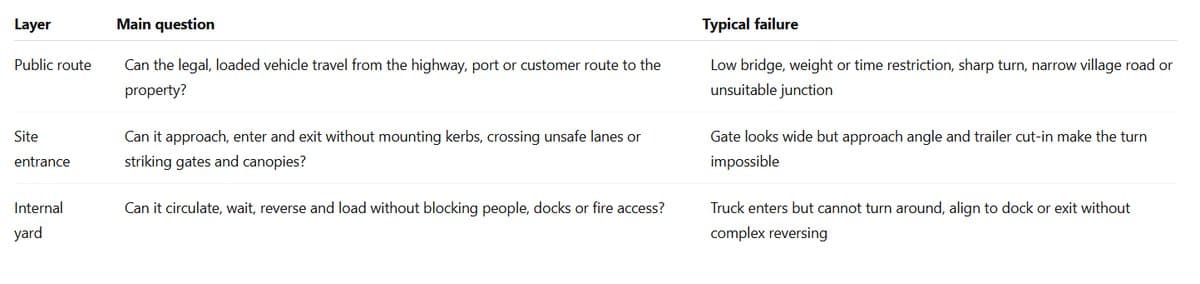

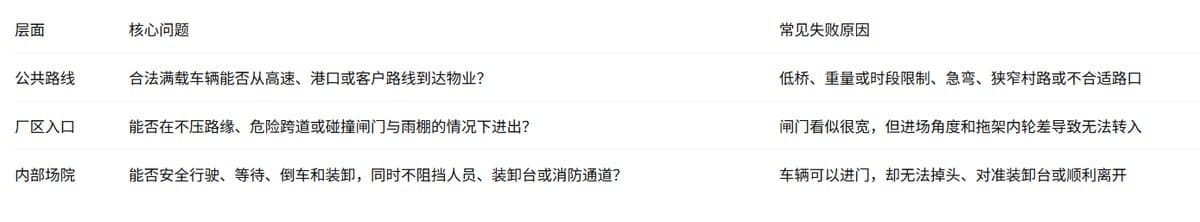

Three access layers must work together三个通行层面必须同时可行

News image
News image
Trace the whole route
Trace the whole route

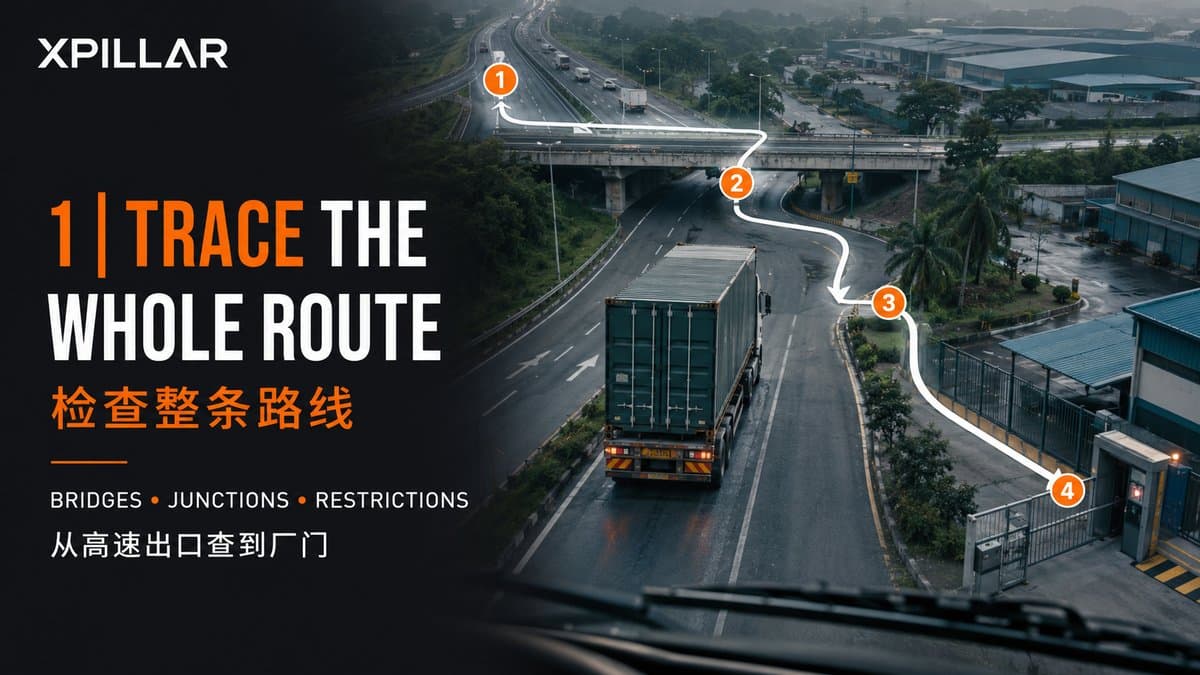

1. Trace the whole route—not just the map pin检查整条路线,不要只看地图定位
Create a route audit from the actual origin that matters: port gate, expressway interchange, customer facility, border crossing or logistics hub. Review both inbound and outbound directions because a turn that works on arrival may fail on departure.
从真正重要的起点开始建立路线检查:港口闸口、高速交流道、客户场所、边境或物流枢纽。进场和出场方向都要检查,因为到达时能转的弯,离开时不一定可行。

Public-route checklist
- expressway and toll-plaza approach;
- bridges, underpasses and overhead structures;
- posted weight, height, width, axle or vehicle-class restrictions;
- sharp bends, roundabouts and channelised junctions;
- median openings and U-turn locations;
- lane width and roadside parking;
- road shoulders, drains and weak edges;
- school, market, residential or village bottlenecks;
- local lorry prohibitions or operating-hour controls;
- flood-prone low points and alternative routes;
- construction diversions and recurring congestion;
- security checkpoints, port documentation or estate gates; and
- a safe fallback point if the truck cannot proceed.

公共路线检查表- 高速公路和收费站入口;
- 桥梁、地下通道及上方结构;
- 已设置的重量、高度、宽度、车轴或车辆类别限制;
- 急弯、回旋处及渠化路口;
- 中央分隔带缺口及U转位置;
- 车道宽度和路边停车;
- 路肩、排水沟和软弱边缘;
- 学校、市场、住宅区或村路瓶颈;
- 地方罗里禁令或营运时段限制;
- 易淹低洼路段及替代路线;
- 建筑改道和周期性拥堵;
- 保安检查站、港口文件或工业园闸门;
- 车辆无法继续时的安全退出点。

Repeat the route at the expected operating time. A road that looks clear on Sunday afternoon may be blocked by employee parking, school traffic, night-market activity or peak-hour restrictions on a weekday.
应在预计营运时间重新走一次路线。星期日下午看似畅通的道路,平日可能被员工停车、学校交通、夜市或繁忙时段限制影响。

Use current official signs and written confirmation from the relevant road, local or enforcement authority where a restriction is uncertain. Satellite images and map routing are screening tools, not proof that a legal loaded combination can pass.

如不确定限制,应按照现行官方路牌,并向相关道路、地方政府或执法机关取得书面确认。卫星图和地图导航只能用于初步筛查,不能证明合法满载车辆一定能通过

News image

2. Confirm the approved heavy-vehicle access context核实获批的重型车辆通行条件
Review the property's approved KM, site layout, road hierarchy, access point and loading/parking provision. Compare the approved plan with the actual entrance and yard. An owner may have moved a gate, built a guardhouse, covered a drain, added parking or extended a building into the manoeuvring area.
审查物业已批准的KM、总平面图、道路等级、出入口和装卸/停车安排,并把核准图与现场入口及场院比较。业主可能移动闸门、兴建保安亭、覆盖排水沟、增加停车位,或把建筑扩建到车辆操作区。

PLANMalaysia's official Planning Guideline for Parking, GP011(A) provides useful heavy-vehicle planning benchmarks. Among other matters, it says truck manoeuvring areas should follow JKR's relevant road-design guidance, discourages dead-end trailer parking, and indicates that large-truck and trailer facilities should preferably connect to a main road with an adequate reserve and dual carriageway. It also discusses a turning-circle provision where a trailer dead end cannot be avoided.
PLANMalaysia官方《停车场规划指南GP011(A)》提供重型车辆规划参考。指南说明罗里操作区应遵守JKR相关道路设计指南、不鼓励拖架使用尽头路,并指出大型罗里及拖架设施最好连接具有足够道路保留地及双车道的主路;当无法避免尽头路时,也讨论掉头圆的设置。
这些只是规划参考,并不能自动证明现有厂房合规或所有车辆都适用。仍须核实地方规划、KM、PBT要求和真实设计车辆。

These are planning benchmarks—not automatic confirmation that an existing factory complies or that every vehicle will fit. The applicable local plan, planning approval, PBT requirements and actual design vehicle must still be checked.
这些只是规划参考,并不能自动证明现有厂房合规或所有车辆都适用。仍须核实地方规划、KM、PBT要求和真实设计车辆。

News image

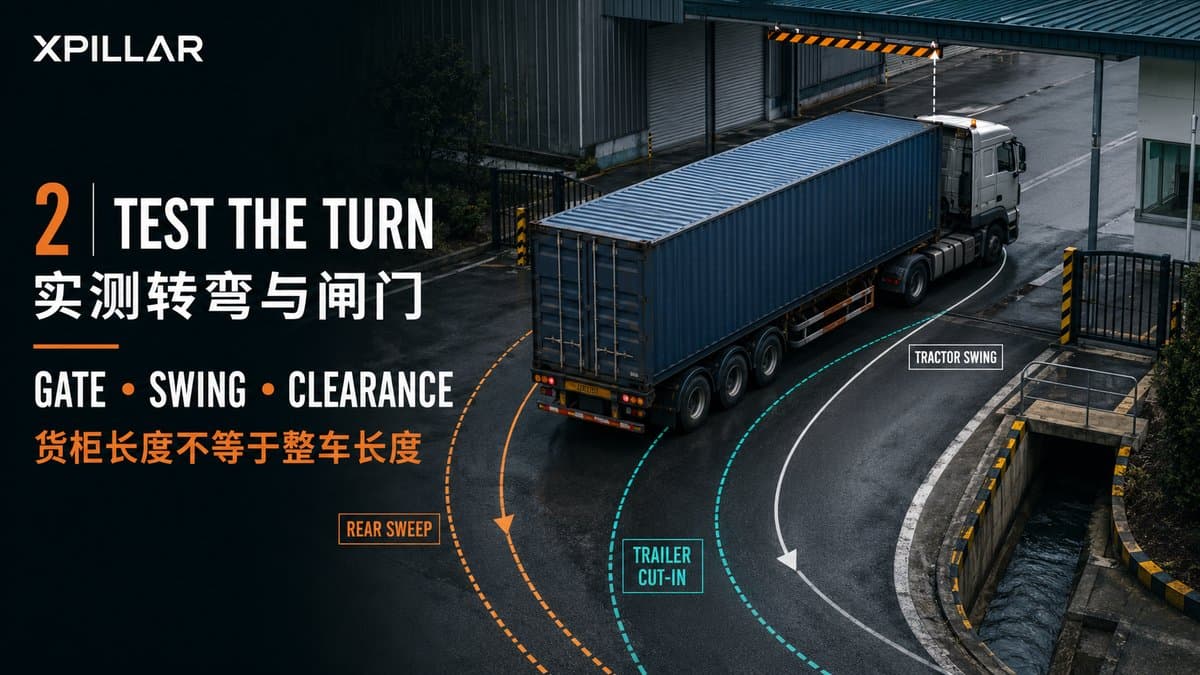

3. Test the gate approach and swept path实测闸门进场和车辆轨迹
The visible gate width is only one measurement. A professional access review should consider:
- approach direction and lane position before the turn;
- kerb-to-kerb and wall-to-wall opening;
- median, island, guardhouse and boom-gate position;
- tractor front swing;
- trailer inside cut-in;
- trailer rear sweep;
- opposing traffic and whether a turn crosses multiple lanes;
- roadside drains, culverts, kerbs and soft shoulders;
- gate-post, fence and sign clearances;
- gradient and crossfall at the entrance;
- visibility for the driver and road users; and
- whether the gate can remain fully open during the manoeuvre.

可见闸门宽度只是其中一个数字。专业通道评估应考虑:
- 转弯前的进场方向和车辆位置;
- 路缘之间及墙体之间的净开口;
- 中央分隔带、交通岛、保安亭及栏杆位置;
- 牵引车车头外摆;
- 拖架内轮差;
- 拖架尾部外摆;
- 对向交通,以及是否需要跨越多条车道;
- 路边排水沟、涵洞、路缘和软质路肩;
- 闸柱、围栏和招牌净空;
- 入口坡度和横坡;
- 驾驶员及其他道路使用者的视线;
- 操作期间闸门能否完全打开。

Where the margin is tight, commission a swept-path analysis based on a surveyed site plan and the actual vehicle profile. A drawing should show the complete inbound and outbound movement, not only the tractor centreline.
如果空间紧张,应按照实测场地图和真实车辆资料进行Swept Path车辆轨迹分析。图纸必须显示完整进出动作,而不只是牵引车中心线。

Why casual visual inspection fails
为什么只靠目测经常判断错误
A trailer does not follow the exact path of the prime mover. Its rear wheels cut inside the tractor's path, while the rear of the trailer can sweep outward. A driver may therefore clear the near gatepost but strike the opposite fence, guardhouse, canopy column or drain edge.

拖架不会完全跟随牵引车的路线。拖架后轮会切入牵引车路径内侧,而车尾可能向外摆动。驾驶员可能避开近侧闸柱,却撞到另一侧围栏、保安亭、雨棚柱或排水沟边缘。

4. Measure vertical clearance along the entire path测量整条路线的上方净空
Check operating height at every point, including:
- bridge and underpass approaches;
- overhead power and telecommunications lines;
- tree branches;
- gantries and signs;
- factory entrance canopies;
- guardhouse roofs and boom-gate frames;
- sprinkler, pipe or cable crossings;
- loading-bay shelters;
- indoor docks and warehouse doors; and
- changes in gradient that alter effective clearance.

每个位置都要检查操作高度,包括:
- 桥梁及地下通道入口;
- 架空电力和通讯线;
- 树枝;
- 龙门架和招牌;
- 厂区入口雨棚;
- 保安亭屋顶和栏杆框架;
- 消防管、工艺管或电缆跨越;
- 装卸台雨棚;
- 室内装卸位和仓库门;
- 会改变有效净空的坡度变化。

Measure the loaded vehicle's maximum operating height and apply an appropriate engineering and operational allowance. Do not rely on a single door-height figure in the listing. A high-cube container, trailer deck, suspension condition and road slope can change the effective clearance requirement.
测量满载车辆最高操作高度,并加入适当工程及营运余量。不要只相信房源广告中的门高。高柜、拖架平台、悬挂状态及路面坡度都会影响实际净空需求。

Any work near overhead electricity infrastructure should be reviewed with the relevant utility and qualified professionals; visual estimation from ground level is unsafe.
涉及架空电力设施的工程或操作,应与相关公用事业单位及专业顾问核实;从地面目测并不安全。

5. Check culverts, bridges, drains and pavement capacity检查涵洞、桥梁、排水沟和路面承载
A truck may physically fit but still overload the entrance structure or damage the yard. Identify:
- bridge or culvert capacity on the final approach;
- drain covers and entrance slabs;
- manholes within wheel paths;
- pavement construction and subgrade condition;
- settlement, rutting and broken edges;
- yard slab capacity under axle and landing-leg loads;
- dock leveller and dock structure ratings; and
- buried utilities beneath turning or waiting areas.

货柜车可能能够通过,却会压坏入口结构或场院。应确认:
- 最后路段的桥梁或涵洞能力;
- 排水沟盖板和入口板;
- 车轮路径内的检查井;
- 路面结构和地基状况;
- 沉降、车辙和破损边缘;
- 场院地坪在车轴及拖架支腿荷载下的能力;
- Dock Leveller及装卸台结构额定值;
- 转弯或等候区下方的地下设施。

Vehicle axle loads and wheel paths are different from a warehouse floor's uniform load rating. Ask a civil or structural engineer to assess uncertain bridges, culverts, slabs and covers using the actual loaded vehicle data.
车辆车轴荷载和轮迹,与仓库地面均布承重并不是同一件事。如桥梁、涵洞、地坪或盖板资料不确定,应让土木或结构工程师按照真实满载车辆数据评估。

6. Verify internal circulation and turnaround核实内部行车和掉头能力
Once inside, the vehicle should be able to reach its operating position without unsafe multi-point manoeuvres or blocking the only access road.
进入厂区后,车辆应能到达操作位置,而不需要危险的多次前后移动,也不会阻塞唯一通道。

Review:
- one-way versus two-way circulation;
- passing points;
- turning head or loop;
- reversing distance and blind zones;
- interaction with employee and visitor parking;
- temporary pallet, scrap or container storage;
- trailer-drop positions;
- forklift routes;
- emergency exits and assembly points;
- access to utility rooms and substations;
- future production expansion; and
- the peak number of simultaneous vehicles.

应检查:
- 单向还是双向行车;
- 会车位置;
- 掉头区或环形路线;
- 倒车距离和盲区;
- 与员工及访客停车位的冲突;
- 临时托盘、废料或货柜储存;
- 拖架停放位置;
- 叉车路线;
- 紧急出口和集合点;
- 公用设施房及变电站通道;
- 未来扩充生产线后的空间;
- 同一时间最高车辆数量。

Test the worst realistic condition, not an empty yard prepared for the property viewing. Include parked cars, staff shift changes, occupied bays, waste collection and peak inbound volumes.
应测试最差但真实的情况,而不是业主为看房特意清空的场院。把员工停车、换班、装卸台使用、垃圾收集和进货高峰纳入评估。

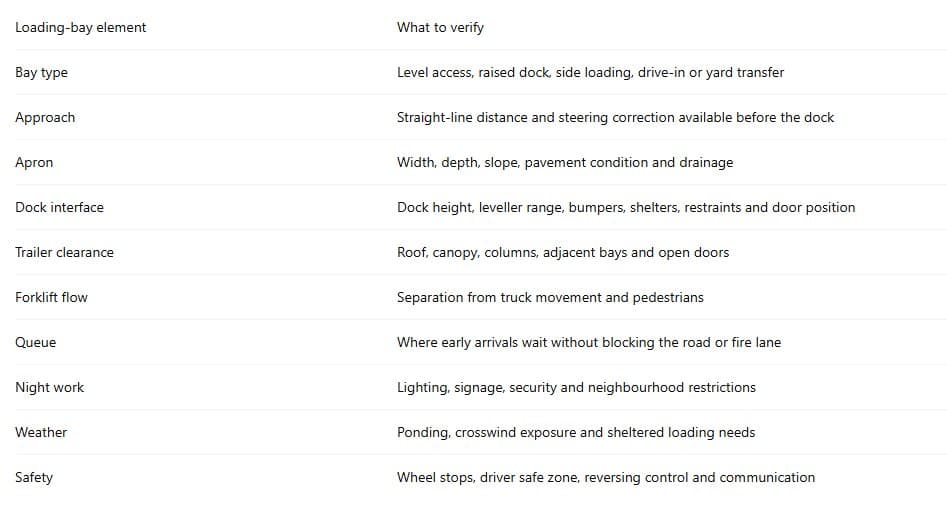

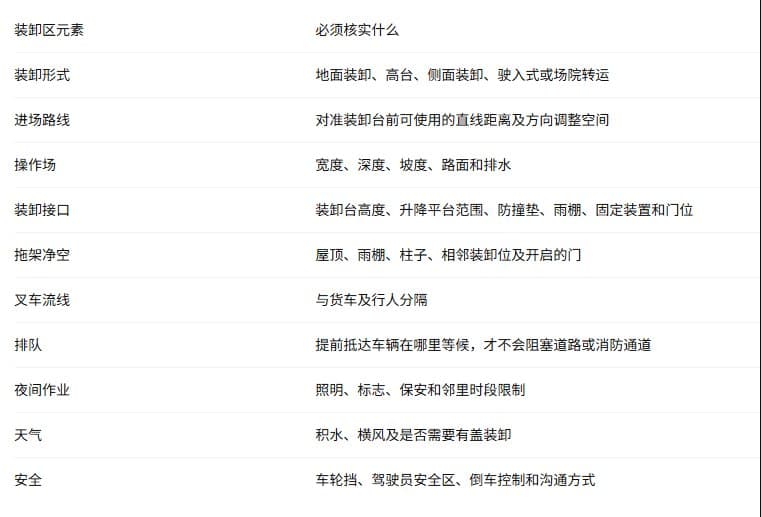

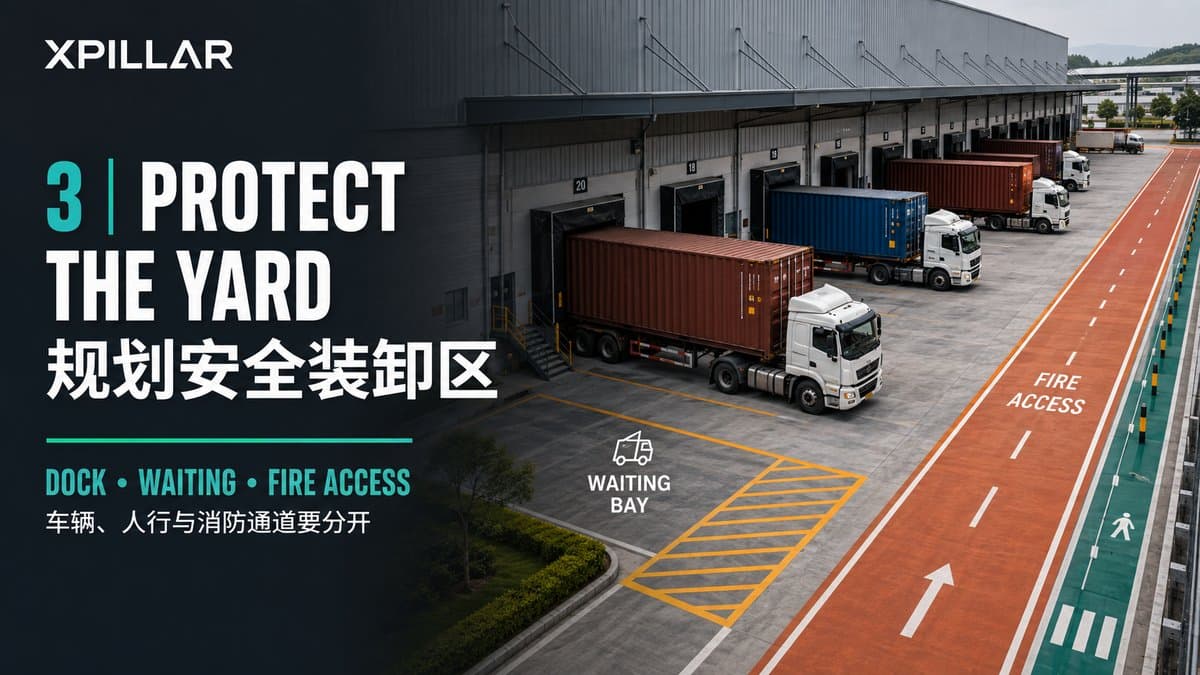

7. Review the loading bay as an operating system把装卸台当作完整操作系统

News image
News image

A truck reaching the yard is not useful if it cannot align to the required bay, if the apron floods, or if every loading operation blocks another tenant.如果无法对准装卸台、操作场经常积水,或每次装卸都会阻塞其他租户,即使货柜车能够进入也没有实际价值。

8. Protect pedestrians and loading crews保护行人与装卸人员
DOSH's official Vehicle Safety guidance identifies practical controls including separate worker and vehicle routes, adequate visibility, speed management, signs and markings, lighting, designated reversing areas, safe loading zones and keeping loading operations clear of unrelated workers. It also advises that loading and unloading be conducted on level ground and clear of overhead cables or pipes.
DOSH官方车辆安全指南提出多项实用措施,包括分隔车辆与人员路线、确保视线、管理车速、设置标志和地面线、照明、指定倒车区、安全装卸区,以及避免无关人员进入操作范围。指南也建议在平坦地面进行装卸,并远离架空电缆或管道。

For an operating factory or warehouse, assess:
- physical separation between people and vehicles;
- controlled crossing points;
- barriers at office and canteen exits;
- convex mirrors at blind corners;
- lighting at gates, yards and docks;
- reversing alarms, cameras or proximity systems;
- a trained banksman or signaler where required;
- driver waiting and toilet facilities;
- visitor induction and delivery instructions; and
- incident and near-miss reporting.

营运中的厂房或仓库应评估:
- 人车实体分隔;
- 受控过路点;
- 办公室和食堂出口防撞设施;
- 盲角凸面镜;
- 闸门、场院和装卸台照明;
- 倒车警报、摄像头或接近感应系统;
- 需要时的合格指挥员;
- 驾驶员等候及厕所设施;
- 访客安全说明和送货指引;
- 事故及险情记录。

The Occupational Safety and Health Act 1994, Act 514 imposes duties concerning safe workplaces, systems of work and access and egress. A property decision should allow the future operator to meet those duties in practice.
《1994年职业安全与健康法令Act 514》规定与安全工作场所、工作系统及安全进出有关的责任。选址时就应确保未来营运者实际能够履行这些责任。

9. Keep fire-appliance access clear保持消防车通道畅通

Container parking, queuing and loading must not obstruct required fire-engine access, hydrants, exits or fire-fighting installations. BOMBA's official Architectural Plan Submission
Checklist requires plans to show fire-appliance access in accordance with the Uniform Building By-Laws and to identify hydrant positions.
货柜车停车、排队和装卸不得阻塞规定的消防车通道、消防栓、紧急出口或消防设备。BOMBA官方建筑图呈交检查清单要求图纸按照统一建筑附例显示消防车通道,并标示消防栓位置。

Compare the approved fire-access route with current site use. Common problems include:
- trailers parked on the fire lane;
- pallets or scrap narrowing the route;
- new guardhouses or barriers obstructing access;
- container stacks reducing turning space;
- loading canopies built into the fire path; and
- gates locked or controlled without emergency access arrangements.

把核准消防通道与现场使用情况进行比较。常见问题包括:
- 拖架停在消防通道;
- 托盘或废料缩窄道路;
- 新保安亭或栏杆阻碍通行;
- 堆放货柜减少掉头空间;
- 装卸雨棚建进消防路线;
- 闸门上锁或没有紧急开启安排。

Where use, layout or building works are changing, have the fire-safety position reviewed by the qualified submitting person and BOMBA/PBT as applicable. Xpillar's guide to factory and warehouse fire compliance provides a broader fire due-diligence checklist.

如用途、布局或建筑工程发生变化,应由合资格呈交人士,并在适用时与BOMBA/PBT重新审查消防安全。XPillar的厂房与仓库消防合规指南提供更完整的消防尽调清单。

10. Run a controlled route and site trial进行受控路线及实车测试

When access is critical to the business, arrange a trial using the intended vehicle type, competent driver and controlled safety plan. Do not improvise a trial in live traffic without permission and traffic management.
如果货柜通行对企业非常重要,应使用拟定车型、合格驾驶员和安全控制计划安排测试。没有许可和交通管理时,不应在繁忙道路临时试车。

Trial protocol
1. confirm the vehicle and load condition;
2. choose a representative operating time;
3. obtain owner and site-management permission;
4. use spotters and temporary traffic control where necessary;
5. record inbound and outbound routes separately;
6. video the gate, critical turns and dock approach;
7. note kerb strikes, wheel encroachment, reversing corrections and waiting time;
8. repeat any movement affected by parked vehicles or another truck;
9. document overhead and structural clearances; and
10. obtain driver, safety and engineering feedback in writing.

测试步骤- 确认车辆和载重状态;
- 选择具代表性的营运时间;
- 取得业主及物业管理许可;
- 需要时安排指挥员和临时交通控制;
- 分开记录进场和出场路线;
- 拍摄闸门、关键转弯和装卸台进场;
- 记录压路缘、车轮越界、倒车修正和等待时间;
- 在有停车车辆或另一辆货车时重复相关动作;
- 记录上方及结构净空;
- 取得驾驶员、安全人员和工程顾问书面意见。

A successful empty-trailer trial does not automatically prove that the same movement is acceptable at the intended loaded weight. Structural and road restrictions still require separate verification.

空拖架成功测试,并不能自动证明相同路线适合满载车辆;满载重量、车轴荷载和结构限制仍须另外确认。

Evidence to obtain before signing- approved KM and site-layout plan showing access and parking;
- approved building plans and CCC;
- current official road and lorry restrictions for the intended route;
- actual haulier vehicle specifications;
- surveyed gate and yard measurements;
- swept-path analysis where margins are limited;
- engineer's review of culverts, bridges, yard slabs and dock structures where required;
- loading-bay drawings and equipment ratings;
- approved fire-appliance access plan;
- yard safety and traffic-management plan;
- records of current truck movements and complaints;
- trial-run photos, video and observation sheet;
- landlord or seller scope for access alterations; and
- authority approvals required for a new gate, widened access, culvert or yard modification.

签约前应取得的证据- 显示出入口和停车的已批准KM及总平面图;
- 核准建筑图及CCC;
- 拟定路线现行官方道路及罗里限制;
- 实际运输公司车辆规格;
- 实测闸门和场院尺寸;
- 空间紧张时的车辆轨迹分析;
- 需要时的涵洞、桥梁、场院地坪和装卸台工程评估;
- 装卸区图纸和设备额定值;
- 核准消防车通道图;
- 场院安全及交通管理计划;
- 目前货车流量及投诉记录;
- 试车照片、视频及观察表;
- 业主或卖家负责的通道改造范围;
- 新闸门、拓宽入口、涵洞或场院工程所需批准。

Contract protections for buyers and tenants买家和租户的合同保护

If container access is essential, do not describe the permitted use only as “warehouse” or “factory”. Consider recording the operational requirement and unresolved works in the offer, sale agreement or tenancy, with legal advice.
如果货柜通行是核心需求,许可用途不能只写成“仓库”或“厂房”。在取得法律意见后,可在要约、买卖协议或租约记录营运要求及未完成工程

Possible protections include:
- due diligence conditional on satisfactory container-truck access;
- permission to conduct surveys, swept-path analysis and vehicle trials;
- a defined design vehicle or agreed vehicle class;
- owner responsibility for approved gate, culvert, yard or dock works;
- landlord cooperation with PBT, BOMBA and utility submissions;
- an agreed completion standard and inspection;
- cost and maintenance allocation for shared access;
- controls against blocking common roads and fire lanes;
- termination or deposit-refund rights if essential approval is refused; and
- reinstatement obligations at lease expiry.

可考虑的保护包括:
- 交易以货柜车通行尽调满意为条件;
- 允许进行测量、车辆轨迹分析和实车测试;
- 列明设计车辆或约定车辆类别;
- 规定业主负责获批的闸门、涵洞、场院或装卸台工程;
- 业主配合PBT、BOMBA及公用事业申请;
- 约定完工标准和检查;
- 分配共用通道费用和维护责任;
- 禁止阻塞共用道路和消防通道;
- 关键批准被拒时终止交易或退还订金;
- 租约期满时的复原责任

Do not rely on a statement such as “40-footer can enter” without defining the route, vehicle, operating condition and evidence supporting it.

不要只依赖“40-footer可以进”这句话,而没有定义路线、车辆、操作状态和支持证据。

Red flags during a property viewing- the only proof is a photo of a container parked outside;- a truck can enter only by using the opposite lane or mounting a kerb;
- the gate is wide but the approach turn is extremely sharp;
- a covered drain or culvert has no capacity information;
- the trailer must reverse a long distance from a public road;
- the yard works only when employee cars are removed;
- there is no legal waiting area, so trucks queue on the roadside;
- the loading apron has deep rutting, settlement or ponding;
- overhead cables or a canopy have not been measured;
- a loading position blocks fire access or another tenant;
- the owner refuses a route trial or cannot provide approved plans; or
- the proposed solution needs road, gate or drainage works that are not in the budget.

看房时的警示信号- 唯一证据只是货柜停在厂外的照片;
- 货车必须使用对向车道或压上路缘才能进入;
- 闸门很宽,但进场转弯角度非常急;
- 覆盖排水沟或涵洞没有承载资料;
- 拖架必须从公共道路长距离倒车;
- 只有移走所有员工车辆后,场院才可操作;
- 没有合法等候区,货车只能在路边排队;
- 装卸场有严重车辙、沉降或积水;
- 架空电缆或雨棚高度没有测量;
- 装卸位置阻塞消防通道或其他租户;
- 业主拒绝试车或无法提供核准图;
- 解决方案需要道路、闸门或排水工程,但预算没有计算。

Final decision rule/  最终判断原则
A container-ready factory is not simply a property near a port or highway. It is a site where the actual legal vehicle can complete the public route, enter, turn, wait, load, exit and coexist safely with people and emergency access under realistic operating conditions.
真正适合货柜车的厂房,不只是靠近港口或高速公路,而是实际合法车辆能够在真实营运情况下完成公共路线、进入、转弯、等待、装卸、离开,并与行人及紧急通道安全共存的物业。

Measure and test before signing. A slightly higher rent at a genuinely workable site can cost less than daily reversing delays, vehicle damage, unsafe roadside queuing or a major access modification discovered after handover.
签约前先测量和测试。真正可以操作的物业,即使租金稍高,也可能比每天倒车延误、车辆损坏、路边危险排队或交付后才发现需要大型通道改造更便宜。

Explore factories and warehouses on Xpillar, then verify the complete truck movement before committing.

在XPillar浏览马来西亚厂房和仓库,并在承诺前核实完整货车路线。

Frequently asked questions/ 常见问题

A: Does “40-foot container access” mean every container truck can enter?“40尺货柜通行”是否代表所有货柜车都可以进入?Q: No. Vehicle configurations, wheelbases, overhangs, axle arrangements, heights and turning paths differ. Test the intended tractor-trailer combination and operating condition.
不是。车辆配置、轴距、悬长、车轴、高度和转弯轨迹不同。必须测试拟使用的牵引车、拖架组合及真实操作状态。

Q: Is the gate width enough to confirm access?
只量闸门宽度是否足够?A: No. The approach angle, tractor swing, trailer cut-in, rear sweep, road width, median, drains, gateposts and opposing traffic all affect the manoeuvre.
不足够。进场角度、车头外摆、拖架内轮差、车尾外摆、道路宽度、中间分隔带、排水沟、闸柱和对向交通都会影响转弯。

Q: Can Google Maps or satellite images confirm truck access?
Google Maps或卫星图可以确认货车通行吗?A: They are useful screening tools, but they do not reliably confirm current legal restrictions, bridge capacity, vertical clearance, parked vehicles, surface condition or swept path.
只能用于初步筛查,不能可靠确认现行法律限制、桥梁承载、上方净空、停车情况、路面状况或车辆轨迹。

Q: Should the route be tested with an empty or loaded truck?
应使用空车还是满载车辆测试?A: The trial should represent the real operation as closely and safely as possible. An empty trial can show geometry, but loaded weight, axle loads and structural restrictions require separate verification.
测试应在安全可行的情况下尽量代表真实营运。空车可显示几何路线,但满载重量、车轴负荷及结构限制仍须另外核实。

Q: Who should prepare a swept-path analysis?
谁应该准备车辆轨迹分析?A: A qualified transport, traffic, civil or other appropriate professional should use a surveyed layout and the actual design-vehicle data, especially where margins are tight or access changes need authority approval.
当空间有限或通道改造需要政府批准时,应由合资格交通、道路、土木或其他适当专业人士,按照实测图和真实设计车辆资料进行。

Q: Can trucks wait on the public road outside a factory?
货车可以在厂房外公共道路等候吗?A: Do not assume so. Parking and waiting must comply with road signs, local restrictions and safety requirements. The operation should provide a lawful waiting and call-forward plan.
不要自行假设。停车及等候必须符合路牌、地方限制和安全要求;营运方应提供合法等候和叫号进场安排。

Q: Can loading bays use the fire-access lane when no emergency is happening?
没有火灾时,装卸区可以占用消防通道吗?A: Required fire-appliance access, hydrants and emergency routes should remain unobstructed according to the approved fire strategy and applicable requirements. Confirm the site-specific arrangement with qualified professionals and authorities.
规定的消防车通道、消防栓和紧急路线应按照核准消防策略及适用规定保持畅通。应由合资格专业人士及相关机关确认现场安排。

Official primary sources used

1. PLANMalaysia — Planning Guideline for Parking, GP011(A)
2. PLANMalaysia — Official Planning Guidelines Directory
3. JPJ — Weight Certificate Vehicle-Specification Guidance
4. Ministry of Transport — Road Transport Act 1987, Act 333
5. DOSH — Vehicle Safety Guidance
6. DOSH — Occupational Safety and Health Act 1994, Act 514, reprint version 1 June 2024
7. BOMBA — Architectural Plan Submission Checklist
8. APAD — Freight operator licensing and goods-vehicle permits

Editorial note: This article was checked against official sources available on 5 August 2026. Road restrictions, vehicle specifications, planning standards and local-authority requirements vary by route, vehicle, property and jurisdiction. This is a general industrial-property due-diligence guide, not engineering, traffic, legal or safety approval.
