A practical decision framework for the operational brief, land control, rent and capital cost, approvals, construction, acceptance, delay protection and exit strategy.

Sep 4, 2026
uild-to-Suit Factory in Malaysia: Should a Manufacturer Rent a Custom-Built Facility or Buy Land and Build? | 马来西亚订制厂房:制造商应租用Build-to-Suit厂房,还是买地自建?

A build-to-suit factory can reduce a manufacturer's upfront property capital and deliver a facility designed around production—but only when the technical brief, land, approvals, cost allocation, handover tests and long-term lease are aligned before construction starts.

Answer first/ 先说结论
A build-to-suit (BTS) factory can be an effective Malaysian expansion model when a manufacturer needs a specialised facility but prefers to keep capital available for machinery, technology, inventory and working capital.
当制造商需要专业厂房,却希望把资本保留给机器、技术、库存及营运资金时,Build-to-Suit(BTS)订制厂房可以成为有效的马来西亚扩张模式。

A developer or landowner controls the land, funds and delivers an agreed building, and the manufacturer commits to a long-term lease or another structured occupancy arrangement.
发展商或地主控制土地、出资并交付约定建筑,而制造商承诺长期租赁或采用另一种结构化使用安排。

However, BTS is not simply “tell the landlord what factory you want and start paying rent when it is ready.”
但是,BTS并不是“告诉房东想要什么厂房,建好以后才开始付租金”这么简单。

It is a property-development contract, a construction-delivery programme and a long-term operating commitment combined.
它同时包含房地产开发合同、施工交付计划及长期营运承诺。

The model works only when six items are aligned before major spending begins: the operating brief, suitable land, approval pathway, capital-and-rent formula, acceptance tests, and remedies if delivery or performance fails.
只有在大额支出开始前,把六项事项全面对齐,模式才真正可行:营运需求书、适合土地、审批路径、资本与租金公式、验收测试,以及交付或性能失败时的补救安排。

The most important decision is not whether BTS is cheaper on day one.
最重要的决策,不是BTS在第一天是否更便宜。

It is whether the chosen structure gives the manufacturer the lowest risk-adjusted cost of reaching stable production within its required timeline.
而是所选结构能否让制造商在目标期限内,以最低的风险调整后成本实现稳定投产。

Scope note: This article provides general industrial-property information, not legal, tax, accounting, engineering or regulatory advice.

适用范围说明: 本文提供一般工业地产信息,不构成法律、税务、会计、工程或监管意见。

Requirements vary by project, activity, state and local authority.

具体要求会因项目、生产活动、州属及地方政府而异。

Appoint Malaysian legal counsel, architects, engineers, quantity surveyors, tax advisers and relevant authorities or utility professionals for the actual transaction.

实际交易应聘请马来西亚律师、建筑师、工程师、工料测量师、税务顾问及相关政府或公用事业专业人士。

What exactly is a build-to-suit factory?
Build-to-Suit订制厂房究竟是什么?

In a genuine BTS transaction, the occupier's confirmed operating requirements materially shape the building before it is constructed or extensively redeveloped.
真正的BTS交易,是在新建或大规模改造以前,由使用者已经确认的营运需求实质影响建筑设计。

These requirements may include clear height, column grid, floor loading, crane beams, dock configuration, clean areas, temperature control, process water, power, compressed air, gas, wastewater treatment, fire strategy, employee facilities and expansion space.
这些要求可包括净高、柱距、地面承重、天车梁、装卸台配置、洁净区域、温控、生产用水、电力、压缩空气、天然气、废水处理、消防策略、员工设施及扩建空间。

A normal new warehouse with optional tenant fit-out is not automatically BTS.
一座普通新仓库加上可选择的租户装修,并不会自动成为BTS。

The distinction matters because a highly customised building may have lower value to the next occupier.
区别非常重要,因为高度订制的建筑对下一位租户的价值可能较低。

The developer will normally price that re-letting risk into rent, lease length, security deposit, guarantees or ownership of specialised improvements.
发展商通常会把重新出租风险计入租金、租期、保证金、担保或专用改良设施的所有权安排。

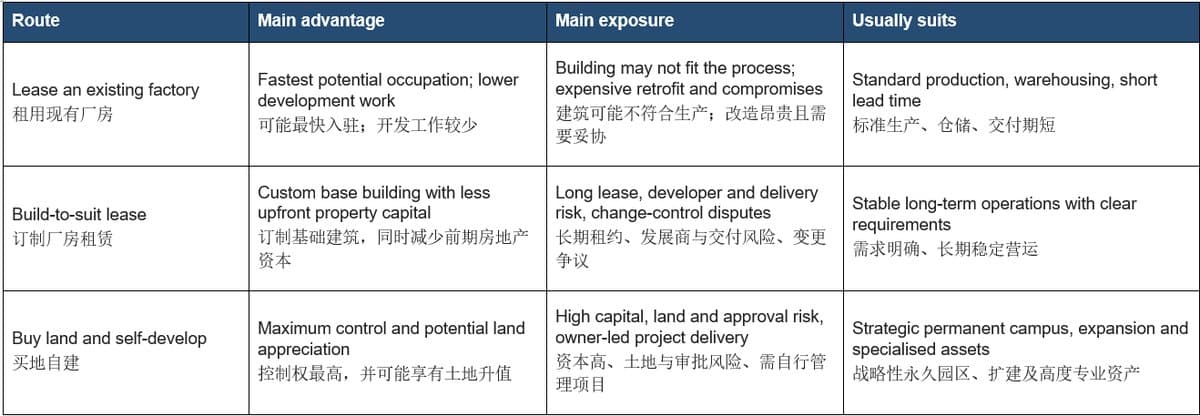

Compare three expansion routes before selecting BTS
选择BTS以前先比较三种扩张方式

Article image

The correct comparison should include the same time horizon and the same facility specification.
正确比较必须采用相同持有期及相同设施规格。

Comparing BTS rent for a compliant, fully serviced factory with the purchase price of bare land produces a misleading answer.
把一座合规、基础设施齐全的BTS厂房租金,与一块裸地购买价格直接比较,会产生误导结果。

Article image

1. Freeze the operating brief before pricing the building
在厂房定价前冻结营运需求书

The manufacturer's brief is the commercial foundation of the deal.
制造商的需求书是整个交易的商业基础。

“Approximately 200,000 square feet with 5 MW of power” is not enough.
“约20万平方英尺、需要5MW电力”远远不足。

The brief should translate the production plan into measurable property requirements:
需求书必须把生产计划转换成可测量的物业要求:

- production flow, equipment footprints and maintenance clearances;
生产流程、设备占地及维修空间;
- floor loading, vibration limits, pits, foundations and crane loads;
地面承重、振动限制、地坑、设备基础及天车荷载;
- clear height, column grid, mezzanine and future expansion modules;
净高、柱距、夹层及未来扩建模块;
- peak and phased power demand, voltage, redundancy and energisation date;
高峰及分期电力需求、电压、冗余与通电日期;
- water balance, pressure, storage, process discharge and treatment;
水量平衡、水压、储水、生产排放及处理;
- loading docks, container route, yard depth, parking and security;
装卸台、货柜路线、操作场地深度、停车及保安;
- fire-risk classification, hazardous materials and emergency response;
火灾风险类别、危险物料及紧急应变;
- workforce, shifts, canteen, surau, changing and transport needs; and
员工人数、班次、食堂、祈祷室、更衣及交通需求;以及
- target trial-production date and stable-production date.
试产日期及稳定投产日期。

Each requirement should be marked mandatory, target or optional.
每项要求应标明为强制、目标或可选。

Without this priority ranking, value engineering can quietly remove an item that operations considered essential.
如果没有优先级,价值工程可能在不知不觉中删除营运团队认为不可缺少的项目。

2. Verify the land before committing to the building 承诺建筑以前先核实土地

A strong design cannot cure unsuitable land.
再好的设计也无法补救不适合的土地。

Before the tenant signs an unconditional long-term commitment, the parties should verify title, tenure, land-use conditions, restrictions, planning context, legal access, flood and platform risk, ground conditions, utility corridors and the developer's legal control of the site.
在租户作出无条件长期承诺以前,双方应核实地契、年限、土地用途条件、利益限制、规划环境、合法出入口、洪水与地台风险、土质、公用设施走廊,以及发展商对土地的合法控制权。

The occupier should understand whether the developer already owns the land, holds an option, is negotiating a joint venture, or depends on a future subdivision.
使用者应了解发展商是否已经拥有土地、只是持有购买选择权、仍在洽谈合资,或依赖未来土地分割。

A BTS offer supported only by a site photograph and conceptual plan exposes the tenant to land risk it may not control.
如果BTS建议只有现场照片及概念图,租户就可能承担自己无法控制的土地风险。

The commercial documents should identify a land-control milestone and require evidence before design or deposit obligations become fully committed.
商业文件应设立土地控制里程碑,并要求在设计费用或订金责任完全生效以前提供证明。

Article image

3. Build one transparent cost and rent model 建立一套透明的成本与租金模型

BTS rent is often presented as one monthly rate, but the economics usually contain several layers.
BTS租金常以一个月租率呈现,但实际经济结构通常包含多个层次。

Separate them so both parties understand what is being priced:
应把它们分开,让双方清楚了解每项价格的内容:

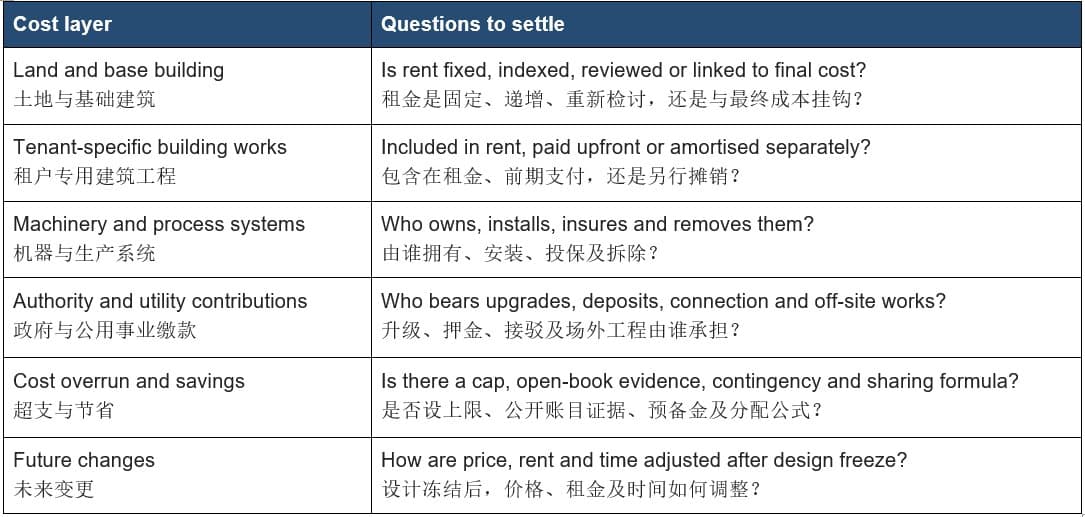

Article image

Model total occupancy cost across the firm lease term, including rent, service or estate charges, taxes allocated by contract, maintenance, insurance, utilities, tenant capital, financing cost, reinstatement and the residual value of improvements.
应按固定租期计算总使用成本,包括租金、服务或园区费用、合同分配的税费、维修、保险、公用事业、租户资本、融资成本、恢复原状及改良设施剩余价值。

Then compare it with the same items under land purchase and self-development.
然后与买地自建下的同类项目比较。

4. Convert the technical brief into a responsibility matrix 把技术需求书转换成责任矩阵
Every system needs a named designer, payer, owner, approval applicant, tester and long-term maintainer.
每套系统都必须明确设计者、付款方、所有者、审批申请人、测试者及长期维护者。

A clear matrix should cover at least structure, roof, slab, docks, lifts, cranes, electrical supply, transformers, standby power, solar, water, process drainage, sewerage, fire systems, HVAC, compressed air, gas, telecommunications, security and landscaping.
责任矩阵至少应涵盖结构、屋顶、地坪、装卸台、电梯、天车、电力供应、变压器、备用电源、太阳能、供水、生产排水、污水、消防、空调、压缩空气、天然气、通信、保安及绿化。

Do not use “landlord works” and “tenant works” as the only definition.
不要只用“房东工程”和“租户工程”作为定义。

Interfaces create most disputes.
多数争议都发生在接口位置。

For example, the developer may provide a transformer while the tenant supplies machinery cabling; the documents must identify metering point, harmonic control, protection coordination, testing and energisation responsibility.
例如,发展商可能提供变压器,而租户安装机器电缆;文件必须说明计量点、谐波控制、保护协调、测试及通电责任。

5. Run approvals and operating licences as one programme 把开发审批与营运执照作为同一计划管理

Planning, building and infrastructure approvals do not automatically authorise the manufacturer's business activity.
规划、建筑及基础设施批准,并不会自动批准制造商的商业活动。

Likewise, an investment or manufacturing approval does not mean the building is ready for occupation.
同样,投资或制造批准也不代表建筑已经可以入驻。

Malaysia's OSC 3.0 Plus system supports local-authority submissions, while the exact checklist and sequence remain local-authority and project specific.
马来西亚OSC 3.0 Plus系统支持地方政府呈交,但具体清单及次序仍取决于地方政府与项目。

CIDB states that local and foreign contractors must register before undertaking construction work in Malaysia unless exempted under the legislation.
CIDB说明,除非依法获得豁免,本地及外国承包商在马来西亚进行建筑工程前都必须注册。

For the manufacturer, MIDA's current Manufacturing Licence guideline states that a company engaging in manufacturing with shareholders' funds of RM2.5 million or more, or 75 or more full-time paid employees, must apply for a Manufacturing Licence.
对于制造商,MIDA现行制造执照指南说明,从事制造活动的公司,如果股东资金达到250万令吉或以上,或拥有75名或以上全职有薪员工,就必须申请制造执照。

Qualifying smaller companies may apply for exemption confirmation.
符合条件的较小公司可申请豁免确认。

Environmental screening should be activity specific.
环境筛选必须针对实际生产活动。

An industrial title or a developer's past approval is not a substitute for checking the incoming process.
工业用途地契或发展商过去取得的批准,不能取代对新生产流程的核实。

6. Define what “ready” means 清楚定义“建好”是什么意思
The parties should not use one vague handover date for every obligation.
双方不应使用一个模糊的移交日期涵盖所有责任。

A reliable programme distinguishes/ 可靠计划应区分:
- land and design release;
土地及设计放行;
- authority submission and approval milestones;
政府呈交及批准里程碑;
- site possession and construction start;
交地及开工;
- structure and weather-tight completion;
结构及防风雨完成;
- utility infrastructure completion;
公用设施基础工程完成;
- CCC or other relevant occupancy documentation;
CCC或其他相关入驻文件;
- base-building testing and commissioning;
基础建筑测试与调试;
- tenant fit-out access;
租户装修进场;
- integrated testing with production systems; and
与生产系统综合测试;以及
- beneficial occupation, trial production and rent commencement.
实际使用、试产及租金起算。

A CCC is important evidence for the building, but it is not proof that the factory can achieve the tenant's production output, utility stability or process performance.
CCC是建筑的重要证明,但不能证明厂房一定能达到租户的生产产量、公用设施稳定性或工艺性能。

Acceptance schedules should state measurable criteria, test method, witness rights, documents, training, defect classification and retest procedure.
验收附件应列明可测量标准、测试方法、见证权、文件、培训、缺陷分类及重新测试程序。

7. Protect both sides against delay  为双方设置延误保障
The manufacturer may have machinery shipments, customer contracts, workforce relocation and an expiring existing lease tied to the new factory.
制造商可能已经安排机器到货、客户合同、员工迁移,并面对现有租约到期。

The developer may depend on approvals, utility agencies, imported materials and timely tenant decisions.
发展商则依赖政府审批、公用事业机构、进口材料及租户及时决策。

The contract must therefore separate/ 因此,合同必须区分:
- developer delay;
发展商延误;
- tenant-caused delay or late information;
租户造成的延误或资料迟交;
- authority or utility delay outside reasonable control;
合理控制范围以外的政府或公用事业延误;
- force majeure and material supply disruption; and
 不可抗力及重大材料供应中断;以及
- concurrent delay involving more than one cause.
多项原因同时发生的延误。

Agree notice requirements, evidence, mitigation, extension-of-time rules, interim access, rent commencement, liquidated damages where legally appropriate, long-stop termination and treatment of tenant equipment already delivered.
双方应约定通知要求、证明、减损、工期延长规则、提前进场、租金起算、在法律允许下的约定赔偿、最终期限终止权,以及已送达租户设备的处理。

Article image

8. Control design changes after the freeze 控制设计冻结后的变更

Changes are normal in an industrial project; uncontrolled changes are not.
工业项目出现变更很正常,但不受控制的变更并不正常。

Every variation should identify who requested it, technical effect, cost, rent adjustment, programme impact, authority resubmission and ownership at lease expiry.
每项变更都应说明提出者、技术影响、成本、租金调整、工期影响、是否需要重新呈交,以及租约结束时的所有权。

Create approval thresholds so site teams can resolve minor matters while major cost, time or performance changes require authorised executives.
应设置批准门槛,让现场团队可以处理小事项,而重大成本、工期或性能变更则必须由获授权高层批准。

China-based headquarters should nominate a Malaysia decision team with clear authority.
中国总部应指定拥有明确权限的马来西亚决策团队。

Waiting several weeks for overseas approval can become a tenant delay.
如果每项决定都要等待海外批准数周,可能构成租户延误。

9. Align lease length, funding and security 对齐租期、融资与担保

A developer funding a specialised building needs sufficient contracted income to recover capital.
为专业建筑提供资金的发展商,需要足够合同收入回收资本。

A manufacturer installing expensive machinery needs enough secure occupation to recover relocation and fit-out costs.
安装昂贵机器的制造商,也需要足够稳定使用期回收搬迁及装修成本。

The firm lease term, renewal options and termination rights should therefore match the economic life of both investments.
因此,固定租期、续租选择权及终止权,应配合双方投资的经济寿命。

Discuss early whether security will be a cash deposit, bank guarantee, parent-company guarantee, letter of credit or combination.
双方应尽早讨论担保形式,是现金保证金、银行担保、母公司担保、信用证或组合方式。

Also address what happens if the developer refinances or sells the property.
还要处理发展商再融资或出售物业时的安排。

10. Plan maintenance, expansion and exit before handover 移交以前规划维修、扩建与退出

The lease should separate structural and base-building maintenance from production systems and tenant equipment.
租约应把结构及基础建筑维修,与生产系统及租户设备分开。

It should also identify service levels for critical utilities, response times, lifecycle replacement, insurance, access for repairs and responsibility for defects discovered after occupation.
还应说明关键公用设施服务水平、响应时间、生命周期更换、保险、维修进场权及入驻后发现缺陷的责任。

Future expansion rights should not remain as a marketing promise.
未来扩建权不能只停留在营销承诺。

Identify the reserved land, option period, expansion trigger, design standard, pricing method, shared infrastructure and consequences if the developer uses the land for another customer.
应明确保留土地、选择权期限、扩建触发条件、设计标准、定价方式、共用基础设施,以及发展商把土地用于其他客户时的后果。

At exit, decide whether specialised improvements stay, transfer for value, or must be removed.
退出时,应决定专用改良设施是保留、有偿转移,还是必须拆除。

Reinstatement language should distinguish normal wear, landlord-funded works, tenant-funded systems, hazardous contamination and alterations approved as permanent.
恢复原状条款应区分正常损耗、房东出资工程、租户出资系统、危险污染,以及已经批准为永久设施的改动。

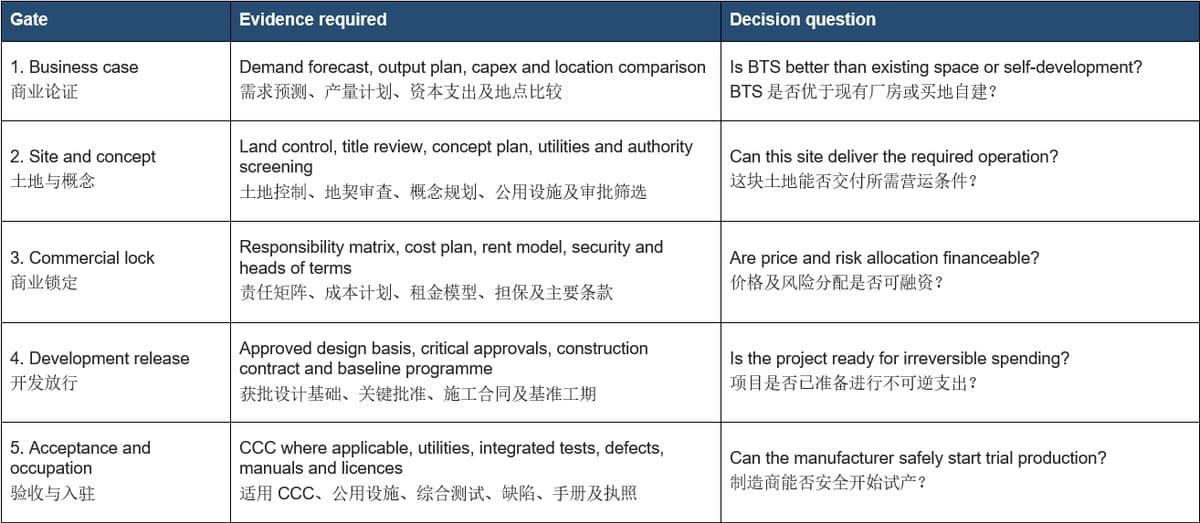

Five decision gates before a manufacturer commits
制造商承诺以前的五个决策关口

Article image

These gates allow the parties to spend progressively.
这些关口让双方分阶段投入。

A letter of intent can reserve a site, but it should not force both sides into full exposure before land, design, cost and approval evidence is ready.
意向书可以保留土地,但在土地、设计、成本及审批证据准备好以前,不应让双方承担全部风险。

Special advice for China-based manufacturers
给中国制造企业的特别建议

Do not send only a Chinese factory drawing and ask a Malaysian developer to reproduce it.
不要只把中国工厂图纸交给马来西亚发展商并要求照样复制。

Translate the operation into a bilingual technical brief that identifies Malaysian codes, local authority interfaces, metric specifications, equipment certification, utility quality and approval ownership.
应把营运要求转换成双语技术需求书,明确马来西亚规范、地方政府接口、公制规格、设备认证、公用设施质量及审批责任。

Create one controlled bilingual glossary for critical terms.
应为关键术语建立一份受控双语词汇表。

“Completion”, “power available”, “production-ready”, “heavy floor” and “clean area” can mean different things to operations, developers and contractors.
“完工”“电力可用”“可投产”“重型地坪”及“洁净区域”,对营运团队、发展商与承包商可能有不同含义。

Define them through measurable criteria, not translation alone.
必须用可测量标准定义,而不只是翻译。

Finally, align headquarters approvals with the Malaysian programme.
最后,总部审批必须配合马来西亚项目进度。

Nominate authorised decision-makers, set response deadlines and hold joint design, cost and risk reviews.
应指定获授权决策者、设置回复期限,并共同进行设计、成本及风险审查。

Fast construction cannot compensate for slow decisions.
施工再快,也无法弥补决策缓慢。

Final perspective
最后观点

Build-to-suit is most valuable when it converts a manufacturer's operating requirements into a bankable property solution without forcing the manufacturer to become a property developer.
BTS最有价值的地方,是把制造商的营运需求转化为可融资的物业方案,而不必让制造商自己成为房地产发展商。

It fails when the parties sign a long lease around a concept image and postpone the difficult questions until construction.
若双方只围绕概念图签署长期租约,并把困难问题推迟到施工阶段,项目就容易失败。

Choose BTS when the process is clear, the land is credible, the cost is transparent, the acceptance tests are measurable and the remedies are usable.
只有当生产需求清楚、土地可信、成本透明、验收标准可测量,并且补救措施真正可用时,才选择BTS。

Otherwise, an existing factory or owner-developed campus may produce a better risk-adjusted result.
否则,现有厂房或买地自建园区,可能带来更好的风险调整后结果。

Frequently Asked Questions
常见问题

1. Is a build-to-suit factory always cheaper than buying land and building? 订制厂房一定比买地自建便宜吗?
No. 不一定。

BTS can reduce upfront property capital, but rent normally prices land, construction, financing, risk and return.
BTS可以降低前期房地产资本,但租金通常包含土地、建筑、融资、风险及回报。

Compare total occupancy cost, flexibility, delivery risk and residual value over the same period and specification.
应在相同期间及规格下,比较总使用成本、灵活性、交付风险及剩余价值。

2. When should rent start?  租金应该何时开始计算?
The documents should define the trigger precisely. 文件应精确定义触发条件。

It may depend on agreed occupancy documentation, utility availability, base-building completion, acceptance testing, access and the treatment of minor defects—not merely the developer declaring completion.
可取决于约定入驻文件、公用设施可用、基础建筑完成、验收测试、进场条件及轻微缺陷处理,而不能只由发展商单方面宣布完工。

3. Who pays for tenant-specific factory improvements? 租户专用厂房改良由谁支付?
It is negotiable. 可以协商。

The developer may include approved items in rent, the tenant may pay directly, or costs may be shared.
发展商可把获批项目计入租金,租户也可直接支付,或双方分担。

The agreement must identify cost caps, ownership, maintenance, insurance and end-of-lease treatment.
协议必须说明成本上限、所有权、维修、保险及租约结束时的处理。

4. Does CCC mean the BTS factory is production-ready? 获得CCC是否代表BTS厂房已经可以投产?
No. 不代表。

CCC concerns building completion and compliance within its applicable framework.
CCC涉及适用框架下的建筑完工与合规。

Production readiness may also require utilities, machinery installation, integrated testing, activity licences, environmental controls, fire requirements, staff and operating procedures.
投产还可能需要公用设施、机器安装、综合测试、活动执照、环境控制、消防要求、员工及营运程序。

5. Can a foreign manufacturer use a BTS factory in Malaysia? 外资制造商可以在马来西亚使用BTS厂房吗?
Potentially, subject to the company's investment, manufacturing, immigration, customs, tax, property, planning, environmental and sector requirements.
可以,但须符合公司的投资、制造、移民、关税、税务、房地产、规划、环境及行业要求。

The property structure does not replace operating approvals.
物业结构不能取代营运审批。

6. What happens if the factory is delivered late? 如果厂房延迟交付怎么办?
The contract should allocate causes of delay, notice and evidence requirements, mitigation, extension of time, rent commencement, interim access, applicable damages, long-stop termination and treatment of machinery or deposits.
合同应分配延误原因、通知及证明要求、减损、工期延长、租金起算、提前进场、适用赔偿、最终期限终止,以及机器或订金处理。

The answer should be agreed before construction starts.
这些答案应在开工前约定。
