Near an ECRL Station? 11 Checks Before Buying Industrial Land in Malaysia | 靠近ECRL车站不等于可以直接使用铁路货运:购买沿线工业土地前的11项检查

Rail proximity can strengthen an industrial site—but only when the freight terminal, operating date, first and last mile, land use and total logistics cost are verified.

Aug 19, 2026
Near an ECRL Station? 11 Checks Before Buying Industrial Land in Malaysia |  靠近ECRL车站不等于可以直接使用铁路货运:购买沿线工业土地前的11项检查

ECRL proximity is not the same as freight access. This practical bilingual guide explains the 11 checks industrial land buyers should complete before pricing a rail-location premium into a Malaysian site.

Near an ECRL Station? 11 Checks Before Buying Industrial Land in Malaysia
靠近ECRL车站不等于可以直接使用铁路货运:购买沿线工业土地前的11项检查
Answer first
先说结论

Land near the East Coast Rail Link (ECRL) may gain a strategic logistics advantage, but distance to the railway or station alone does not prove that a factory, warehouse or industrial park can use rail freight. A serious buyer should verify the station's cargo function, the relevant section's commercial operating date, terminal access arrangements, the actual truck route, handling capability, land-use approvals, utilities and the complete door-to-door logistics cost.
靠近东海岸铁路(ECRL)的工业土地,未来可能具备更好的物流战略价值;但距离铁路或车站很近,并不代表工厂、仓库或工业园可以直接使用铁路货运。买方必须进一步核实车站是否具备货运功能、相关路段何时商业运营、货站接入安排、实际货车路线、装卸能力、土地用途、基础设施,以及完整的门到门物流成本。

As at 19 August 2026, Malaysia Rail Link reported that the 665-kilometre ECRL had reached 94% overall construction progress as of May 2026. The Kota Bharu–Gombak section is scheduled to begin commercial operations in January 2027. The Gombak–Port Klang connection is scheduled for completion in December 2027 and full operation in January 2028. These are important national milestones, but they are not a substitute for project-specific due diligence.
截至2026年8月19日,马来西亚铁路衔接公司(MRL)公布,ECRL全长665公里,整体工程截至2026年5月已完成94%。哥打峇鲁至鹅唛路段计划于2027年1月投入商业运营;鹅唛至巴生港连接线计划于2027年12月完工,并于2028年1月全面运营。这些都是重要的国家级进度,但不能取代每一宗工业地产交易的专项尽职调查。

The practical rule: Treat “near ECRL” as a location lead. Treat freight access as proven only after the route, terminal, operating terms and economics are documented.

实务原则: “靠近ECRL”只能视为选址线索。只有当线路、货站、运营条件和经济账都有文件支持时,才可以把铁路货运接入视为已证实。

Why ECRL matters to industrial-property buyers
为什么ECRL值得工业地产买家关注

ECRL is designed for both passenger and freight services and links Kelantan, Terengganu and Pahang with Selangor. Its western connection is intended to reach Port Klang, while Section D includes a 25-kilometre double-track connection from Jalan Kastam to Northport and Westports.

ECRL同时规划客运与货运,连接吉兰丹、登嘉楼、彭亨与雪兰莪。西端将连接巴生港,而D段包括从Jalan Kastam至北港和西港的25公里双轨连接。

For manufacturers, distributors and China-linked supply chains, the opportunity is clear: a viable rail option may diversify transport routes, support larger recurring cargo flows and improve access between east-coast production locations and west-coast ports. However, the value is operational—not merely geographic.

对制造商、分销商和中资供应链企业来说,潜在价值在于增加运输选择、支持稳定的大批量货流,并加强东海岸生产基地与西海岸港口之间的联系。但是,价值来自实际运营条件,而不是地图上的距离。

A plot ten kilometres from a usable freight terminal can be more useful than land beside a passenger station with no cargo handling.

距离可用货站10公里、但货车通行顺畅的土地,可能比紧靠一个纯客运站的土地更有价值。

Current ECRL timeline: use the right date in your feasibility study
当前ECRL时间表:可行性分析必须采用正确日期

Article image

Project programmes can change. Buyers should re-check the latest official information immediately before signing, financing or committing capital expenditure.
项目时间表仍可能调整。签约、融资或投入资本开支之前,应再次查阅最新官方资料。

The 11 checks before buying industrial land near ECRL
购买ECRL沿线工业土地前的11项检查

Article image

1. Confirm the station's actual function 先确认车站的实际功能

Ask whether the nearby facility is a passenger station, freight station, interchange, depot, future facility or a station with both functions.
要弄清附近设施到底是客运站、货运站、换乘站、车厂、未来规划设施,还是兼具客货功能的车站。

A passenger station is not evidence of container handling, bulk loading, dangerous-goods acceptance or warehouse access.
客运站并不能证明当地可以处理集装箱、散货、危险品或仓储作业。

Obtain the latest official station information and identify the party responsible for commercial freight enquiries.
应取得最新官方车站资料,并确认哪一方负责商业货运咨询。

2. Verify the relevant commercial operating date  核实与实际路线相关的商业运营日期
“The railway opens in 2027” is too broad for an investment model. The eastern section and the Port Klang connection have different milestones.
“铁路2027年开通”这个说法过于笼统。东部路段和巴生港连接线有不同节点。

Match the date to the intended route—for example, factory to east-coast terminal, east coast to Gombak, or east coast to Northport/Westports—and include a contingency if the business must operate before rail service is available.
企业要按照自己的真实运输路线来判断,例如工厂至东海岸货站、东海岸至鹅唛,或东海岸至北港/西港。如果业务必须在铁路服务启用前开始,应准备替代运输方案及缓冲成本

3. Distinguish proximity from legal and operational access  区分“靠近铁路”和“合法、可运营的货运接入”
A rail line running beside a property does not create a right to enter the railway reserve or load cargo.
铁路经过土地旁边,不代表业主有权进入铁路保留地或装卸货物。

Confirm whether the plan relies on:
必须明确计划属于哪一种模式:

- trucking containers to a public or commercial freight terminal;
用货车把集装箱送到公共或商业货站;
- access to a third-party logistics facility;
使用第三方物流设施;
- a private siding or spur, which would require technical, land, safety and commercial approvals; or
建设私人支线或专用线,并取得技术、土地、安全及商业批准;或
- a future connection that does not yet exist.
依赖一个尚未建成的未来连接。

Do not pay for a “rail-connected” claim without documentary support.
如果没有文件支持,不应为“铁路直连”宣传支付溢价。

Article image

4. Map the real first and last mile 测量真正的第一公里和最后一公里
Measure gate-to-terminal distance by the route a legal heavy vehicle can actually use—not by straight-line radius.
距离应以合法重型车辆从土地大门至货站的实际路线计算,不是地图直线半径。

Inspect road width, bridge limits, junction geometry, gradients, flood points, railway crossings, height restrictions, turning space and local lorry operating conditions.
现场检查道路宽度、桥梁限载、路口转弯、坡度、积水点、铁路道口、限高、回转空间及当地货车通行限制。

Test the route at the hours when trucks will move.
最好在未来货车实际运行时段测试路线。

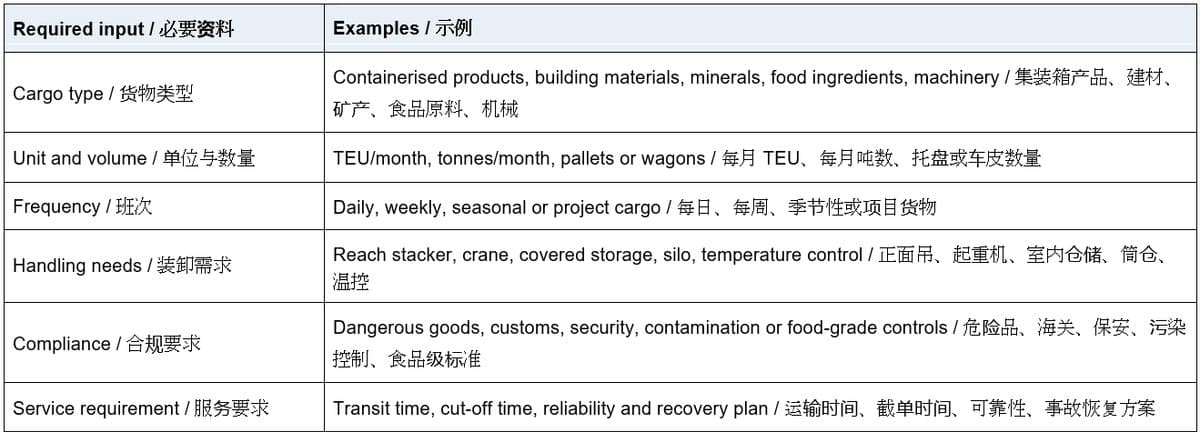

5. Define the freight before assessing the railway 先定义货物,再判断铁路是否适合

Rail suitability depends on the cargo. Prepare a simple freight brief covering:

铁路是否可行,取决于货物本身。企业应准备简明的货运需求书:

Article image

Without this brief, a terminal operator cannot meaningfully confirm feasibility or quote a service.  没有这份需求书,货站或运营方无法作出有意义的可行性确认或报价。

6. Obtain commercial confirmation from the relevant operator  向相关运营方取得商业确认
Request written information on available routes, terminal capacity, service frequency, minimum volumes, booking process, handling equipment, cut-off times, storage charges, liability, customs interfaces and indicative rates.
书面询问可用路线、货站容量、班次、最低货量、订舱流程、装卸设备、截单时间、堆存费、责任范围、海关衔接和参考费率。

Public project information establishes the corridor; it does not establish a slot, tariff or service contract for a particular buyer.
公开项目资料只能证明走廊存在,不能证明某个买方已经获得班次、价格或服务合同。

7. Check title, zoning and planning permission  检查地契、规划用途与开发批准
Rail proximity does not override land law or planning controls.
铁路位置不会取代土地法和规划要求。

Review the title category and express conditions, local-plan zoning, planning permission requirements, access status, acquisition restrictions and any conversion or premium.
审查地契类别与明文条件、地方规划用途、规划许可、合法出入口、收购限制,以及任何用途转换或补价。

Use PLANMalaysia's i-Plan as an initial screen, then confirm the position with the relevant land office and local authority.
可以先用PLANMalaysia的i-Plan做初步筛查,再向相关土地局和地方政府正式确认。

8. Verify utilities and net buildable land  核实公用设施和净可建面积
A logistics advantage cannot rescue a site that lacks power, water, telecommunications, drainage capacity or a practical platform.
如果土地没有足够电力、供水、通讯、排水或合适的平台,物流优势也无法解决开发问题。

Commission appropriate technical checks for soil, levels, earthworks, flood exposure, stormwater, slope, access and environmental constraints.
应根据项目需要检查土质、标高、土方、洪水、雨水排放、边坡、出入口和环境限制。

Calculate the net buildable area after roads, drains, buffers, reserves, setbacks and infrastructure—not just the gross acreage.
面积计算必须扣除道路、沟渠、缓冲带、保留地、退界和基础设施,不能只看总英亩数。

9. Protect against rail-related constraints  防范铁路相关限制
Check the surveyed railway reserve, easements, acquisition boundaries, setbacks, safety zones, drainage interfaces, noise and vibration exposure, and any restrictions on crossings or structures.
确认经过测量的铁路保留地、地役权、征地边界、退界、安全区、排水衔接、噪音和震动,以及跨越铁路或建设结构的限制。

A site can benefit from the railway while still requiring design mitigation.
土地可以受益于铁路,同时仍需要额外设计缓解。

For sensitive manufacturing, laboratories, data equipment or precision operations, obtain specialist advice on vibration and electromagnetic or acoustic effects where relevant.
精密制造、实验室、数据设备或对震动敏感的业务,应在适用时寻求震动、电磁或声学专业意见。

Article image

10. Compare the complete door-to-door cost  比较完整的门到门成本
Do not compare rail line-haul with the entire road quote. Build both scenarios on the same basis.
不能只拿铁路干线运费和整套公路报价比较。两种方案必须采用相同计算范围。

Rail scenario: factory loading + drayage to terminal + terminal handling + rail freight + destination handling + final delivery + storage/demurrage + insurance + inventory time.
铁路方案: 工厂装货+短驳至货站+货站装卸+铁路运输+目的地装卸+最后配送+堆存/滞箱+保险+库存时间。

Road scenario: factory loading + full road line-haul + tolls/surcharges + waiting + insurance + delivery and recovery plan.
公路方案: 工厂装货+全程公路运输+过路费/附加费+等候+保险+配送及事故恢复方案。

Rail may be attractive for regular, sufficiently large flows, but two extra handling events or a weak last mile can erase the advantage. Test base, high-volume and disruption scenarios.
铁路可能更适合稳定、批量足够大的货流,但额外两次装卸或较差的最后一公里,可能抵消节省。至少测试基础情景、大货量情景和中断情景。

11. Put the evidence and timing into the transaction 把证据和时间风险写进交易文件

Translate unresolved risks into contractual protection.

未解决的风险必须转化为合同保护。

Depending on the deal, this may include conditions precedent, a due-diligence period, access for surveys, documentary deliverables, financing conditions, planning or conversion approvals, utility confirmation and a long-stop date.

视交易情况,可加入先决条件、尽调期、进场勘察权、卖方文件交付、融资条件、规划或用途转换批准、公用设施确认及最迟完成日期。

The sale and purchase or tenancy agreement should not promise a freight outcome that no operator or authority has confirmed.

买卖或租赁合同不应承诺任何未经运营方或政府部门确认的铁路货运结果。

A practical three-level decision test

三个等级的决策测试

Article image

Documents to request before making the rail claim 宣称“铁路货运优势”之前应取得的文件

- official station/terminal function and latest route information;
官方车站/货站功能及最新路线资料;
- site title, survey plan, zoning and planning records;
土地地契、测量图、规划用途及批准记录;
- measured heavy-vehicle route from property gate to terminal;
从土地大门至货站的重型车辆实测路线;
- terminal or rail-operator response for the proposed cargo profile;
货站或铁路运营方针对拟运输货物的回复;
- utility availability and capacity confirmations;
公用设施供应与容量确认;
- earthworks, flood, drainage and net-buildable-area assessment;
土方、洪水、排水及净可建面积评估;
- capex estimate for yards, docks, container staging or any connection works;
堆场、装卸月台、集装箱暂存区或连接工程的资本开支估算;
- door-to-door rail-versus-road cost model; and
铁路与公路门到门成本模型;以及
- transaction clauses allocating approval, timing and infrastructure risks.
分配批准、时间与基础设施风险的交易条款。

Red flags 常见危险信号
Marketing material says “ECRL-linked” but does not name a freight terminal.
宣传写着“连接ECRL”,却没有说明具体货站。

Distance is quoted in kilometres without a legal truck route.
只写距离几公里,没有合法货车路线。

A passenger station is presented as cargo access.
把客运站当成货运接入证明。

The calculation assumes January 2027 for a Port Klang movement that depends on the later section.
依赖巴生港的运输却直接采用2027年1月作为启用日期。

Freight rates, slots or handling capability are assumed without operator confirmation.
没有运营方确认,就假设运费、班次或装卸能力。

The land is industrial “in principle” but title, zoning or planning position is unresolved.
只说土地“原则上属工业用途”,但地契、规划或许可仍未解决。

The asking price includes a rail premium while the rail case remains only a future possibility.
卖价已包含铁路溢价,但铁路方案仍只是未来可能性。

Conclusion 结语
ECRL can reshape industrial and logistics decisions across Peninsular Malaysia, especially for businesses linking east-coast production with the Klang Valley and ports.ECRL可能重塑马来西亚半岛的工业与物流选址,尤其适合研究东海岸生产基地、巴生谷和港口之间供应链的企业。

But the strongest purchase case is not “land beside the railway.” It is land with a documented cargo route, workable terminal, legal heavy-vehicle access, suitable approvals and utilities, and a door-to-door cost advantage that survives realistic assumptions.
不过,最强的购买理由不是“土地在铁路旁边”,而是:这块土地拥有可证明的货运路线、可操作的货站、合法重型车辆通道、合适的批准与公用设施,以及在现实假设下仍然成立的门到门成本优势。

For an industrial property assessment, compare the site, freight plan and transaction structure together. That is how a location story becomes an investable operating case.
评估工业地产时,应把土地条件、货运计划和交易结构放在一起比较。只有这样,地点故事才会变成可投资、可执行的运营方案。

Frequently Asked Questions 常见问题
1. Does land near an ECRL station automatically have rail-cargo access?
 靠近ECRL车站的土地是否自动拥有铁路货运接入?
No. The nearby station may be passenger-only, and even a freight station requires workable terminal access, handling capability, a suitable service and commercial arrangements.
不是。附近车站可能只有客运功能;即使是货站,也必须具备可用的货站接入、装卸能力、适合的服务及商业安排。

2. When are the ECRL sections scheduled to operate?
 ECRL各路段计划什么时候运营?
The Kota Bharu–Gombak section is scheduled for commercial operations in January 2027. The Gombak–Port Klang section is scheduled for full operations in January 2028, following completion in December 2027. Re-check official updates before committing.
哥打峇鲁至鹅唛路段计划于2027年1月商业运营;鹅唛至巴生港路段计划于2027年12月完工,并于2028年1月全面运营。作出投资承诺前应再次核实官方进度。

3. Does a factory need a private rail siding?
 工厂一定需要私人铁路支线吗?
Not always. Many users may truck cargo to an intermodal terminal. A private siding may suit very large or specialised flows, but it requires technical, land, safety, operational and commercial approvals.
不一定。许多用户可以用货车把货物送到多式联运货站。私人支线可能适合超大批量或特殊货物,但必须取得技术、土地、安全、运营和商业批准。

4. How should “distance to ECRL” be measured?
“距离ECRL多远”应怎样计算?
Use the actual legal heavy-vehicle route from the property gate to the relevant freight terminal, including travel time, road constraints and operating hours—not a straight-line map radius.
应按重型车辆从土地大门至相关货站的实际合法路线计算,并考虑时间、道路限制和运营时段,而不是地图直线半径。

5. What should a buyer confirm before paying a rail-location premium?
支付铁路区位溢价之前,买家应确认什么?
At minimum: freight-station function, service date, operator response, first/last-mile route, title and planning status, utility capacity, site-development cost and a comparable door-to-door logistics model.
至少应确认:货站功能、服务日期、运营方回复、第一/最后一公里路线、地契与规划、公用设施容量、土地开发成本,以及可比较的门到门物流模型。
