Is This Factory Overhead-Crane Ready? 12 Checks Before Buying or Leasing in Malaysia | 这间马来西亚厂房适合安装天车吗?购买或租赁前必须检查的12项条件

A practical guide to hook height, runway beams, column brackets, structural forces, DOSH/JKKP design verification and Certificate of Fitness requirements.

Aug 17, 2026
Is This Factory Overhead-Crane Ready? 12 Checks Before Buying or Leasing in Malaysia | 这间马来西亚厂房适合安装天车吗?购买或租赁前必须检查的12项条件

A high roof or an existing crane does not make a factory crane-ready. Buyers and tenants must verify the load, hook height, runway structure, building forces, approvals, testing and valid Certificate of Fitness before signing.

Is This Factory Overhead-Crane Ready? 12 Checks Before Buying or Leasing in Malaysia
这间马来西亚厂房适合安装天车吗?购买或租赁前必须检查的12项条件

A practical guide to hook height, runway beams, column brackets, structural forces, DOSH/JKKP design verification and Certificate of Fitness requirements.
从吊钩高度、轨道梁、柱托和基础,到DOSH/JKKP设计验证与合格证书(Certificate of Fitness,CF)的实用检查指南。

Answer first: what makes a Malaysian factory crane-ready?
先说结论:什么才是真正的“天车厂房”?

A factory is crane-ready only when the incoming lifting requirement, usable hook height, crane span and travel path, runway beams and rails, supporting columns and foundations, electrical supply, regulatory status and safe operating layout all match.
只有当企业实际吊运需求、可用吊钩高度、天车跨度与行程、轨道梁和钢轨、柱托与厂房结构、基础、电力、法规文件及安全操作布局全部互相匹配,这间厂房才可称为适合安装或使用天车。

A high ceiling is not proof. A yellow beam inside the factory is not proof. An owner’s statement that “the previous tenant used a 10-tonne crane” is not proof.
屋顶很高,不代表一定能装天车;厂内看到一条黄色横梁,也不代表可以合法使用;业主说“上一任租户使用过10吨天车”,更不能代替结构计算、设备资料和政府文件。

For a power-driven overhead or bridge crane, the transaction team should obtain the crane data, structural evidence and current regulatory records before making an unconditional commitment. Malaysia’s Department of Occupational Safety and Health (DOSH/JKKP) states that power-driven lifting machinery generally requires design verification and a valid Certificate of Fitness before it is built, installed or used, subject to the regulations and exclusions applicable to the particular equipment. The official guidance was updated on 16 March 2026.
对于动力驱动的桥式或天车起重机,交易团队应在作出无条件承诺前取得设备资料、结构证据及现行法规文件。马来西亚职业安全与卫生局(DOSH/JKKP)目前的官方说明指出,采用动力驱动的起重机械,一般需要在制造、安装或使用前取得设计验证和有效的合格证书(CF),但仍须按具体设备及适用豁免进行判断。该官方页面于2026年3月16日更新。

The practical question is therefore not “Does the factory have a crane?” It is:
所以买家或租户真正要问的,不是“这里有没有天车”,而是:

Can this specific building safely and lawfully operate the buyer’s or tenant’s required crane, load and production process?

这座厂房能否安全、合法并有效地运行我们所需要的天车、吊重和生产流程?

Crane-ready is a complete system—not one specification
“天车厂房”是一整套系统,不是一个数字

An overhead crane transfers forces through several connected components. The lifted load acts through the hook, hoist and bridge; the crane wheels act on the rails; the rails act on runway beams; the runway beams act on brackets or corbels; and the forces then continue through the columns and foundations.

天车的力会沿着完整路径传递:吊物作用于吊钩、葫芦和桥架;车轮作用于钢轨;钢轨作用于轨道梁;轨道梁再把力传到柱托、柱子和基础,最终进入地基。

At the same time, the crane must fit within the building envelope and move the real product without striking roof bracing, sprinklers, lights, ducts, cable trays, machines, stored goods or people.

与此同时,天车还必须在厂房内部安全行走,不能撞到屋架、支撑、喷淋、灯具、风管、电缆桥架、机器、货物或人员。

Article image
Article image

1. Define the real lifted load 先定义真实吊重

Do not start with a property brochure. Start with the operation.
不要从房源广告开始,而应从企业生产需求开始。

- Provide the crane supplier and structural engineer with:
向天车供应商和结构工程师提供:
- the maximum product or machine weight;
产品或机器最大重量;
- lifting beam, spreader, magnet, grab, sling, hook block and other accessory weights;
吊梁、平衡梁、电磁铁、抓斗、吊索和吊钩组等附件重量;
- overall load length, width and height;
吊物长度、宽度和高度;
- centre of gravity and permitted lifting points;
重心及允许吊点;
- whether loads can swing, rotate or be handled off-centre;
吊物是否会摆动、旋转或偏心;
- number of lifts per hour and operating shifts;
每小时吊运次数及工作班次;
- required lifting speed, travel speed and positioning accuracy;
所需升降速度、行走速度和定位精度;
- tandem-lift or multiple-crane requirements; and
是否涉及双机抬吊或多台天车;以及
- future production-line expansion.
未来生产线扩充需求。

A “10-tonne load” plus a heavy lifting beam and rigging can exceed a 10-tonne crane rating. Long loads may need twin hooks or a spreader. High-frequency production may demand a different duty classification from occasional maintenance lifting.
10吨产品加上吊梁和吊具后,可能已经超过10吨天车的额定能力。长形吊物可能需要双吊点或平衡梁;高频生产所需的工作等级,也与偶尔维修吊装不同。

The Department of Standards Malaysia catalogue lists MS 1544: Part 1:2002 (Confirmed 2011), Cranes—Safe Use—Part 1: General, which covers safe systems of work, planning, selection, erection, operation, maintenance and relevant personnel. The project team should identify the current standards and engineering basis applicable to the actual crane and installation.
马来西亚标准局目录列有 MS 1544: Part 1:2002(2011确认),起重机安全使用——第1部分:通则,涵盖安全工作制度、策划、选择、安装、操作、维修及相关人员。实际项目仍应由专业团队确认当前适用的标准和设计依据。

2. Measure hook height—not only clear height 要量“吊钩高度”,不只是厂房净高

Factory listings often advertise a clear height such as 9, 12 or 15 metres. That number does not automatically equal usable hook height.
工业房源通常会写9米、12米或15米净高,但这不等于可用吊高。

  • The vertical stack can include: 从屋顶到底部吊物之间,往往还包括:
  • roof structure and bracing; 屋架与支撑;
  • required clearance above the crane; 天车顶部所需安全间距;
  • crane bridge depth; 桥架自身高度;
  • trolley and hoist arrangement; 小车与葫芦;
  • upper hook approach; 吊钩上极限接近距离;
  • hook block; 吊钩组;
  • slings or lifting accessories; and 吊索或吊具;以及
  • the depth of the lifted load. 吊物本身的高度。

The required building height can therefore be much greater than the desired elevation of the load.
因此,为了把产品吊到指定高度,所需建筑高度可能远高于目标吊物高度。

Measure the lowest controlling obstruction across the complete crane path, including roof bracing, gutters, sprinklers, smoke-control equipment, lights, ducts, busbars and cable trays. A small local obstruction can prevent the trolley or load from reaching a critical production point.
检查整条天车路线上的最低障碍,包括屋架支撑、天沟、喷淋、排烟设备、灯具、风管、母线和电缆桥架。一个局部障碍,就可能令小车或吊物无法到达关键生产位置。

3. Confirm the horizontal operating envelope 确认水平覆盖范围

The crane must reach the places where work happens.

天车必须能够到达实际工作的区域。

- Plot on one coordinated layout:

把以下位置放在同一张协调图上:

- material-receiving and unloading points;

收货和卸货位置;

- machine installation and maintenance zones;

机器安装与维修区;

- production stations;

生产工位;

- storage or laydown areas;

暂存区;

- scrap and finished-goods routes;

废料及成品路线;

- columns, walls, mezzanines and offices;

柱子、墙体、夹层和办公室;

- fire exits and fire-appliance access;

消防出口与消防通道;

- pedestrian routes; and

行人路线;以及

- future expansion space.

未来扩建空间。

Check the bridge end approach and trolley side approach. A crane can span the full bay yet still leave unusable zones near the ends or sides. The hook position, not the beam edge, determines practical coverage.

必须核实桥架端部接近距离和小车侧向接近距离。即使天车横跨整个跨间,吊钩仍可能无法到达两端或两侧的部分区域。实际覆盖范围应以吊钩位置判断,而不是只看横梁边缘。

Article image

4. Verify the crane runway beams and rails 核实轨道梁与钢轨

Runway beams carry repeated wheel loads. They also experience horizontal forces from acceleration, braking, skewing and imperfect alignment. The engineering review may need to consider:
轨道梁承受反复车轮荷载,还会受到加速、制动、偏斜和轨道误差造成的水平力。工程检查可能包括:

- maximum vertical wheel loads and wheel spacing;
最大轮压与轮距;
- impact or dynamic factors;
冲击或动力系数;
- longitudinal surge and transverse forces;
纵向制动力和横向力;
- runway-beam bending, shear, torsion and deflection;
轨道梁弯曲、剪切、扭转和挠度;
- lateral stability and restraint;
横向稳定与约束;
- rail size, clips, welds, joints and end stops;
钢轨尺寸、压板、焊缝、接头和止挡;
- beam splices and connections;
梁拼接与连接;
- fatigue and repeated load cycles;
疲劳及重复荷载次数;
- alignment, level and span tolerance; and
轨道直线度、水平度和跨度公差;以及
- corrosion, damage or unauthorised alteration.
锈蚀、损坏或未经批准的改动。

Do not rely on the crane’s rated capacity as a substitute for wheel-load data. Different crane configurations with the same rated lifting capacity can impose different wheel reactions.
不要用天车额定吨位代替轮压资料。即使额定吊重相同,不同结构和轮组布置也会产生不同轮压。

Article image

5. Trace the force into columns and foundations 把作用力追踪到柱子和基础

A suitable runway beam is not enough if its supports are inadequate.
轨道梁合格,并不代表其支撑一定足够。

- Inspect and verify:
应检查:
- column brackets, corbels and stiffeners;
柱托、牛腿和加劲板;
- bolts, welds, plates and bearing details;
螺栓、焊缝、钢板及支承细节;
- building columns and local reinforcement;
厂房柱及局部补强;
- ties and bracing that resist horizontal forces;
承受水平力的拉杆和支撑;
- baseplates and anchor bolts;
柱脚底板和锚栓;
- pad, strip, raft or piled foundations;
独立基础、条形基础、筏板或桩基;
- settlement or column movement; and
沉降或柱子位移;以及
- modifications made after the original design.
原设计完成后的结构改动。

Crane brackets added later to an ordinary portal-frame factory can change forces in the columns and foundations. The original building may have been designed for roof and wind loads without the proposed crane actions.
在普通门式钢架厂房后来加装天车柱托,会改变柱子及基础所承受的力。原厂房可能只按屋顶和风荷载设计,并没有考虑计划中的天车作用力。

6. Distinguish an integrated crane structure from a freestanding system
分清厂房支承式与独立式天车结构

There are two broad arrangements:
主要有两种结构:

Building-supported crane 厂房结构支承式
The runway is supported by the factory’s structural columns or purpose-designed crane columns. This can preserve floor space, but the building and foundations must be verified for the crane forces.
轨道梁由厂房结构柱或专用天车柱支撑,可以节省地面空间,但必须证明厂房及基础能够承受天车作用力。

Freestanding crane structure 独立式天车结构
Independent columns and runway beams are installed inside the building. This may reduce reliance on the existing superstructure, but it introduces new foundation loads, floor openings, column footprints, collision zones and approval work.
在厂房内部另设独立柱和轨道梁,可以减少对原上部结构的依赖,但会带来新的基础荷载、柱位、碰撞区和审批工作。

“Freestanding” does not mean “place it on the slab.” Concentrated column reactions often need specifically designed foundations rather than an ordinary factory floor slab.
“独立式”不等于“直接放在地坪上”。天车柱产生的集中力和水平力,往往需要专门设计基础,而不是普通厂房地坪。

7. Check the building and renovation approval baseline
核对建筑与改造审批

Installing runway beams, brackets, crane columns, foundations, roof openings, platforms or electrical systems may constitute structural or building work requiring professional submissions and local-authority approval.
新增轨道梁、柱托、天车柱、基础、屋顶开口、维修平台或电气系统,可能属于需要专业人士提交和地方政府批准的结构或建筑工程。

Malaysia’s Street, Drainage and Building Act 1974 provides the core building-control framework in Peninsular Malaysia, while the applicable Uniform Building By-Laws depend on state gazettement. KPKT also published a 2026 guideline for building-renovation works. The appointed architect or engineer should confirm the exact submission route for the relevant local authority and proposal.
《1974年道路、沟渠及建筑物法令》(Act 133)是马来半岛主要建筑管制框架之一;适用的统一建筑附例则取决于各州宪报。KPKT也在2026年发布了建筑改造工程指南。建筑师或工程师应按具体地方政府和工程内容确认正确申请程序。

For due diligence, compare:
尽调时应对照:
- approved architectural and structural plans; 批准建筑图和结构图;
- CCC or CF records for the building; 厂房CCC或CF记录;
- approved additions and alterations; 批准的扩建和改造工程;
- actual runway, bracket and column locations; and 现场轨道梁、柱托与柱子位置;以及
- the proposed new installation 新天车计划。

8. Verify DOSH/JKKP design and CF records 核实DOSH/JKKP设计验证和CF
Under the current DOSH/JKKP framework, power-driven lifting machinery is generally treated as plant requiring design verification and a valid Certificate of Fitness, subject to the exact equipment and regulatory exclusions.
按照DOSH/JKKP当前制度,动力驱动起重机械一般属于需要设计验证和有效CF的设备,但仍须按具体设备和适用豁免确认。

For an existing crane, request:
对于现有天车,应索取:
- manufacturer and model information; 制造商与型号;
- serial number and rated-load markings; 序列号及额定载荷铭牌;
- approved design-verification records; 设计验证批准记录;
- registration or plant-identification details; 注册或设备识别资料;
- current Certificate of Fitness; 有效CF;
- inspection and test reports; 检查和测试报告;
- maintenance, repair and breakdown history; 保养、维修和故障历史;
- records of modification or capacity change; 改造或提升吨位记录;
- competent-person and operator records where applicable; and 适用的合资格人士和操作员记录;以及
- any DOSH/JKKP notices or outstanding conditions. DOSH/JKKP通知或未完成条件。

DOSH/JKKP’s 2024 regulations became effective on 1 June 2024, and its current online guidance directs applications for lifting-machinery design verification or modification through MySKUD via MyKKP. Do not assume that an old file, previous occupier’s approval or expired certificate can simply be transferred to a new owner, new configuration or new operating condition. Confirm the current position directly with DOSH/JKKP and qualified professionals.
DOSH/JKKP的2024年相关条例于2024年6月1日生效;目前网上指南说明,起重机械设计验证和改造申请通过MyKKP单一登录进入MySKUD系统提交。不要假设旧文件、上一任租户的批准或过期证书能够自动转移到新业主、新配置或新工况。应向DOSH/JKKP及合资格专业人士确认当前要求。

9. Confirm power supply and electrical distribution 检查电力与配电
The crane’s connected load may be modest compared with process machinery, but its starting current, regenerative behaviour, duty, voltage, controls and simultaneous operation still matter.
天车用电量可能低于大型生产设备,但启动电流、再生制动、工作等级、电压、控制系统及同时运行情况仍然重要。

Check/ 核实:
- supply voltage and phase; 电压与相数;
- total crane motor load; 天车电机总负荷;
- starting and peak demand; 启动和峰值需求;
- conductor or busbar route; 滑触线或电缆路线;
- isolation and emergency-stop arrangement; 隔离开关及紧急停止系统;
- earthing and lightning protection; 接地和防雷;
- voltage drop across the travel length; 长行程电压降;
- compatibility with variable-frequency drives and other equipment; and 变频器与其他设备的兼容性;以及
- spare capacity in the factory distribution system. 厂房配电系统剩余容量。

The property’s existing electricity bill does not prove that the crane circuit, protection or distribution route is adequate.
现有电费单不能证明天车回路、保护系统和配电路线足够。

10. Inspect condition, alignment and fatigue indicator 检查状态、对中与疲劳迹象

An existing crane-ready factory should be inspected as a working structural and mechanical system.
现有天车厂房必须作为完整的结构和机械系统进行检查。

Look for/ 注意:
- rail misalignment, unusual wear or loose clips;
钢轨不直、不均匀磨损或压板松动;
- damaged end stops or buffers;
止挡或缓冲器损坏;
- cracking near brackets, stiffeners or welds;
柱托、加劲板或焊缝附近开裂;
- elongated bolt holes or loose connections;
螺栓孔拉长或连接松动;
- local column deformation;
柱子局部变形;
- corrosion, water ingress or chemical attack;
锈蚀、渗水或化学侵蚀;
- uneven wheel contact or signs of crane skewing;
车轮接触不均或偏斜迹象;
- settlement or differing column levels;
沉降或柱顶标高不同;
- undocumented strengthening or cut-outs; and
没有记录的补强或切割;以及
- collision damage from vehicles or loads.
车辆或吊物碰撞损坏。

These observations do not by themselves determine structural adequacy. They identify where detailed assessment, measurement, testing or repair may be needed.
这些表面迹象不能单独判断结构是否安全,但可以指出需要进一步测量、测试、分析或维修的位置。

11. Protect the operating and safety zone 保护操作及安全区域

A crane-ready factory needs safe space beneath and around the load path.
合适的天车厂房,必须在吊物下方和行走范围内保留安全空间。

Review/ 检查:
- exclusion zones and pedestrian separation;
禁入区与人车分流;
- visibility for the operator and signaller;
操作员和指挥员视线;
- emergency stops and communication;
紧急停止和通信;
- access for inspection and maintenance;
检查与维修通道;
- safe retrieval or rescue arrangements;
救援安排;
- clearance from machines, racks and stored materials;
与机器、货架和存货的距离;
- fire escape and firefighting systems;
消防逃生及灭火系统;
- loading and unloading coordination; and
装卸协调;以及
- controls for suspended-load movement.
悬吊物移动控制。

The cheapest crane position may not be the safest or most productive layout.
成本最低的天车位置,不一定是最安全或最高效的生产布局。

12. Make the transaction conditional on evidence
12. 在合同里保护买家或租户
Before signing an unconditional sale and purchase agreement or tenancy agreement, convert uncertainties into deliverables and conditions.

签署无条件买卖协议或租约前,应把不确定事项转化成明确交付文件和条件。

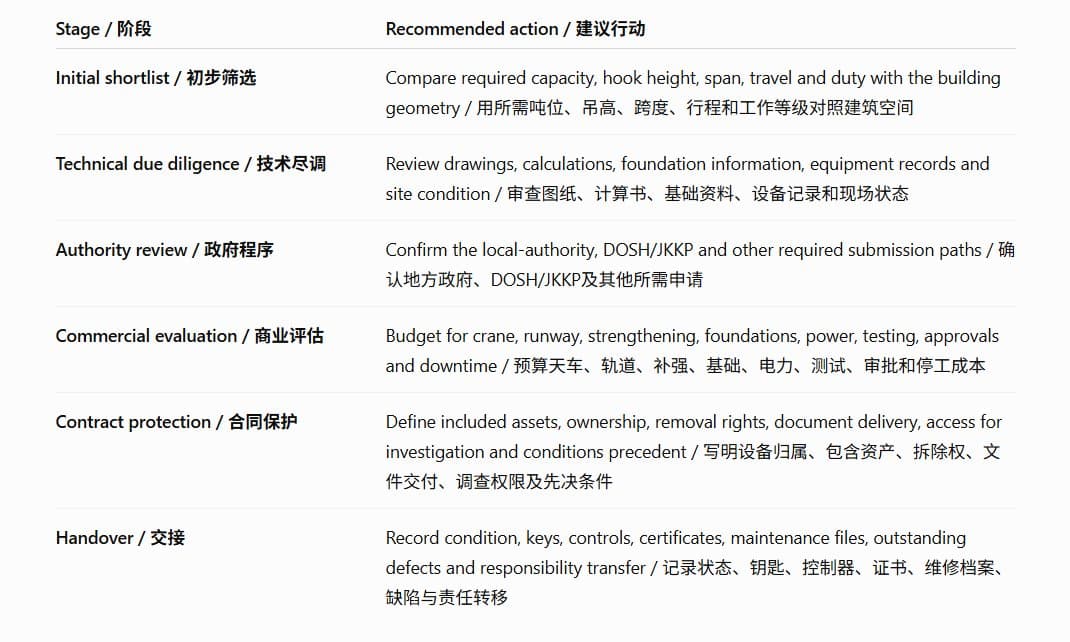

Article image

If material records are unavailable, the solution is not to guess. Price and programme an investigation by the appropriate professionals. This may include surveys, non-destructive testing, material checks, foundation investigation, structural analysis or controlled load testing where professionally specified.
如果关键资料缺失,不应凭感觉判断,而应由相关专业人士制定调查范围和预算。调查可能包括测量、无损检测、材料检查、基础调查、结构分析,或在专业人士指定条件下进行控制加载测试。

Red flags that deserve immediate attention
需要立即关注的危险信号

“Crane-ready” appears only in the marketing description.
“Crane-ready”只出现在广告文案里。

No one can identify who owns the existing crane.
没有人能说明现有天车属于谁。

The crane nameplate and CF details do not match.
铭牌资料与CF不一致。

The CF has expired or the owner cannot produce it.
CF已过期或业主无法提供。

Structural drawings do not show the runway or brackets.
结构图没有显示轨道梁或柱托。

The rated load has been altered on site.
现场擅自更改额定吨位。

The runway ends abruptly at an extension joint.
轨道在扩建接缝处突然中断。

Columns or brackets show distortion, cracking or heavy corrosion.
柱子或柱托出现变形、裂缝或严重锈蚀。

The quoted clear height ignores the hook block and load depth.
所谓净高没有扣除吊钩组和吊物高度。

A proposed freestanding crane is assumed to sit on the existing slab.
计划把独立式天车直接安装在普通地坪上。

Roof services obstruct the trolley or suspended load.
屋顶设备阻挡小车或吊物路线。

The transaction timetable assumes immediate operation without verification, testing or authority work.
交易时间表假设无需验证、测试和政府程序即可马上投产。

XPillar’s practical conclusion
XPillar实用结论
For manufacturers handling moulds, dies, steel coils, tanks, precast products, heavy machines or maintenance lifts, an appropriate overhead crane can transform productivity. The wrong factory, however, can turn the crane into a costly structural, approval and commissioning project.
对于需要吊运模具、钢卷、储罐、预制件、重型机器或维修部件的制造企业,合适的天车可以显著提高效率。但如果选错厂房,天车也可能变成昂贵的结构补强、审批和调试项目。

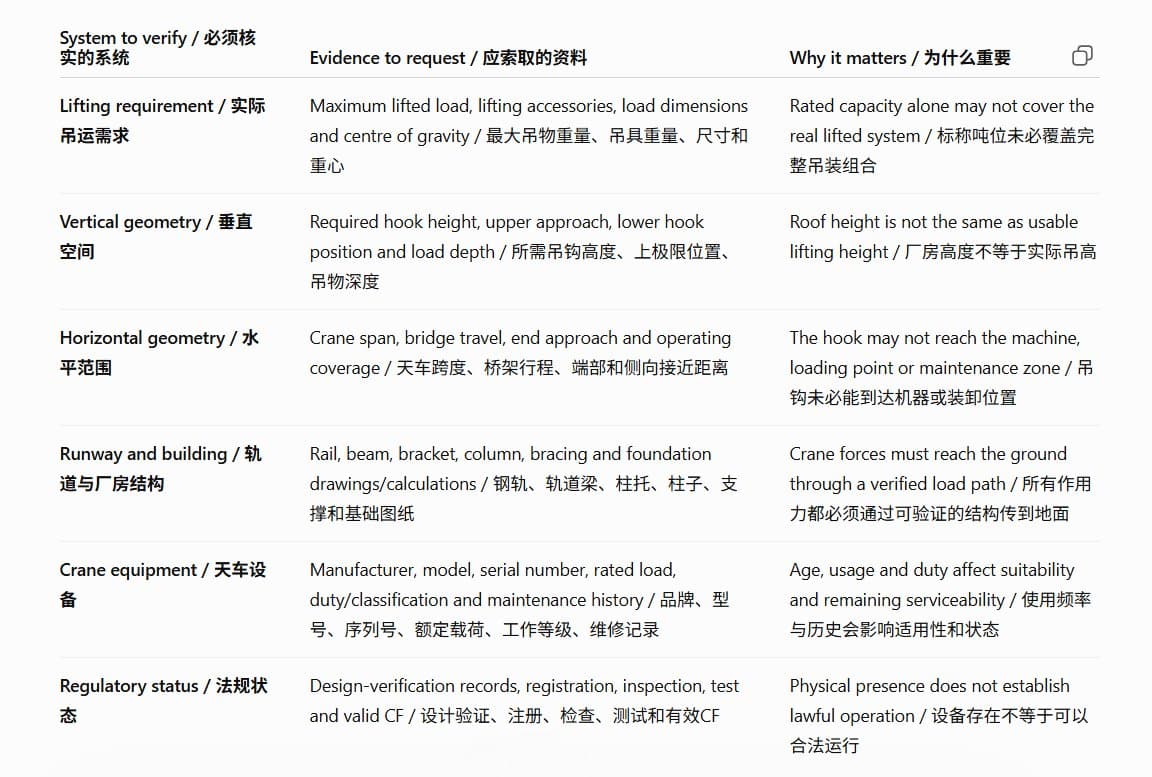

Shortlist properties using the required hook position, load route and crane duty, then verify the equipment, runway, building and regulatory evidence as one system. That is more reliable than screening by roof height or advertised tonnage alone.
先用所需吊钩位置、吊物路线和工作等级筛选厂房,再把设备、轨道、厂房结构和法规文件作为一个系统核实。这比只看厂房高度或广告吨位更可靠。

Explore current Malaysian industrial properties and review more XPillar industrial-property articles.
查看XPillar的马来西亚工业物业,以及更多XPillar工业地产文章。

This article provides general property and due-diligence information. It is not structural, mechanical, electrical, occupational-safety, regulatory or legal advice. Requirements depend on the property, crane, use, location and authorities. Appoint qualified professionals and obtain current written confirmation for the specific project before committing.
本文仅提供一般工业地产及尽职调查信息,不构成结构、机械、电气、职业安全、法规或法律意见。具体要求取决于物业、天车、用途、地点和主管机关。作出承诺前,应委任合资格专业人士,并取得针对该项目的最新书面确认。

Frequently Asked Questions
常见问题
1. Does a high factory roof mean an overhead crane can be installed?
厂房屋顶很高,就一定可以安装天车吗?
No. The team must verify usable hook height, crane depth, upper approach, load depth, roof services, runway structure, columns, foundations, power and approvals.
不一定。还要核实实际吊钩高度、天车自身高度、上极限距离、吊物深度、屋顶设备、轨道结构、柱子、基础、电力和审批。

2. Can a buyer use the previous tenant’s overhead crane immediately?
买家可以马上使用上一任租户留下的天车吗?
Not automatically. Confirm ownership, equipment identity, condition, design-verification records, valid CF, maintenance history, building support and whether the new load and use match the verified arrangement.
不能自动假设可以。必须确认设备归属、型号、状态、设计验证、有效CF、维修历史、厂房支撑结构,以及新用途是否符合原验证条件。

3. Is crane capacity the same as maximum product weight?
天车吨位是否等于产品最大重量?
No. The lifted system can include the product, hook block, lifting beam, spreader, magnet, grab, slings and other accessories. Operating dynamics and duty also matter.
不是。完整吊重可能包括产品、吊钩组、吊梁、平衡梁、电磁铁、抓斗、吊索和其他附件,还要考虑动力作用和工作频率。

4. Does a Certificate of Fitness prove the factory structure is adequate for every future crane use?
有CF是否代表厂房结构适合所有未来用途?
No. A valid CF is an important regulatory record, but the property team must still verify that the specific runway, supports, building and proposed operating condition are suitable.
不是。有效CF是重要法规文件,但仍须核实具体轨道、支撑、厂房结构及计划工况是否匹配。

5. Can a freestanding crane be installed on an ordinary factory slab?
独立式天车可以直接放在普通厂房地坪上吗?
Do not assume so. Freestanding crane columns create concentrated and horizontal reactions that may require purpose-designed foundations and approved structural work.
不要这样假设。独立天车柱会产生集中力和水平力,可能需要专门设计的基础及获得批准的结构工程
