A road beside the site is not enough. Verify title frontage, registered access rights, planning approval, drainage crossings and heavy-vehicle usability before committing.
地块旁边有道路并不足够。承诺购买或开发前,必须核实地契临路关系、已注册通行权、规划批准、排水跨越及重型车辆的实际使用条件。
The answer first/ 先说结论
Industrial land should be treated as having dependable access only when four questions can be answered with evidence: Does the title legally reach a public road? If another parcel must be crossed, is the right registered and does it allow vehicles? Will the local authority approve the proposed access or crossover? Can the intended lorries, emergency vehicles and utilities use the route safely?
只有四个问题都有证据支持,工业地的出入口才算可靠:地契是否依法连接公共道路?若必须经过别人的土地,通行权是否已经注册并允许车辆使用?地方政府会否批准拟议出入口或跨沟工程?目标货车、消防车辆及公用设施是否能够安全使用该路线?
A seller's statement, a Google Maps line, an open gate or years of informal use does not answer those questions.
卖方的口头说明、Google地图上的路线、一个敞开的闸门,或多年来非正式使用某条路,都不能回答这些问题。
Malaysia's National Land Code generally does not allow an easement to arise merely through long use or implication; an easement is normally created by express grant and registration.
马来西亚《国家土地法典》一般不承认仅因长期使用或默示而自动产生地役权;地役权通常必须通过明确授予并完成注册。
The Code also distinguishes a footway from a carriageway—the latter is what authorises vehicles.
法典也区分人行通道与车行通道,只有后者才授权车辆通行。
Why access risk changes industrial-land value
为什么出入口风险会改变工业地价值
For a factory, warehouse, logistics hub or data-centre site, access is not a minor boundary issue.
对于厂房、仓库、物流枢纽或数据中心用地,出入口并不是小小的地界问题。
It can determine whether planning permission is achievable, whether a lender accepts the collateral, whether a fire appliance can enter, whether a 40-foot container truck can turn, and whether utilities can be installed without crossing land controlled by someone else.
它可能决定规划许可是否可获批、银行是否接受该资产作为抵押、消防车能否进入、40尺货柜车能否转弯,以及公用设施能否在不穿越他人土地的情况下铺设。
This is different from asking only whether a truck can physically reach the gate today.
这与单纯询问“货车今天能不能开到门口”不同。
A route may be physically usable but legally revocable.
某条路线可能实际可走,却可被他人依法撤回。
Another route may be legally registered but too narrow, too steep or unable to obtain an approved drain crossing.
另一条路线可能已注册,却太窄、太陡,或无法取得跨越排水沟的批准。
Legal access and operational access must both work.
合法通行与实际营运必须同时成立。

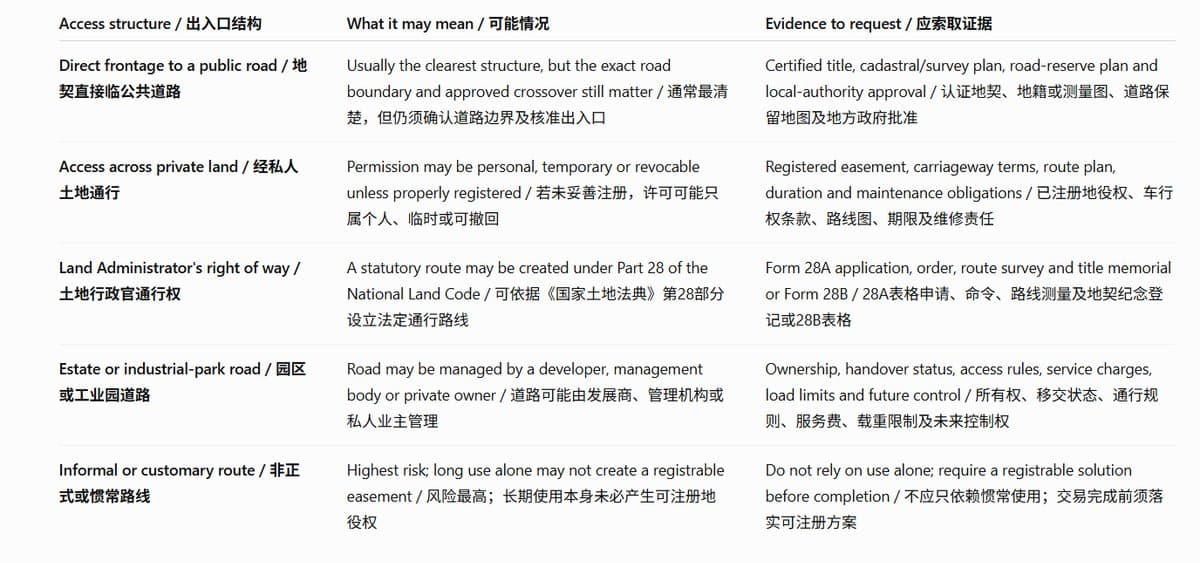

Five common access structures
五种常见出入口结构

The 12 checks before you commit
承诺交易前的12项检查

1. Match the title boundary to the actual road 把地契边界与实际道路对照
Obtain the current title, certified plan and survey information.
取得最新地契、认证图则及测量资料。
Confirm whether the legal parcel touches the road reserve or whether a drain, utility reserve, railway reserve, state land or another private lot sits between them.
确认法定地块是否真正接触道路保留地,还是中间隔着排水沟、公用设施保留地、铁路保留地、政府土地或另一私人地段。
A fence or driveway is not the legal boundary.
围篱或车道并不等于法定边界。

2. Identify who owns and controls the road 确认道路由谁拥有和控制
Determine whether it is a public street, a state road, a federal road, a local-authority road or a private road.
确认它属于公共街道、州道路、联邦道路、地方政府道路还是私人道路。
Ask whether it has been formally handed over and who controls gates, operating hours, repairs, axle restrictions and future closure.
询问道路是否已正式移交,以及谁有权控制闸门、开放时间、维修、车轴限制及未来封路。
Under the Street, Drainage and Building Act 1974, a local authority's street functions and a private person's right to form a new street are regulated separately.
《1974年街道、排水与建筑法令》分别规范地方政府的街道职能及私人新建道路的权限。
3. Verify direct frontage—not visual proximity 核实直接临路,而不是视觉上靠近
Ask the surveyor to mark the legal frontage and the proposed gate position.
要求测量师标示法定临路范围及拟议闸门位置。
Measure the frontage available after road-widening lines, corner splays, drainage reserves and setback requirements.
扣除道路拓宽线、转角切角、排水保留地及退界要求后,再量度实际可用临路宽度。
A site can appear to face a road while its only lawful connection is elsewhere.
一块看似面对道路的土地,其唯一合法连接点可能位于别处。
4. Search the title for registered access rights 在地契中查找已注册通行权
Conduct an official land search and review every memorial, restriction, charge, lease and easement affecting both the industrial site and any land crossed by the route.
进行正式土地查册,并审查工业地及通行路线所穿越土地上的所有纪念登记、限制、抵押、租赁及地役权。
The National Land Code states that an official search should show the registered proprietor and memorials then in force.
《国家土地法典》规定,正式查册应显示当时有效的注册业主及相关纪念登记。
5. Confirm that the right permits industrial vehicles 确认通行权允许工业车辆
Do not assume that a right “to pass” permits prime movers, trailers, staff buses or emergency vehicles.
不要假设“可通行”就代表拖头、拖格、员工巴士或紧急车辆都可进入。
Read the instrument.
必须阅读注册文书。
Under section 288 of the National Land Code, a right of footway authorises passage by persons or animals, while a right of carriageway authorises vehicles.
《国家土地法典》第288条规定,人行通道授权人员或动物通行,而车行通道才授权车辆。
Check width, weight, hours, users, frequency and whether successors in title receive the benefit.
还须检查宽度、载重、时间、使用者、频率,以及后续业主能否继续享有该权利。
6. Test whether the right is durable and financeable 测试通行权是否长期有效并可融资
Check whether the easement is perpetual or limited, whether the route can be relocated, how it ends, who maintains it, and whether a chargee, lessee or tenant had to consent.
确认地役权是永久还是有期限、路线能否被迁移、如何终止、由谁维修,以及是否需要抵押权人、承租人或租户同意。
Ask the buyer's lawyer and lender whether the structure is acceptable before the purchase becomes unconditional.
买卖变成无条件前,应由买方律师及贷款银行确认该结构是否可接受。
7. If there is no easement, investigate a statutory right of way 若没有地役权,调查法定通行权方案
Part 28 of the National Land Code allows an application to the Land Administrator for a right of way to a public terminal, which includes a public road.
《国家土地法典》第28部分允许向土地行政官申请通往“公共终点”的通行权,而公共终点包括公共道路。
The order can specify the route, whether vehicles are permitted, and conditions.
有关命令可规定路线、是否允许车辆及附带条件。
A survey and memorial on the affected titles are part of the process, and compensation may be payable to affected owners.
程序也包括路线测量、在受影响地契上作纪念登记,并可能需要向受影响业主支付赔偿。
This is a legal process—not a promise that every application will be approved.
这是正式法律程序,并不代表每项申请都会获批。

8. Check planning permission for the access itself 检查出入口本身的规划许可
The Town and Country Planning Act 1976 prohibits development without planning permission, and its definition of engineering operations includes forming or laying out access to a road.
《1976年城乡规划法令》禁止在未取得规划许可的情况下进行发展,而“工程作业”的定义包括建造或设置道路出入口。
Obtain the local plan, planning conditions and approved layout; verify that the proposed gate and access point are in the approved position.
应取得地方规划、规划条件及核准布局,并确认拟议闸门和出入口位于获批位置。
9. Verify the crossover, drain and road-engineering approvals 核实跨沟、排水与道路工程批准
An industrial driveway may need to cross a roadside drain or reserve.
工业车道可能需要跨越路边排水沟或道路保留地。
Check the approved culvert size, levels, structural loading, sight distance, gradient, stormwater flow and authority specifications.
必须检查获批涵洞尺寸、标高、结构承载、视距、坡度、雨水流量及主管机关规格。
10. Run a heavy-vehicle swept-path test 进行重型车辆转弯轨迹测试
Model the buyer's actual vehicle: rigid truck, articulated trailer, 40-foot container, low-loader or fire appliance.
应按买方实际车辆建模:单体货车、拖格、40尺货柜车、低板拖车或消防车。
Test the public-road approach, gate, queuing space, guardhouse, drain crossing, internal turning and exit without reversing into live traffic.
测试公共道路驶入、闸门、排队空间、警卫亭、跨沟、内部转弯及离场,避免倒车进入行驶中的公共交通。
11. Test emergency access and business continuity 测试紧急通道与业务连续性
Ask whether there is only one point of failure.
确认是否存在单一故障点。
Can fire appliances enter if a trailer blocks the gate?
若拖格堵住闸门,消防车能否进入?
Can staff and emergency responders evacuate if the access road floods, is repaired or is closed by a private owner?
若道路淹水、维修或被私人业主封闭,员工及紧急救援人员能否撤离?
For a high-throughput warehouse or mission-critical facility, a second access may be an operational requirement even when one legal route exists.
对于高周转仓库或关键设施,即使已有一条合法路线,第二出入口仍可能是营运所需。
12. Put access deliverables into the transaction documents 把出入口交付条件写入交易文件
Do not leave access as a post-completion problem.
不要把出入口问题留到交易完成后才处理。
Depending on the facts, conditions precedent may include a satisfactory official search, registered easement or right of way, approved access plan, road or drain approval, lender acceptance, discharge of conflicting interests, physical completion and an engineer's swept-path confirmation.
视个案而定,先决条件可包括满意的正式查册、已注册地役权或通行权、获批出入口图、道路或排水批准、贷款银行接受、解除冲突权益、实体工程完成,以及工程师确认车辆转弯轨迹。
Allocate survey, legal, compensation, construction and maintenance costs explicitly.
测量、法律、赔偿、施工及维修费用都应明确分配。

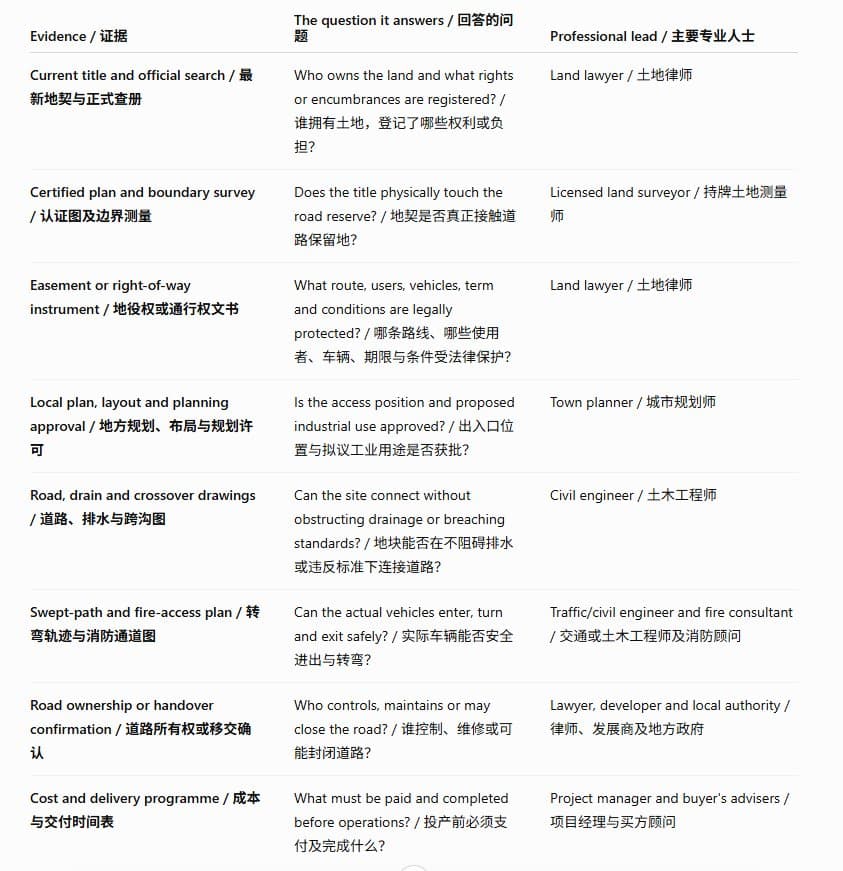

The evidence pack a serious buyer should request
认真买家应索取的证据包

Red flags that justify a pause 应暂停交易的危险信号
The agent says “everyone has always used this road,” but no registered instrument is produced.
代理说“大家一直都走这条路”,却拿不出注册文书。
The title plan and the physical driveway do not line up.
地契图与实际车道位置不一致。
The route crosses a neighbour's lot, state land, a drain or a reserve without written approval.
路线跨越邻地、政府土地、排水沟或保留地,却没有书面批准。
The document grants only pedestrian access or contains a narrow vehicle definition.
文书只授权人行,或车辆定义过于狭窄。
The access depends on a gate or road controlled by a private party with no durable obligation to keep it open.
出入口依赖私人控制的闸门或道路,却没有长期保持开放的义务。
The lender, planner, engineer and lawyer are each assuming that someone else verified access.
银行、规划师、工程师与律师都以为别人已经核实出入口。
A five-gate acquisition decision 五个收购决策关口
Legal gate: The title reaches a public road or has a valid, registrable vehicle right.
法律关口: 地契直接连接公共道路,或拥有有效且可注册的车辆通行权。
Planning gate: The proposed access and industrial use can obtain planning approval.
规划关口: 拟议出入口与工业用途可取得规划批准。
Engineering gate: Drainage, levels, gradients, culverts and sight distance are workable.
工程关口: 排水、标高、坡度、涵洞与视距均可行。
Operations gate: Target trucks, emergency vehicles, staff and utilities can use the route.
营运关口: 目标货车、紧急车辆、员工与公用设施可使用该路线。
Commercial gate: Cost, delivery time, maintenance and residual risk fit the investment case.
商业关口: 成本、交付时间、维修责任与剩余风险符合投资逻辑。
If any gate remains unproven, price the uncertainty, make it a condition precedent, or choose another site.
如果任何一个关口尚未证实,应把不确定性计入价格、列为交易先决条件,或选择另一地块。
A note for China-based manufacturers and investors
给中国制造商与投资者的特别提醒
Chinese headquarters often receive a location pin, aerial photograph and site brochure long before they receive a certified title or registered access instrument.
中国总部往往先收到定位、航拍图及项目简介,过后才看到认证地契或已注册通行文书。
That sequence can create false confidence.
这种次序很容易造成过度信心。
Ask the Malaysia team to present a single bilingual access pack that links the title boundary, road status, registered rights, planning approvals, engineering drawings, truck model and delivery timeline.
应要求马来西亚团队提供一套双语出入口证据包,把地契边界、道路状态、注册权利、规划批准、工程图、车辆模型及交付时间串联起来。
The board question should not be “Is there a road?”
董事会不应只问“那里有路吗?”
It should be: “Show us the legal right, the approved design and the operating proof.”
而应要求:“请展示合法权利、获批设计与营运证明。”
Frequently Asked Questions 常见问题
1. Is a road shown on Google Maps proof of legal access? Google地图上显示道路,是否证明拥有合法通行权?
No. 不是。
It shows physical mapping, not title frontage, road ownership, a registered easement or planning approval.
地图只显示实体路线,并不证明地契临路、道路所有权、已注册地役权或规划批准。
Verify the land records and approvals.
必须核实土地记录与相关批准。
2. Does long-term use create an easement in Malaysia? 在马来西亚长期使用某条路,会自动产生地役权吗?
Generally no. 一般不会。
Section 284 of the National Land Code states that no right capable of being granted as an easement may be acquired by prescription, and easements are not implied from a transfer.
《国家土地法典》第284条规定,可作为地役权授予的权利不得仅因长期使用而取得,转让也不会自动默示产生地役权。
Obtain legal advice on the specific facts.
具体个案应咨询律师。
3. What is the difference between an easement and a Land Administrator's right of way? 地役权与土地行政官通行权有什么不同?
An easement is generally an expressly granted and registered right benefiting one land over another.
地役权通常是某地块对另一地块明确授予并注册的权利。
A Land Administrator's right of way is created through the statutory Part 28 process and may be private or public, subject to an order, route and conditions.
土地行政官通行权则通过第28部分的法定程序设立,可属私人或公共,并受命令、路线及条件约束。
4. If the land fronts a public road, is approval automatic? 若土地直接临公共道路,出入口是否自动获批?
No. 不是。
The access point, drain crossing, road geometry, sight distance and proposed development may still require planning and technical approval.
出入口位置、跨沟、道路几何、视距及拟议发展仍可能需要规划与技术批准。
5. Is a pedestrian right enough for factory access? 人行通道权是否足够供厂房使用?
No. 不足够。
The National Land Code distinguishes a footway from a carriageway.
《国家土地法典》区分人行通道与车行通道。
The instrument must support the vehicles and users required for the operation.
注册文书必须支持营运所需的车辆及使用者。
6. Who normally pays to build and maintain a private right of way?
私人通行道路通常由谁承担建设与维修费用?
The registered instrument or Land Administrator's order should be checked.
必须查看注册文书或土地行政官命令。
Under section 392, the proprietor benefiting from a private right of way bears survey, construction, maintenance and repair costs, subject to the statutory framework and any sharing arrangement.
根据第392条,享有私人通行权的业主须承担测量、建设、维护及维修费用,但仍受法定框架及任何分担安排约束。
7. Can access problems affect financing? 出入口问题会影响融资吗?
Yes. 会。
A lender may question marketability, valuation, enforceability and the ability to operate or sell the site.
银行可能质疑资产的可销售性、估值、权利可执行性,以及地块能否营运或转售。
Obtain lender acceptance before waiving access-related conditions.
在放弃任何出入口相关先决条件前,应先取得贷款银行确认。
8. What should a buyer complete before paying a non-refundable deposit? 支付不可退订金前,买方至少应完成什么?
At minimum, obtain preliminary title and survey verification, identify the road owner, review registered access rights, discuss planning feasibility and test the intended heavy-vehicle route.
至少应先核实地契与测量资料、确认道路业主、审查已注册通行权、讨论规划可行性,并测试目标重型车辆路线。
The sale terms should protect the buyer while final evidence and approvals are obtained.
买卖条款应在最终证据及批准落实期间保护买方。
Final view 最后观点
Industrial land is not truly connected merely because a road is visible.
看得到道路,并不代表工业地真正连接道路。
A defensible acquisition requires a chain of proof from title to public road, from legal right to approved access, and from approved access to workable operations.
稳健收购需要一条完整证据链:从地契连接公共道路,从合法权利连接获批出入口,再从获批出入口连接实际营运。
Resolve that chain before the land price, construction programme or factory launch makes delay expensive.
应在地价、建设进度或投产计划令延误变得昂贵之前,把这条证据链落实清楚。
XPillar helps businesses discover Malaysian factories, warehouses and industrial land.
XPillar协助企业寻找马来西亚厂房、仓库及工业土地。
Property-specific legal, planning, engineering, tax and financing advice should be obtained from qualified professionals before a transaction.
