Can You Buy 20 Acres Out of a 60-Acre Industrial Title in Malaysia? | 可以只购买马来西亚60英亩工业地中的20英亩吗?

How subdivision, amalgamation, access, utilities, financing and transaction conditions determine whether a proposed portion can become a usable, transferable industrial site.

Aug 28, 2026
Can You Buy 20 Acres Out of a 60-Acre Industrial Title in Malaysia? | 可以只购买马来西亚60英亩工业地中的20英亩吗?

A coloured sketch can identify the portion a seller intends to sell, but it does not create a separate title. This bilingual guide explains how industrial buyers, manufacturers, data-centre developers and logistics users can structure a partial-land acquisition around evidence, approvals and a workable fallback.

Answer first/ 先说结论

Yes, a buyer may be able to acquire a defined portion of a larger industrial holding, but the seller's sketch, fence line or promise to “cut out 20 acres” is not itself a separate registrable title.
可以买,但地主提供的示意图、现有围篱或“从60英亩切出20英亩”的承诺,本身并不是可登记的独立地契。

In a conventional partial-land acquisition, the current registered proprietor normally has to pursue the appropriate land process, obtain the necessary approvals, complete the survey and title work, address any charge or restriction, and deliver a title or registrable interest that matches the agreed site.
一般局部土地收购中,现有注册地主通常需要采用正确的土地程序、取得相关批准、完成测量与地契工作、处理抵押或利益限制,并交付与约定地块相符的地契或可登记权益。

Until the structure is confirmed for the specific land, the buyer should treat the proposed portion as a project—not as a finished property product.
在具体土地的法律结构获得确认以前,买家应把拟购买部分视为一个仍在推进的项目,而不是已经完成的物业产品。

This distinction matters most when a manufacturer, logistics operator or data-centre developer wants only the best frontage, the land nearest a substation, or one phase of a much larger estate.
这项区别对制造商、物流企业或数据中心发展商尤其重要,因为买家往往只想购买临路位置最好、靠近变电站,或大型园区中的第一期土地。

The commercial question is not merely:
真正的商业问题不只是:

“Can the owner sell this area?”
“地主愿不愿意卖这部分?”

It is:
而是:

“Can this exact area become a legally transferable, independently accessible and operationally complete industrial site within the buyer's required timeline?”
“这一个准确范围,能否在买家所需期限内,成为可合法转让、拥有独立出入口并具备完整营运条件的工业地块?”
Scope note: This article explains a practical due-diligence framework and is not legal advice. The National Land Code framework discussed here generally concerns Peninsular Malaysia. Sabah and Sarawak use different land laws, and state procedures, local planning rules and approval conditions vary.
适用范围说明: 本文提供实务尽调框架,不构成法律意见。文中所述《国家土地法典》框架一般适用于马来西亚半岛;沙巴与砂拉越采用不同土地法律,各州程序、地方规划规则及批准条件也会有所不同。

Engage a Malaysian conveyancing lawyer, registered land surveyor and relevant planning/engineering professionals for the actual site.
具体地块应由马来西亚房地产律师、注册土地测量师及相关规划与工程专业人士处理。

Article image

First identify the correct land process
先确定正确的土地程序

Malaysian land terminology is not interchangeable.
马来西亚土地术语不能互相替代。

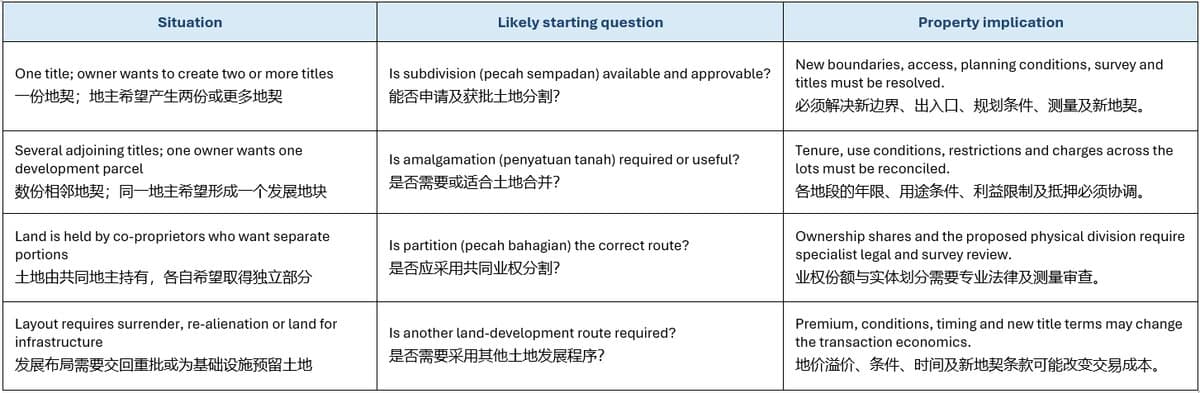

In Selangor's official explanation, pecah sempadan means subdividing land held under one final title into two or more parts that remain held by the same proprietor or the same co-proprietors.
根据雪兰莪州土地与矿务局的官方说明,**pecah sempadan(土地分割)**是把一份永久地契下的土地分成两个或以上部分,而分割后的各部分仍由同一地主或相同的共同地主持有。

The state portal identifies the application route under section 137 of the National Land Code and states that the registered proprietor makes the application.
官方页面把申请列于《国家土地法典》第137条,并说明由注册地主提出。

Penyatuan tanah, or amalgamation, is a different process: two or more adjoining lots held under separate titles by one owner are combined and held under one title.
**Penyatuan tanah(土地合并)**则是另一项程序:由同一地主持有、拥有不同地契的两个或以上相邻地段,合并成一份地契。

Selangor identifies this route under section 148.
雪兰莪州把这项程序列于第148条。

Pecah bahagian is also different. It deals with partition among co-proprietors rather than merely drawing smaller lots for the same owner.
**Pecah bahagian(共同业权分割)**同样不同。它处理共同地主之间的业权划分,而不只是由同一地主把土地切成较小地段。

JKPTG's Circular No. 8/2026, dated 7 August 2026, specifically addresses improvements to applications under sections 140–145.
JKPTG于2026年8月7日发布的第8/2026号通告,专门说明第140至145条申请流程的改进。

That current circular is a useful reminder that the registered ownership structure changes which route is relevant.
这份最新通告提醒买家:注册业权结构不同,适用程序也会不同。

Article image

The table is a screening tool, not a substitute for title-specific advice.
以上表格只用于初步筛选,不能取代针对具体地契的专业意见。

Do not let a marketing term such as “20-acre split lot” decide the legal route.
不要让“20英亩分割地”这类营销用语决定法律程序。

A sketch is a negotiation tool—not title evidence
示意图是谈判工具,不是地契证据

A seller's colour plan can be useful for discussing frontage, shape and price.
地主提供的彩色平面图有助于讨论临路宽度、地形及价格。

It should not be treated as proof that the area is separately transferable, that its acreage is final, or that authorities will approve the proposed layout.
但不能证明该范围可以独立转让、面积已经确定,或有关当局一定会批准拟议布局。

The first technical exercise should align four layers:
第一项技术工作应把以下四个层面互相对照:

The registered title and cadastral information — lot number, registered area, tenure, land-use category, express conditions, restrictions, charges and caveats.
注册地契与地籍资料 —— 地段号码、登记面积、年限、土地用途类别、明文条件、利益限制、抵押及私人禁令。

The surveyed ground position — boundary marks, occupation, encroachments, terrain and measured dimensions.
现场测量位置 —— 界石、实际占用、越界情况、地形及实测尺寸。

The proposed planning and engineering layout — roads, drains, buffers, utility reserves, detention ponds, setbacks and platform design.
拟议规划与工程布局 —— 道路、排水、缓冲区、公用设施保留地、蓄洪池、建筑退界及地台设计。

The commercial sale area — the portion for which the buyer is expected to pay and accept title risk.
商业交易面积 —— 买家预计付款并承担地契风险的实际范围。

Use a registered land surveyor for cadastral work.
地籍测量应由注册土地测量师负责。

The Land Surveyors Board publishes a current search facility for registered land surveyors; this is a more reliable starting point than appointing a general contractor to mark a boundary.
马来西亚土地测量师委员会提供最新的注册土地测量师查询工具;相比让一般承包商自行标界,这才是更可靠的起点。

Calculate the net usable land—not only the headline acres
计算净可用土地,而不只是宣传面积
The proposed 20 acres may not remain 20 acres of usable industrial platform.
拟出售的20英亩,不一定最终拥有20英亩可用工业地台。

An authority-approved layout may require land or space for access, road widening, drains, utility corridors, slope treatment, retention ponds, landscape buffers, fire access or other infrastructure.
获批布局可能需要预留出入口、道路拓宽、排水、公用设施走廊、边坡处理、蓄洪池、绿化缓冲、消防通道或其他基础设施。

JKPTG's 2021 guidance concerning access in subdivision and partition applications confirms that access arrangements form part of the statutory land process.
JKPTG在2021年有关土地分割及共同业权分割申请中出入口处理的指引,说明出入口安排属于法定土地程序的一部分。

Buyers should therefore insist on a site-specific access solution rather than assume that an informal road can continue.
买家应要求针对具体地块落实出入口方案,而不是假设现有非正式道路可以继续使用。

Before fixing the total price, agree how area will be measured and adjusted.
在确定总价前,应先约定面积如何测量及如何调整。

A practical commercial formula may distinguish:
实用的商业计算方式可以区分:

- registered area on the eventual title;
 最终新地契上的登记面积;
- gross surveyed area before required reserves or surrender;
扣除必要保留地或交地以前的测量总面积;
- net developable area after planning and engineering constraints; and
扣除规划与工程限制后的净可发展面积;以及
- net operational platform available for buildings, yards and expansion.
实际可供建筑、操作场地及扩建使用的净地台面积。

The SPA should state which measurement controls the price, what tolerance is acceptable, who pays for survey and infrastructure, and whether the buyer can terminate or obtain a price adjustment if the final site is materially smaller or differently shaped.
买卖协议应说明以哪一种面积作为计价依据、可接受误差是多少、测量及基础设施费用由谁承担,以及最终地块若明显缩小或形状改变,买家能否终止交易或调整价格。

Article image

Secure legal access and utility corridors
确保合法出入口与公用设施走廊

An industrial parcel is not operationally independent merely because a truck can reach it today.
货车今天能够到达,并不代表该工业地块在营运上已经独立。

The approved and registrable arrangement must support the buyer's entire operating model, including construction traffic and future expansion.
获批及可登记的安排必须支持买家的完整营运模式,包括施工车辆及未来扩建。

Confirm, in writing and on plans:

应以书面及图则确认:
- the legal point of access to a public or properly maintained road;
通往公共道路或获妥善维护道路的合法出入口位置;
- road width, turning geometry, bridge or culvert capacity and gate position;
道路宽度、转弯几何、桥梁或涵洞承载及闸门位置;
- drainage discharge route and rights to construct and maintain drains;
排水出口路径,以及建设与维护排水设施的权利;
- power, water, sewerage, gas and fibre routes, including easements or wayleaves where required;
电力、供水、排污、天然气及光纤路径,包括所需地役权或通行权;
- ownership and maintenance responsibility for shared infrastructure; and
共用基础设施的所有权与维护责任;以及
- whether the first buyer's infrastructure must also serve the seller's retained land.
第一位买家建设的基础设施,是否也必须服务地主保留的土地。

For a power-intensive factory or data-centre campus, the cheapest-looking portion may become the most expensive if the grid connection, water line or fibre route must cross land that the buyer will not own.
对于高用电工厂或数据中心园区,表面上最便宜的地块,若电网接入、供水管线或光纤必须穿越买家不拥有的土地,最终可能最昂贵。

Secure the corridor before treating the site as utility-ready.
在把地块视为“公用设施就绪”以前,应先落实走廊权利。

Check title conditions, planning and the future lot shape together 同时审查地契条件、规划及未来地块形状
Subdivision does not itself approve a factory, warehouse, logistics hub or data centre.
土地分割本身并不会批准建设厂房、仓库、物流枢纽或数据中心。

The proposed use must still align with the title category and express conditions, the applicable development plan and planning-control process, and later building and technical approvals.
拟议用途仍必须符合地契土地类别与明文条件、适用的发展规划及规划管制程序,以及后续建筑和技术审批。

The buyer's concept plan should be tested against the future lot, not the original parent title.
买家的概念规划必须以未来新地段为基础,而不是原来的母地契。

A boundary that looks efficient for acreage may create poor setbacks, an unusable narrow tail, inadequate fire access, a landlocked utility compound or an expensive retaining wall.
为了凑足面积而画出的边界,可能造成退界不足、狭长尾地无法使用、消防通道不足、公用设施区被围困,或需要昂贵挡土墙。

A larger but well-shaped lot can be more valuable than a nominally cheaper irregular portion.
面积较大、形状良好的地块,可能比名义上便宜但不规则的地块更有价值。

Resolve charges, caveats and partial discharge early 尽早处理抵押、私人禁令与局部解押
If the parent title is charged to a financier, the seller cannot assume that a new portion will be released automatically.
如果母地契已抵押给金融机构,地主不能假设新分出的地块会自动获释。

The bank may need to approve the subdivision, the proposed lot, the redemption sum and the partial-discharge mechanics.
银行可能需要批准土地分割、拟议地段、赎回金额及局部解押机制。

Existing caveats, leases, easements or other registered interests may also affect the application or eventual transfer.
现有私人禁令、租约、地役权或其他登记权益,也可能影响申请或最终转让。

Before paying a large non-refundable deposit, obtain a current title search and require documentary evidence of the chargee's position.
在支付大额且不退还的订金以前,应取得最新地契查询,并要求提供抵押权人立场的书面证据。

The transaction documents should identify/ 交易文件应明确:
- who obtains financier consent and by when;
由谁在何时取得金融机构同意;
- the method for determining and paying the partial redemption sum;
局部赎回金额如何确定及支付;
- how the new title will be discharged and transferred; and
新地契如何解除抵押及转让;以及
- what happens if the bank's conditions make the deal uneconomic.
如果银行条件令交易失去经济可行性,应如何处理。

Article image

Make the SPA conditional on evidence—not optimism
让买卖协议以证据为条件,而不是依赖乐观预期

A partial-land SPA normally needs more project management than a completed-title purchase.

局部土地买卖协议通常比购买已有独立地契的土地需要更多项目管理。

Depending on legal advice and the site's structure, conditions precedent may cover:

根据法律意见及地块结构,先决条件可包括:

- approval of the agreed subdivision, partition, amalgamation or alternative land route;

批准约定的土地分割、共同业权分割、土地合并或其他土地程序;

- planning or layout outcomes consistent with the buyer's minimum developable area;

规划或布局结果符合买家的最低可发展面积;

- issuance of a new title with acceptable tenure, category, conditions and restrictions;

发出在年限、类别、条件及利益限制方面可接受的新地契;

- a final survey within agreed area and shape tolerances;

最终测量面积及形状在约定误差范围内;

- legal access and secured utility/drainage corridors;

合法出入口,以及已落实的公用设施与排水走廊;

- state, financier and other third-party consents where required;

取得所需州政府、金融机构及其他第三方同意;

- satisfactory title search and removal or acceptance of encumbrances; and

地契查询结果令人满意,并处理或接受相关产权负担;以及

- a long-stop date, extension mechanism, refund rules and termination rights.

最后期限、延期机制、退款规则及终止权。

The agreement should also allocate responsibility for consultants, premiums, survey fees, infrastructure, authority contributions, taxes and delay.

协议也应分配顾问费、溢价、测量费、基础设施、当局缴款、税务及延误责任。

If the buyer needs early possession for soil investigation or design, use a controlled access licence that addresses insurance, damage, confidentiality and reinstatement.

如果买家需要提前进入土地进行土质调查或设计,应使用受控进场许可,处理保险、损坏、保密及恢复原状等事项。

Early entry should not be confused with ownership.

提前进场不能被误解为已经取得业权。

Use decision gates for a partial-land acquisition
为局部土地收购设置决策关口

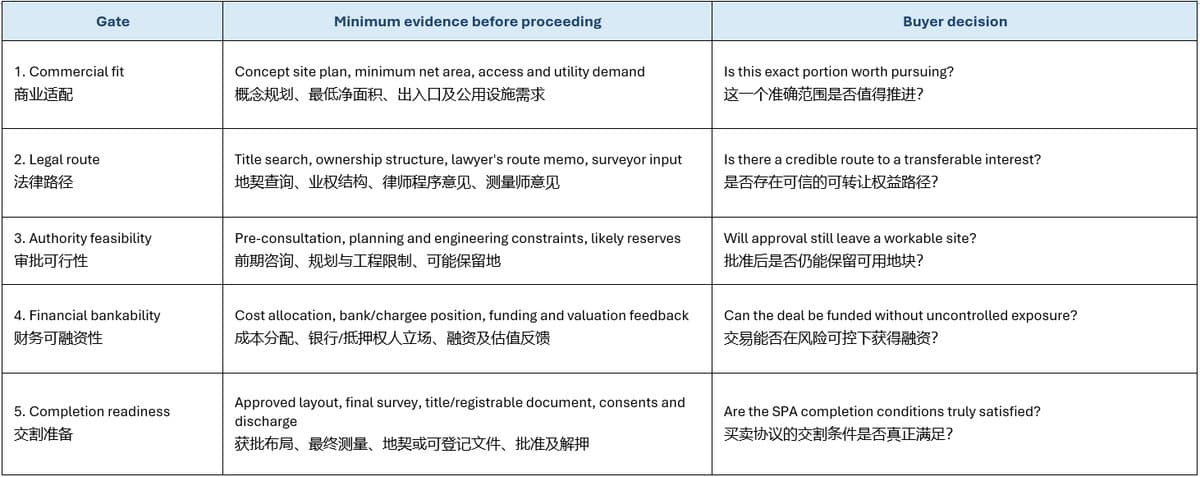

Article image

These gates allow a buyer to spend progressively.
这些关口让买家分阶段投入成本。

Expensive design, power studies or financing commitments should follow—not precede—the evidence needed to justify them.
昂贵设计、电力研究或融资承诺,应在取得足够证据以后才进行,而不是提前承担。

A practical document request 实用文件索取清单
Ask the seller or authorised representative for the following at the start:
交易初期应向地主或获授权代表索取:
- latest title and current official title search;
最新地契及当前正式地契查询;
- cadastral plan and any existing survey or proposed layout;
地籍图、现有测量图及拟议布局;
- ownership and corporate-authority documents;
业权及公司授权文件;
- details of charges, caveats, leases and other registered interests;
抵押、私人禁令、租约及其他登记权益资料;
- written status of any subdivision, partition, amalgamation, planning or surrender application;
土地分割、共同业权分割、合并、规划或交地申请的书面状态;
- authority correspondence and consultant submissions;
有关当局往来信函及顾问呈交文件;
- proposed road, drainage and utility-reserve plans;
拟议道路、排水及公用设施保留图;
- financier consent or in-principle partial-discharge position; and
金融机构同意或原则上的局部解押立场;以及
a cost-and-responsibility matrix with target dates.
- 载明目标日期的成本与责任矩阵。

If these documents do not exist, the correct response is not automatically to reject the land.
如果这些文件尚不存在,并不一定必须立即放弃该土地。

It is to price the uncertainty, control deposits and make the next expenditure conditional on a defined evidence milestone.
正确做法是把不确定性计入价格、控制订金,并把下一阶段支出与明确的证据里程碑挂钩。

Final perspective 最后观点
Buying 20 acres out of a 60-acre industrial title can be commercially sensible, especially for phased manufacturing, logistics or data-centre development.
从60英亩工业地契中购买20英亩,可能非常符合分期制造、物流或数据中心发展的商业需要。

The deal becomes dangerous when parties price and schedule it as though the new lot already exists.
真正危险的是,交易双方在新地段尚未形成时,就按“新地契已经存在”的方式定价及安排时间。

The strongest acquisition strategy connects the legal route, survey, planning layout, infrastructure, financier requirements and SPA conditions into one project plan.
最稳健的收购策略,是把法律程序、测量、规划布局、基础设施、金融机构要求及买卖协议条件,整合成一份项目计划。

Do not buy a coloured polygon.
不要只购买图上的彩色范围。

Buy a route to a usable, transferable industrial site—and make every payment follow evidence.
应购买一条能够形成可使用、可转让工业地块的可执行路径,并让每一笔付款都跟随证据。

Frequently Asked Questions 常见问题
1. Can I sign an SPA before the new industrial title is issued? 新工业地契发出以前可以签买卖协议吗?
Potentially, but the agreement must be prepared by Malaysian lawyers for the actual structure.
有可能,但协议必须由马来西亚律师按照实际结构拟定。

It should clearly identify the proposed portion, required approvals, area tolerance, title outcome, access, costs, deposits, long-stop date, refund and termination rights.
协议应清楚列明拟购买范围、所需批准、面积误差、新地契结果、出入口、费用、订金、最后期限、退款及终止权。

Signing early does not remove subdivision or title risk.
提前签约并不会消除土地分割或地契风险。

2. Is the seller's survey sketch enough to fix the purchase area? 地主提供的测量示意图足以确定购买面积吗?
No.不足。

Use it as a proposal.
该图只能作为建议范围。

Final pricing and completion should refer to the agreed survey standard, approved layout and eventual registered area or another carefully defined measurement basis.
最终计价及交割应以约定测量标准、获批布局、最终登记面积或另一项清楚定义的面积基础为准。

3. Who applies for subdivision in Malaysia? 马来西亚土地分割由谁申请?
For Selangor's section 137 subdivision route, the official state portal states that the landowner makes the application.
雪兰莪州第137条土地分割程序的官方页面说明,由地主提出申请。

The applicable route and documents must still be confirmed for the title and state concerned.
但具体地契及所在州属的适用程序与文件仍须另行确认。

4. What if the parent title is charged to a bank? 如果母地契已抵押给银行怎么办?
Obtain the financier's position early.
应尽早取得金融机构的立场。

Subdivision, partial redemption, partial discharge and transfer mechanics may require its consent and conditions.
土地分割、局部赎回、局部解押及转让机制可能需要银行同意并遵守相关条件。

Do not assume a deposit will persuade the bank to release the proposed lot.
不要假设支付订金后,银行就一定会释放拟购买地段。

5. Does subdivision approval mean I can build a factory or data centre? 土地分割获批是否代表可以建设工厂或数据中心?
No.不代表。

The intended development still needs to satisfy title conditions, planning controls and the required building, engineering, environmental, utility, safety and activity-specific approvals.
拟议发展仍须符合地契条件、规划管制,以及所需建筑、工程、环境、公用设施、安全及行业特定审批。
