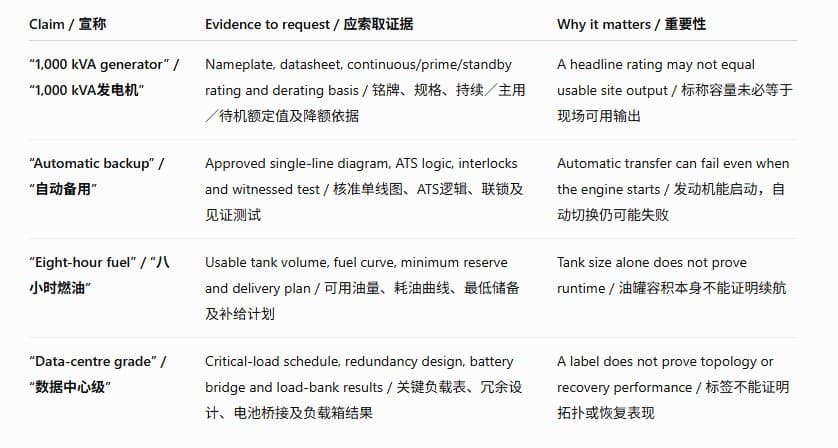

Answer first 先说结论
An existing generator does not prove that a Malaysian factory, warehouse or data centre has dependable backup power.
现场已有发电机,不能证明马来西亚厂房、仓库或数据中心拥有可靠的备用电力。
The unit may be undersized, registered under another installation owner, unable to start critical motors, disconnected from the correct loads, short of usable fuel, restricted by noise or exhaust conditions, or never tested under realistic load.
设备可能容量不足、登记在另一名装置拥有人名下、无法启动关键马达、没有连接正确负载、可用燃油不足、受到噪音或排气条件限制,或从未在真实负载下测试。
Before committing to the property, verify the complete chain: critical load → generator rating → starting and step load → ATS or synchronising controls → protection and earthing → electrical registration → fuel storage and delivery → ventilation and exhaust → noise and vibration → fire interface → load testing → contractual handover.
承诺物业前,应核实完整证据链:关键负载 → 发电机额定值 → 启动与阶跃负载 → ATS或并联系统 → 保护与接地 → 电气装置登记 → 燃油储存与补给 → 通风与排气 → 噪音与振动 → 消防联动 → 带载测试 → 合同交接。
Malaysia's Energy Commission states that electrical installations generally require registration under section 21 of the Electricity Supply Act 1990 unless exempted.
马来西亚能源委员会说明,除获豁免者外,电气装置一般须根据《1990年电力供应法令》第21条登记。
Its ECOS registration guidance expressly includes a standby generating set installed to supply energy when a licensee's supply is interrupted, and requires an online update when a registered installation is enlarged or modified.
其ECOS登记指南明确包括在持牌供电者停电时供电的待机发电机;已登记装置如扩建或改动,也须在线更新。
A registration certificate is also not transferable without the Commission's permission.
登记证书未经能源委员会批准也不得转让。
These points make registration and ownership evidence transaction issues, not paperwork to examine only after occupation.
因此,登记与拥有人证据属于交易事项,而不应等到入驻后才处理。

What “generator-ready” should mean“发电机就绪”应具备什么条件
“Generator-ready” should mean that a defined set of loads can be supported for a defined duration and restored within a defined time, with compliant electrical, fuel, environmental and fire arrangements.
“发电机就绪”应表示:一组明确的负载可在明确时长内获得支持,并在明确时间内恢复,同时具备合规的电气、燃油、环境与消防安排。
It should not mean merely that a genset appears in a listing photograph.
它不应只表示房源照片里出现了一台发电机。

Twelve checks before buying or leasing购买或租赁前的12项检查
1. Define the critical load before sizing the generator 先定义关键负载,再确定发电机容量
Separate life-safety loads, process-protection loads and business-continuity loads.
应区分生命安全负载、工艺保护负载及业务连续性负载。
Fire pumps, smoke-control systems, emergency lighting, servers, chilled-water systems, refrigeration, production lines and office loads have different priorities.
消防泵、排烟系统、应急照明、服务器、冷冻水系统、冷库、生产线和办公室负载的优先级不同。
Ask for a load schedule showing kW, kVA, power factor, starting method, starting current and the proposed sequence of connection.
应索取负载表,列明kW、kVA、功率因数、启动方式、启动电流及拟定接入顺序。
2. Verify the rating—and every derating assumption 核实额定值及所有降额假设
Confirm whether the quoted number is standby, prime or continuous power.
确认报价容量属于待机、主用还是持续功率。
Then check ambient temperature, ventilation resistance, altitude, fuel quality, alternator limit and allowable load steps.
再核对环境温度、通风阻力、海拔、燃油质量、交流发电机限制及允许阶跃负载。
For sensitive electronics, also examine voltage and frequency recovery, harmonic effects and the compatibility of UPS systems with the generator.
对于敏感电子设备,还应检查电压与频率恢复、谐波影响,以及UPS与发电机的兼容性。
3. Prove motor-starting and step-load performance 证明马达启动与阶跃负载能力
A generator that carries a stable 500 kW load may still stall or suffer unacceptable voltage dip when a large chiller, compressor, pump or conveyor starts.
能够稳定承载500 kW的发电机,仍可能在大型冷水机、空压机、水泵或输送机启动时熄火,或产生不可接受的电压骤降。
Request the starting study, load-sequencing logic and test results.
应索取启动研究、负载顺序逻辑与测试结果。
If no study exists, model the proposed operation before treating the generator as adequate.
若没有研究,应先模拟拟定营运方式,再判断容量是否足够。
4. Inspect the ATS, synchronising and isolation architecture 检查ATS、并联系统与隔离架构
Confirm which board and circuits are actually backed up.
应确认实际获得备用电力的是哪一个配电盘及哪些回路。
Review normal and emergency incomers, ATS ratings, mechanical/electrical interlocks, bypass arrangements, neutral switching, synchronising controls, anti-backfeed protection and safe isolation.
并审查常用与应急进线、ATS额定值、机械/电气联锁、旁路、中性线切换、并联控制、防倒送保护及安全隔离。
A generator must not energise a network in an unintended direction.
发电机不得以非预期方向向网络送电。
The Energy Commission's Non-Domestic Electrical Installation Safety Code addresses generator earthing, protection coordination and emergency-power integrity.
能源委员会《非住宅电气装置安全规范》涵盖发电机接地、保护协调及应急电源完整性。
5. Match the installation registration to the present system and owner 让电气装置登记对应现有系统与拥有人
Request the current Form B registration certificate, installation capacity, registered owner or management entity, expiry date, competent-person details and the latest approved schematic.
应索取现行Form B登记证书、装置容量、登记拥有人或管理实体、到期日、合资格人员资料及最新核准图。
Compare them with the installed generator, switchgear and any later extension.
并与现场发电机、开关设备及后续扩建逐项比对。
Because the registration certificate is not automatically transferable, include the required Energy Commission process in the transaction timetable.
由于登记证书不会自动转让,交易时间表应纳入能源委员会所需程序。
6. Confirm who may design, install, test and operate it 确认谁可设计、安装、测试及操作
The ECOS guidance requires plans, schematic drawings and specifications signed according to the competent person's voltage/current limits, together with prescribed completion and testing certification.
ECOS指南要求,图则、单线图与规格须由权限符合相关电压/电流等级的合资格人员签署,并附上规定的完工与测试证明。
Confirm the electrical contractor, competent person and maintenance provider.
应确认电气承包商、合资格人员及维保供应商。
Verify that their scope includes the whole generator-to-load path rather than the engine alone.
并核实其工作范围覆盖从发电机到负载的完整路径,而不只是发动机。

7. Calculate usable fuel autonomy—not nominal tank volume 计算可用燃油续航,而非只看油罐名义容积
Use the manufacturer's consumption curve at realistic loading.
应按真实负载采用制造商耗油曲线。
Deduct unusable volume, minimum reserve, expansion allowance and operational constraints.
并扣除不可用油量、最低储备、膨胀空间及营运限制。
Then test whether fuel can be delivered during a prolonged outage, including tanker access, delivery hours, security, hose route, pump duty, transfer controls and fuel-quality management.
然后验证长时间停电时能否补给燃油,包括油罐车通道、送油时段、保安、软管路线、泵能力、输送控制及燃油品质管理。

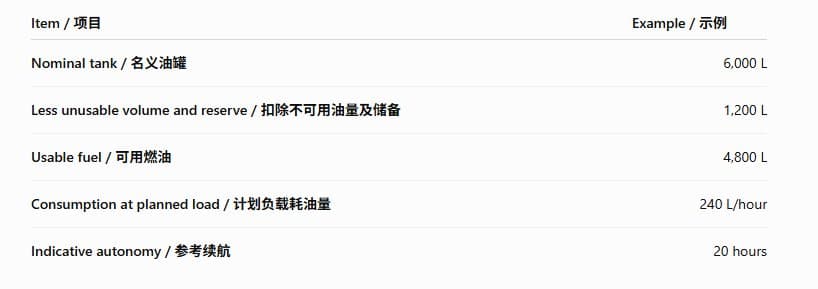

Illustrative runtime calculation续航示例(仅供说明)

This is not a universal design figure.
这不是通用设计数值。
Actual consumption and reserve policy must be confirmed for the exact engine, load and operating objective.
实际耗油量与储备政策必须按具体发动机、负载及营运目标确认
8. Verify diesel-storage and delivery approvals 核实柴油储存与补给批准
Identify every bulk tank, day tank, transfer pump, pipe and filling point.
应识别所有散装油罐、日用油罐、输送泵、管道及加油点。
Check capacity, product, location, bunding, drainage isolation, overfill prevention, leak control and vehicle impact protection.
并检查容量、油品、位置、围堰、排水隔离、防溢、泄漏控制及车辆撞击保护。
DOSH's Petroleum Safety Division supports local authorities in petroleum storage and operating-licence processes, inspects storage/handling premises and reviews equipment, structures, installations and atmospheric bulk-tank designs.
DOSH石油安全部门为地方政府的石油储存及营运许可提供支持,也检查储存/处理场所,并审查设备、结构、装置及常压散装油罐设计。
Confirm the applicable PBT, DOSH and fire requirements for the exact arrangement.
应按准确配置确认适用的PBT、DOSH及消防要求。
Do not assume a small day tank and a bulk tank follow the same process.
不要假设小型日用油罐与散装油罐采用相同程序。

9. Check combustion air, heat rejection and exhaust 检查燃烧空气、散热与排气
The generator must receive adequate combustion and cooling air without recirculating hot discharge air.
发电机必须获得足够的燃烧与冷却空气,同时避免热风回流。
Verify room temperature under full load, louvre free area, fan duty, pressure drop, exhaust backpressure, insulation, flexible connections, rain protection and the position of the exhaust outlet relative to air intakes, roofs, boundaries and occupied areas.
应核实满载时机房温度、百叶有效面积、风机能力、压降、排气背压、保温、柔性连接、防雨,以及排气口与进风口、屋顶、边界及有人区域的相对位置。
DOE's Clean Air Regulations 2014 define an internal-combustion engine as fuel-burning equipment and apply to fuel-burning equipment and premises capable of discharging air pollutants.
DOE《2014年环境质量(清洁空气)条例》把内燃机定义为燃料燃烧设备,并适用于燃料燃烧设备及可能向空气排放污染物的场所。
Regulation 13(3) specifies limit values and technical standards for equipment rated to consume liquid or gaseous fuel at 15 kg/hour or more.
第13(3)条为额定消耗液体或气体燃料达到每小时15公斤或以上的设备规定排放限值与技术标准。
Regulation 5 also requires prior written notification for specified works or changes that may create or materially change an emission source.
第5条也要求,对可能新增或实质改变排放源的指定工程或改动提前书面通知。
The exact obligations should be confirmed against the proposed generator and operating mode.
实际义务应按拟用发电机与运行模式确认。
10. Measure noise and vibration in operating conditions 在实际运行条件下测量噪音与振动
Inspect acoustic enclosures, silencers, louvres, doors, flexible exhaust sections and anti-vibration mounts.
应检查隔音罩、消声器、百叶、门、柔性排气段及减振座。
Test at the property boundary and at sensitive internal spaces during daytime, night-time and full-load exercise where applicable.
并在适用情况下,于日间、夜间和满载演练时在物业边界及敏感室内空间测试。
Weekly no-load running may not reveal the noise, vibration or heat experienced during a prolonged outage.
每周空载运行未必能揭示长时间停电期间的噪音、振动与热量问题。
11. Check the building and fire interface 检查建筑与消防接口
Compare the generator room, enclosure, fuel system, openings, access route and fire-safety installations with the approved building and fire plans.
应把发电机房、隔音罩、燃油系统、开口、通道及消防设施与核准建筑和消防图则比对。
Verify fire detection, emergency stops, extinguishing provisions, separation, escape routes and whether later generator works affected the Fire Certificate basis.
并核实火灾探测、紧急停机、灭火配置、分隔、逃生路线,以及后续发电机工程是否影响消防证书基础。
BOMBA states that designated premises must hold a Fire Certificate; factories and storage premises can fall within the designated categories depending on size and configuration.
BOMBA说明,指定场所必须持有消防证书;厂房和仓储场所可能按面积及配置落入指定类别。
12. Witness a black-building and load-bank test—and write the handover 见证全楼断电与负载箱测试,并写清交接
Do not rely only on a successful engine start.
不要只凭发动机成功启动。
Agree a test script covering utility failure, start signal, time to acceptable voltage/frequency, ATS transfer, load sequence, step loads, alarms, cooling, fuel transfer, battery charger, safe shutdown and return to mains.
应预先制定测试程序,涵盖市电故障、启动信号、电压/频率恢复时间、ATS切换、负载顺序、阶跃负载、警报、冷却、燃油输送、电池充电、安全停机及恢复市电。
Where the operating load is too small or too sensitive, use a suitable load bank.
若营运负载太小或过于敏感,应使用合适负载箱。
Record readings, defects, corrective actions and a retest.
记录读数、缺陷、整改及复测结果。
The sale or lease should identify who owns the generator, tanks, cables and controls; who pays for rectification, fuel cleaning, registration updates and testing; whether warranties and maintenance contracts transfer; the minimum handover condition; and the remedy if the promised backup performance is not achieved.
买卖或租赁文件应明确:发电机、油罐、电缆与控制系统归谁所有;整改、燃油清洁、登记更新与测试由谁付费;保修和维保合同是否转移;最低交付状态;以及承诺的备用表现未实现时如何处理。

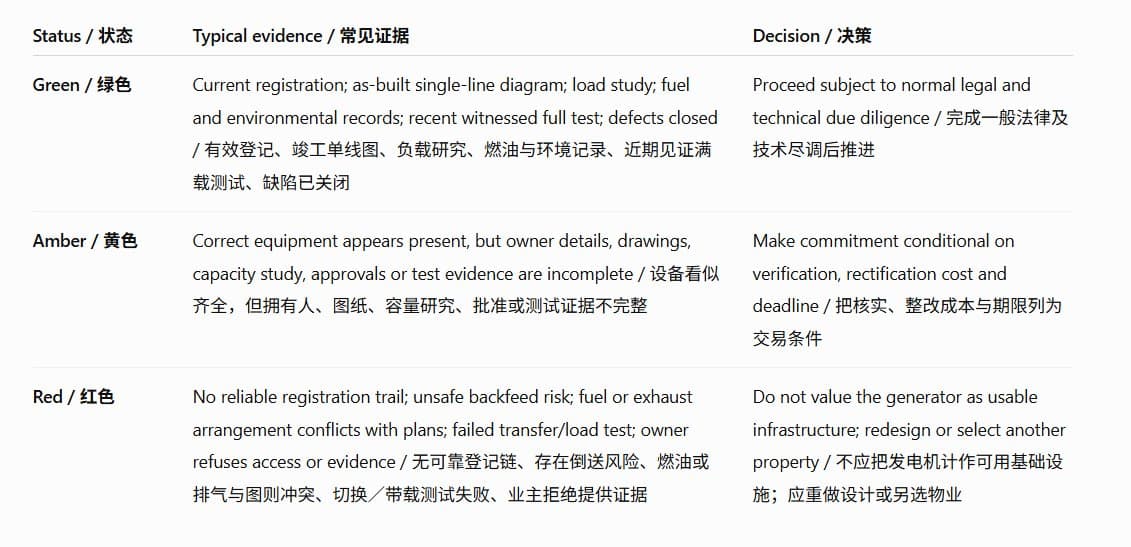

A practical red–amber–green decision framework实用红黄绿决策框架

Documents to request before signing签约前应索取的文件
Generator nameplate, datasheet, serial number, rating and maintenance history.
发电机铭牌、规格、序列号、额定值及维保记录。
Current Form B installation registration and competent-person records.
现行Form B电气装置登记及合资格人员记录。
Approved and as-built single-line diagrams, protection settings and ATS/synchronising logic.
核准及竣工单线图、保护设定与ATS/并联逻辑。
Critical-load schedule, starting study, short-circuit/protection study and earthing test.
关键负载表、启动研究、短路/保护研究及接地测试。
Fuel-tank drawings, approvals or licences, bund details, leak/overfill controls and delivery plan.
油罐图、批准或执照、围堰资料、防泄漏/防溢控制及补给计划。
Exhaust, ventilation, acoustic and vibration design records.
排气、通风、隔音及振动设计记录。
Approved building and fire plans, CCC/CFO and current Fire Certificate where applicable.
核准建筑与消防图、CCC/CFO及适用时的现行消防证书。
Load-bank and simulated-mains-failure test reports, alarm history and open defects.
负载箱与模拟市电故障测试报告、警报记录及未关闭缺陷。
Warranty, spare-parts, maintenance and emergency-callout arrangements.
保修、备件、维保及紧急支援安排。
Written transaction schedule allocating ownership, rectification, approval, testing and handover responsibility.
书面交易责任表,分配所有权、整改、批准、测试及交接责任。
Frequently Asked Questions常见问题
1. If the factory already has a generator, can the new tenant use it immediately?厂房已有发电机,新租户可立即使用吗?
Not safely as an assumption.
不能直接作此假设。
Confirm ownership and lease rights, installation registration, approved diagrams, competent-person coverage, fuel arrangements, maintenance condition and a witnessed transfer/load test.
应确认所有权及租赁使用权、电气装置登记、核准图、合资格人员、燃油安排、维保状态,并见证切换/带载测试。
A change of user or operation can also change the load and regulatory position.
使用者或营运改变,也可能改变负载及监管状态。
2. Is the generator's kVA rating enough to decide suitability? 只看发电机kVA额定值足够吗?
No. 不够。
Check kW, power factor, rating class, derating, motor starting, step loads, voltage/frequency recovery, alternator capacity, harmonics and the exact circuits connected.
还须检查kW、功率因数、额定类别、降额、马达启动、阶跃负载、电压/频率恢复、交流发电机能力、谐波及实际接入回路。
3. Does a standby generator need Energy Commission registration? 备用发电机是否需要能源委员会登记?
The ECOS guidance expressly includes a standby generating set installed to supply energy when the licensee's supply is interrupted within the installations addressed by its registration guidance.
ECOS登记指南明确把在持牌供电者停电时供电的待机发电机列入其登记指南所涵盖的装置。
Confirm the exact registration, exemption and licensing position with the Energy Commission and the appointed competent person for the specific site and configuration.
实际场地与配置的登记、豁免及发牌情况,应由能源委员会及受委合资格人员确认。
4. Can the seller's or landlord's registration simply pass to the buyer or tenant?卖方或业主的登记可直接转给买家或租户吗?
Do not assume so. 不要这样假设。
The Energy Commission states that an installation registration certificate is not transferable without its permission.
能源委员会说明,电气装置登记证书未经其批准不得转让。
Plan the required update or new application before completion or handover.
应在完成交易或交接前安排所需更新或新申请。
5. How many hours of diesel should be stored? 应储存多少小时的柴油?
There is no single property answer.
没有适用于所有物业的统一答案。
Set the autonomy objective from operational risk, outage scenario, fuel-delivery resilience, insurer or customer requirements and applicable approvals.
应按营运风险、停电情景、补给韧性、保险或客户要求及适用批准确定续航目标。
Calculate usable—not nominal—fuel against the manufacturer's consumption curve at the planned load.
再按计划负载的制造商耗油曲线计算可用燃油,而非名义容积。
6. Is weekly no-load testing sufficient? 每周空载测试足够吗?
No. 不足。
It can confirm basic starting but may not prove ATS transfer, protection coordination, step-load response, cooling, fuel transfer, exhaust, noise or endurance.
空载测试可确认基本启动,却未必证明ATS切换、保护协调、阶跃响应、冷却、燃油输送、排气、噪音或耐久表现。
Periodic realistic load testing is needed under a competent test plan.
应按合资格测试计划定期进行真实负载测试。
7. Does an acoustic canopy guarantee noise compliance? 隔音罩能保证噪音合规吗?
No. 不能。
Louvres, exhaust, doors, foundations, vibration paths, operating load, boundary distance and night-time background levels all affect the result.
百叶、排气、门、基础、振动传递路径、运行负载、边界距离及夜间背景噪音都会影响结果。
Measure the actual site under representative operation.
必须在代表性运行状态下进行现场测量。
8. Who should pay to rectify an inherited generator system? 接手的发电机系统需要整改时,谁应付费?
That is a negotiated transaction issue.
这是需要协商的交易问题。
The agreement should allocate the cost and deadline for registration updates, electrical corrections, fuel-system work, environmental/fire compliance, testing and replacement.
协议应分配登记更新、电气整改、燃油系统工程、环境/消防合规、测试与更换的费用及期限。
Avoid accepting “as is” language if usable backup power is material to the decision.
若可用备用电力是交易关键,不应在未设保护条件下接受“按现状交付”。
Final decision rule最终决策原则
Value a standby generator only after it has proved the required load, transfer time, runtime and compliance at the actual property.
只有当备用发电机在实际物业中证明所需负载、切换时间、续航及合规性后,才应把它计入物业价值。
Until the records match the hardware and the system passes a witnessed realistic test, treat it as equipment to be verified—not “free backup power” included with the building.
在文件与硬件完全对应、系统通过见证的真实测试之前,应把它视为待核实设备,而不是随建筑附送的“免费备用电力”。
This article provides general industrial-property due-diligence information, not legal, engineering, environmental or fire-safety advice.
本文提供一般工业物业尽调资料,不构成法律、工程、环境或消防安全意见。
Requirements depend on the exact installation, location, fuel arrangement, building and intended operation.
实际要求取决于具体装置、地点、燃油安排、建筑及拟定营运。
Obtain advice from the relevant authorities and qualified professionals before committing.
承诺交易前,应向有关主管机关与合资格专业人士取得意见。
