A practical due-diligence guide to planning conditions, industrial licensing, night-time noise, truck movements, utilities, shift work and emergency readiness.

Aug 28, 2026
Can This Malaysian Factory Operate 24/7? 12 Checks Before Buying or Leasing | 这间马来西亚厂房能否24小时营运?购买或租赁前的12项检查

Industrial zoning does not automatically guarantee round-the-clock operation. This bilingual guide explains the 12 checks a buyer or tenant should complete before committing to a factory intended for continuous production, night logistics or always-on infrastructure in Malaysia.

Answer first 先说结论
A factory in Malaysia may be capable of operating 24 hours a day, but an industrial title, an existing factory building or a previous operator’s night shift is not proof that a new occupier can lawfully and reliably run the same way.
马来西亚的厂房可能具备24小时营运条件,但“工业用途地契”“现成厂房”或“上一家租户曾上夜班”,都不能自动证明新买家或新租户可以合法、稳定地全天候营运。

Before buying or leasing, verify the approved land and building use, local-authority licence conditions, environmental noise exposure at night, nearby sensitive uses, truck movements, utility resilience, fire and emergency arrangements, employment requirements, and any lease or strata restrictions.
购买或租赁前,必须核实土地与建筑批准、地方政府执照条件、夜间环境噪音、周边敏感用途、货车流动、公用设施韧性、消防与应急安排、轮班用工,以及租约或分层管理限制。

For manufacturers, logistics operators, cold-chain users, automated warehouses and data-centre occupiers, this is not a minor operating detail. If the site cannot support night production or deliveries, the wrong property can reduce output, delay customer commitments and create expensive mitigation works after signing.
对制造商、物流公司、冷链企业、自动化仓库及数据中心用户来说,这不是次要问题。如果厂址不能支持夜间生产或收发货,错误选址可能压低产能、延误客户承诺,并在签约后产生高昂的隔音、交通或设施改造成本。

The safest approach is to define the proposed 24/7 operation first, then test the property against that exact operating profile. Do not rely only on the agent’s description, the current tenant’s practice or the word “industrial” on a listing.
最稳妥的方法,是先把拟议的24小时营运模式写清楚,再逐项验证物业能否承载。不要只依赖房产广告、经纪人口头说明或现有租户的做法。

Why “industrial” does not automatically mean 24/7
为什么“工业用途”不等于“可24小时营运”

Three separate questions are often confused:
很多人把三个不同的问题混在一起:

- Is industrial use permitted on the land and in the approved building?
土地及获批建筑是否允许有关工业用途?
- Can the proposed business obtain and comply with the relevant licences and approvals?
拟议企业能否取得并遵守所需执照与批准?
- Can the site operate at night without unacceptable noise, traffic, safety or utility risk?
厂址能否在夜间控制噪音、交通、安全及公用设施风险?

Malaysia’s planning framework requires development to comply with planning control under the Town and Country Planning Act 1976, while premises and business licensing is administered by the relevant local authority.
马来西亚的规划管制以《1976年城乡规划法令》为主要框架,而营业场所及工业执照通常由有关地方政府管理。

Conditions differ by local authority, industry, process and location. For example, Shah Alam City Council’s composite industrial-licence process asks applicants for building evidence such as a Certificate of Completion and Compliance or Certificate of Fitness and other supporting permits.
实际件会因地方政府、行业、工序和地点而不同。例如,莎阿南市政厅的工业综合执照程序要求申请人提交CCC或CF等建筑证明及其他相关文件。

That example should not be treated as a national checklist; the buyer must confirm the requirements of the local authority governing the specific property.
这只是地方政府实例,不能当作全国统一清单。买家必须向管辖该物业的地方政府确认。

Environmental compatibility also changes after dark. The Department of Environment’s Guidelines for Environmental Noise Limits and Control distinguish daytime and night-time assessment and consider the receiving land use.
夜间的环境兼容性也不同。马来西亚环境局的《环境噪音限值与控制指南》区分日间与夜间评估,并考虑接收地点的土地用途。

A plant that appears quiet during a 2 p.m. inspection may produce a very different impact when ambient noise falls, roller shutters open, compressors cycle, forklifts reverse and trucks queue at midnight.
下午两点看起来很安静的工厂,到了午夜,环境背景声降低、卷闸门开启、压缩机启动、叉车倒车和货车排队时,影响可能完全不同。

The 12 checks
购买或租赁前的12项检查

Article image

1. Write the real 24-hour operating brief 写出真实的24小时营运需求

Start with the proposed operation, not the building brochure.
从生产计划开始,而不是从厂房广告开始。

Record/ 应列明:
- processes and machinery operating continuously, intermittently or only at night;
连续、间歇或仅夜间运转的工序与机器;
- headcount by shift;
每班人数;
- truck, trailer, van and motorcycle movements by hour;
各时段货车、拖车、客货车与摩托车流量;
- loading-bay and yard activities;
装卸平台及货场活动;
- outdoor plant such as cooling towers, chillers, compressors, generators and pumps;
冷却塔、冷水机、压缩机、发电机及水泵等户外设备;
- utilities required at peak load and during maintenance;
高峰负载和维修期间所需公用设施;
- hazardous materials, scheduled waste, steam, gas or refrigeration systems; and
危险物料、Scheduled Waste、蒸汽、天然气或制冷系统;以及
- emergency staffing and response expectations.
夜班紧急人员和应急要求。

This operating brief becomes the basis for discussions with the local authority, environmental consultant, engineer, utility providers, landlord and insurer.
这份营运说明应成为与地方政府、环境顾问、工程师、公用事业单位、业主和保险公司沟通的共同基础。

A generic statement such as “light manufacturing, 24 hours” is not precise enough for proper due diligence.
“轻工业、24小时”这样的笼统描述不足以支持严谨尽调。

2. Verify title, zoning, planning permission and approved building use  核实地契、分区、规划批准及建筑用途

Check the land title, express conditions and restrictions in interest, applicable zoning, planning permission, approved building plans and CCC or CF.
检查地契、明示条件和利益限制、规划分区、规划许可、获批建筑图,以及CCC或CF。

Confirm that the approved use matches the proposed production or logistics activity—not merely that the surrounding area looks industrial.
必须确认获批用途与拟议生产或物流活动相符,而不是只看周边是否像工业区。

If the proposed use requires a material change, extension, external plant, new loading arrangement or worker facilities, additional planning or building approvals may be needed.
如果新用途涉及重大改变、扩建、户外设备、新装卸安排或员工设施,可能需要额外规划或建筑批准。

3. Confirm the local-authority licence and every operating condition 确认地方政府执照及所有营运条件
Ask the local authority which premises, composite, business, signboard and activity-specific licences apply.
向地方政府确认所需的场所、综合、营业、招牌及特定活动执照。

Request the current occupier’s licence for reference, but do not assume it transfers to the buyer or incoming tenant.
可索取现有营运者的执照作参考,但不要假设执照会自动转给买家或新租户。

Check for conditions dealing with:
重点查看执照是否限制:
- permitted activity and machinery/ 活动及机器;
- operating hours/ 营业时间;
- emissions, odour, dust or noise/ 排放、气味、粉尘或噪音;
- waste storage and cleanliness/ 废物储存和清洁;
- traffic, loading and obstruction/ 交通、装卸和道路阻塞;
- fire-safety documents; and 消防文件;以及
- licences or approvals from technical agencies/ 其他技术机构批准。

Obtain written clarification where 24-hour operation is essential to the investment case.
如果24小时营运是投资回报的必要条件,应尽量取得书面确认。

An informal statement that “other factories here run all night” is not an approval.
“附近其他工厂也通宵营业”并不是批准文件。

4. Map sensitive neighbours and future development  绘制敏感邻近用途及未来发展图
Inspect beyond the fence. Identify houses, worker hostels, schools, hospitals, places of worship, hotels and other noise-sensitive uses.
不要只看围篱以内。应识别住宅、员工宿舍、学校、医院、宗教场所、酒店及其他噪音敏感用途。

Review the current local plan and, where available, proposed development around the site.
同时查阅地方规划及周边拟议项目。

A property can be inside an industrial estate yet remain close enough to sensitive receivers for night-time truck noise, alarms or rooftop equipment to become an issue.
即使物业位于工业园,夜间货车、警报器或屋顶设备仍可能影响附近敏感接收点。

Also consider future residential development that may change the operating environment during a long lease or investment holding period.
长租或长期持有者也应考虑未来住宅发展会否改变营运环境。

Article image

5. Establish a night-time boundary-noise baseline 建立夜间边界噪音基线

Do not substitute a daytime walk-through for a night assessment.
白天看厂不能代替夜间评估。

For noise-critical operations, engage a competent environmental noise specialist to measure the existing acoustic environment at representative boundary and receiver locations, including the periods when the proposed operation would be most active.
对噪音敏感的项目,应聘请合资格环境噪音顾问,在具有代表性的地界及接收点测量现有声环境,尤其覆盖拟议营运最活跃的夜间时段。

The DOE environmental-noise guideline provides the national reference framework for planning, assessment, monitoring and control.
环境局指南是马来西亚规划、评估、监测及控制环境噪音的官方参考框架。

The appropriate limits and assessment method depend on land use, time period and circumstances.
适用限值与方法取决于土地用途、时段及现场情况。

6. Model the new noise and vibration sources 模拟新设备的噪音与振动

Add the proposed sources to the baseline: truck engines and air brakes, reversing alarms, dock levellers, forklifts, stamping or cutting equipment, compressors, cooling towers, condensers, rooftop exhausts, generators and material handling.
把拟议声源加入基线:货车引擎与气刹、倒车警报、装卸平台、叉车、冲压或切割机、压缩机、冷却塔、冷凝器、屋顶排风、发电机及物料搬运。

Test practical mitigation before signing.
签约前测试实际缓解方案。

Options may include acoustic enclosures, silencers, barriers, resilient mounts, quieter alarms, revised truck circulation, closed-door loading, relocating plant, limiting certain night activities or increasing setbacks.
措施可包括隔音罩、消声器、隔音屏、减振底座、低噪警报、调整货车路线、关门装卸、移动设备、限制部分夜间活动或增加退距。

Boundary environmental noise and employee occupational noise are different compliance questions.
厂界环境噪音与员工职业噪音是两个不同问题。

Malaysia’s Occupational Safety and Health (Noise Exposure) Regulations 2019 address employee exposure; satisfying workplace controls does not by itself prove that the external night-time impact is acceptable.
《2019年职业安全与卫生(噪音暴露)条例》处理员工暴露;符合工作场所要求,并不自动代表外部夜间影响合格。

Article image

7. Test night truck access, queuing and loading 实测夜间货车路线、排队与装卸

A public road that is open at night does not guarantee an efficient 24-hour logistics plan.
道路夜间开放,不代表物流一定顺畅。

Drive the actual route at the intended operating time and check:
应在拟议营运时段实际驾驶路线,并检查:

- road or neighbourhood restrictions affecting heavy vehicles;
重型车辆限制;
- gatehouse staffing and estate access rules;
园区门禁及保安安排;
- turning radii and opposing traffic at night;
夜间转弯空间与对向交通;
- guardhouse, weighbridge and security processing time;
保安亭、地磅及安检处理时间;
- on-site queue space so trucks do not wait on public roads;
场内排队空间,避免货车停在公共道路;
- dock, yard and canopy lighting;
月台、货场和雨棚照明;
- noise from reversing, coupling, idling and container handling; and
倒车、连接拖车、怠速及货柜操作噪音;以及
- safe separation of trucks, shift workers and motorcycles.
货车、夜班员工及摩托车的安全分流。

For a warehouse tenant, specify delivery windows and landlord or estate-management rules in the lease.
仓库租户应把收发货时段和园区管理规则写入租约。

For a buyer, assess whether yard redesign or a second gate needs approval.
买家则要确认改造货场或增设第二出入口是否需要批准。

8. Prove utility capacity and maintenance resilience 证明公用设施容量及维护韧性

Continuous operation requires more than a stated electrical amperage.
连续生产不能只看广告所写的电流安培数。

Verify available and contracted capacity, maximum demand, incoming redundancy, transformer and switchgear condition, power quality, maintenance responsibilities and upgrade lead time.
应核实可用及签约容量、最大需量、进线冗余、变压器及开关设备状况、电能质量、维护责任和增容周期。

Review water, sewerage, gas, telecommunications and process-cooling requirements where relevant.
按行业需要,同时审查水、排污、天然气、通信及工艺冷却。

Define what happens during planned maintenance and unplanned interruption.
明确计划维修和意外中断时如何运作。

Critical users may need backup generation, uninterruptible power, storage, dual communications paths or process-safe shutdown systems.
关键用户可能需要备用发电、UPS、储水、双通信路径或安全停机系统。

Generator testing and operation must also be included in the night-noise review.
发电机测试和运行也必须纳入夜间噪音评估。

9. Review fire, life-safety and emergency readiness for the night shift 审查夜班消防、生命安全及应急准备

Check the building’s fire-safety status, occupancy and process risk, fire systems, escape routes, emergency lighting, hazardous-material arrangements and staffing at night.
检查建筑消防状态、使用性质及工艺风险、消防系统、逃生路线、应急照明、危险物料安排及夜班人数。

Malaysia’s Fire and Rescue Department states that designated premises require a Fire Certificate and publishes the applicable process and categories.
马来西亚消防与拯救局说明,指定场所须取得消防证书,并公开适用类别及申请程序。

The night plan should identify who receives alarms, leads evacuation, isolates energy, contacts emergency services, provides first aid and controls visitors or contractors.
夜班方案应清楚列明谁接收警报、指挥疏散、隔离能源、联络救援单位、提供急救和管理访客。

A sophisticated system is ineffective if trained personnel are not present on the night shift.
即使系统先进,夜班没有受训人员也不能形成可靠应急能力。

10. Build a lawful and workable shift model 建立合法且可执行的轮班制度
Review contracts, shift rosters, rest days, overtime, transport, security, parking, meal areas, welfare facilities and supervision.
审查雇佣合同、轮班表、休息日、加班、交通、保安、停车、用餐及福利设施和现场监督。

The Employment Act 1955 contains specific provisions on shift work, and the 2022 amendment reduced the general weekly working-hour limit to 45 hours with effect from 1 January 2023.
《1955年雇佣法令》对轮班工作有具体条文;2022年修正案把一般每周工作时限降至45小时,并于2023年1月1日生效。

Obtain employment advice for the proposed roster, sector and workforce; a 24-hour facility does not mean any individual may work unlimited hours.
实际安排应按行业和员工类别取得劳动法意见;厂房24小时营运,不等于任何员工可以无限时工作。

For sites that are hard to reach after public transport closes, employee transport and safe motorcycle access may be decisive operational costs.
若公共交通深夜停止,员工交通和摩托车安全出入可能成为关键成本。

Do not assume worker accommodation can simply be placed inside a factory; that is a separate land-use, building, fire-safety and accommodation-compliance question.
也不要假设员工可直接住进厂房;那是另一个涉及土地用途、建筑、消防及住宿标准的合规问题。

11. Check the lease, strata rules, estate rules and insurance 检查租约、分层规则、园区规则及保险

For tenants, the tenancy should expressly permit the intended use and operating pattern, subject to law and approvals.

租约应明确允许拟议用途及营运模式,并受法律与批准约束。

Review clauses on opening hours, utilities, generators, external plant, structural works, nuisance, access, security, reinstatement and landlord consent.

重点审查营业时段、公用设施、发电机、户外设备、改造、滋扰、门禁、保安、复原责任和业主同意。

For strata industrial property, inspect by-laws and management rules governing common-property access, loading bays, lifts, security, parking, noise and after-hours services.

购买或租用分层工业物业时,应查阅关于公共空间、装卸区、货梯、保安、停车、噪音及非办公时段服务的附例与管理规则。

Buyers should also review industrial-estate covenants and facility-management rules.

买家也应审查工业园契约和设施管理规定。

Tell the insurer and lender how the property will operate.

必须把真实营运方式告知保险公司和贷款机构。

Continuous production, hazardous processes, cold-chain stock, automated systems or an unattended plant may change risk requirements and business-interruption cover.

连续生产、危险工序、冷链库存、自动化系统或无人值守设备都可能影响承保要求及营业中断保险。

12. Make approval, trial operation and mitigation part of the deal 把批准、试运行和缓解工程写进交易

Where 24/7 capability is essential, do not leave it as a vague assumption.
若24小时能力对项目至关重要,就不能只作为口头假设。

Use transaction protections appropriate to the deal, such as:
可按交易情况争取:

- a due-diligence period for technical and regulatory checks;
技术与法规尽调期;
- conditions precedent for key approvals or written confirmations;
关键批准或书面确认作为先决条件;
- access for night-time noise and traffic studies;
夜间噪音及交通测试权限;
- landlord consent for plant, ducts, barriers or backup systems;
业主对设备、风管、隔音屏或备用系统的同意;
- an agreed responsibility and budget for upgrades;
明确升级责任及预算;
- a trial or commissioning period with monitoring; and
带监测的试运行或调试期;以及
- clear termination, rent-commencement or remedy provisions if critical conditions fail.
关键条件失败时明确的终止、租金起算或补救机制。

The exact drafting should be handled by the buyer’s or tenant’s Malaysian lawyer.
具体条款应由买方或租户的马来西亚律师拟定。

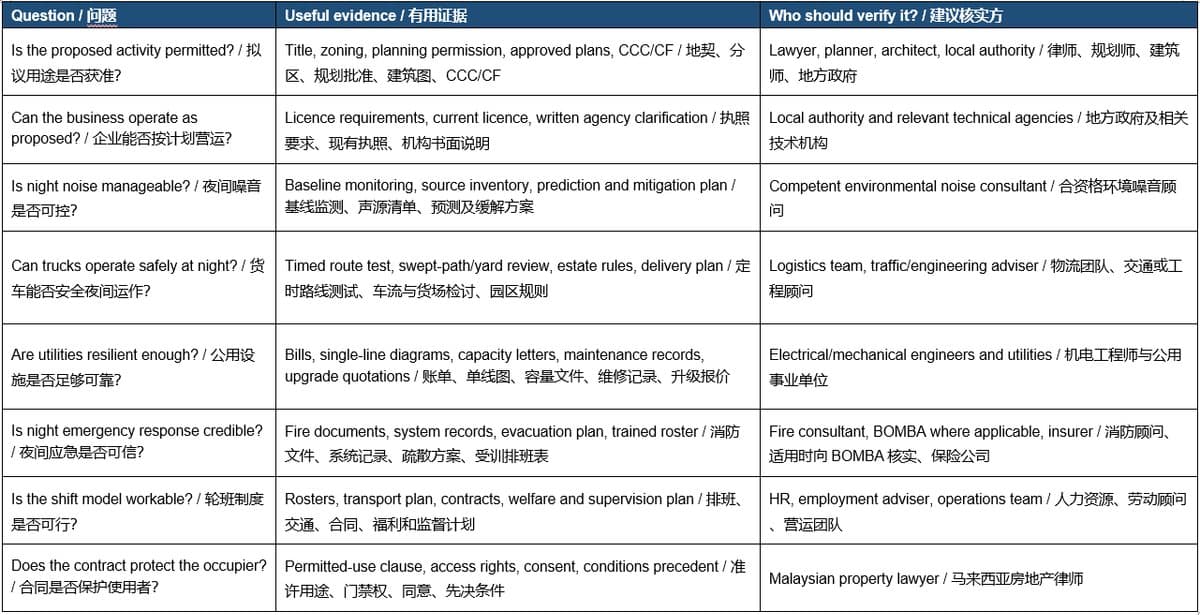

Evidence matrix: what should a serious buyer or tenant request?
证据矩阵:认真买家或租户应索取什么?

Article image

Red flags that deserve immediate attention
值得立即调查的警讯

“The previous tenant operated 24 hours, so you can too,” but no licence or approval is produced.
卖方称上一家租户24小时运作,却拿不出执照或批准。

The site is inspected only during office hours.
团队只在办公时间看厂。

Houses or hostels are visible near the loading yard or rooftop plant.
装卸货场或屋顶设备附近可见住宅或宿舍。

Trucks queue outside the gate or reverse through shared roads.
货车必须在厂外排队,或在共用道路倒车。

The lease permits “industrial use” but is silent on night access, generators or external equipment.
租约只写“工业用途”,没有说明夜间门禁、发电机或户外设备。

Utility capacity is quoted verbally without recent bills, drawings or provider confirmation.
电力容量只有口头数字,没有近期账单、图纸或公用事业证明。

Fire systems are present, but no one can explain the night-shift response plan.
厂内有消防设备,却没有人能解释夜班应急职责。

The seller expects the buyer to solve noise or traffic complaints after completion.
卖方要求买家成交后才处理噪音或交通投诉。

A practical go/no-go framework
简单的可行性判断

Green: proposed use is consistent with approvals; licence pathway is clear; night baseline and modelling support the operation; logistics, utilities and emergency systems are workable.
绿色: 拟议用途与批准相符;执照路径清楚;夜间监测与模型支持营运;物流、公用设施及应急系统可行。

Amber: operation appears feasible but depends on defined upgrades, mitigation, landlord consent or agency confirmation. Price, timeline and transaction conditions must reflect these items.
黄色: 项目可行,但依赖明确升级、缓解工程、业主同意或机构确认;价格、时间表及交易条件必须反映这些事项。

Red: use or operating conditions conflict with approvals; sensitive receivers make mitigation impractical; night logistics cannot be contained on-site; or essential utility and emergency requirements cannot be achieved within the project schedule.
红色: 用途或营运条件与批准冲突;敏感接收点令缓解不现实;夜间物流无法在场内解决;或关键公用设施与应急要求不能在项目时间内达到。

Conclusion 总结

The right question is not simply, “Is this an industrial factory?” It is, “Can this specific property support this specific 24-hour process, traffic pattern, workforce and risk profile—with evidence?”
真正的问题不是“这是不是工业厂房”,而是“这项具体物业,能否以证据证明它可承载这项具体的24小时工序、交通、员工及风险模式?”

Buyers and tenants should complete regulatory, technical, environmental, logistics and contractual checks before paying a non-refundable deposit or committing to a long lease.
买家和租户应在支付不可退订金或签长期租约前,完成法规、技术、环境、物流及合同检查。

Early verification protects both the operating timetable and the property investment.
越早验证,越能同时保护投产时间和物业投资。

This article provides general industrial-property information and is not legal, planning, environmental, engineering, employment or fire-safety advice. Requirements vary by authority, property and activity.
本文仅提供一般工业地产资讯,不构成法律、规划、环境、工程、劳动或消防意见。要求会因地方政府、物业及活动而异。

Appoint qualified Malaysian advisers for the proposed transaction and operation.
请为具体交易和营运聘请合资格马来西亚专业人士。

Frequently Asked Questions
常见问题

1. Does industrial zoning automatically allow 24-hour factory operation in Malaysia? 工业分区是否自动允许马来西亚厂房24小时营运?
No. Industrial zoning addresses land-use compatibility, but the actual operation must also comply with planning and building approvals, local-authority licensing conditions, environmental requirements, fire safety, employment rules and private contractual restrictions.
不是。工业分区主要处理土地用途兼容性,实际营运还须符合规划与建筑批准、地方政府执照条件、环境要求、消防安全、劳动规定及私人合同限制。

2. Is a previous tenant’s 24-hour operation proof that a new tenant may do the same?上一位租户曾24小时营运,是否证明新租户也可以?
No. The previous activity, machinery, licence holder and conditions may differ. Request documentary evidence and confirm the incoming operation with the relevant authorities and advisers.
不能。上一家企业的活动、机器、持证人和批准条件可能不同。应索取文件,并让有关机构及专业顾问核实新营运模式。

3. When should night-time noise be measured? 什么时候应该测量夜间噪音?
Before commitment when night operation is material to the deal. Measurement periods and locations should represent the site, proposed operating hours and nearby receivers, and should be designed by a competent environmental noise consultant.
如果夜间营运是交易的重要前提,应在承诺前测量。时段和地点必须能代表厂址、拟议营运时间及附近接收点,并由合资格环境噪音顾问设计。

4. Is employee noise exposure the same as environmental boundary noise? 员工噪音暴露与厂界环境噪音是否相同?
No. Occupational noise concerns employee health and exposure at work; environmental noise concerns impact outside the premises. A project may need to address both.
不同。职业噪音关注员工在工作中的健康暴露;环境噪音关注厂外影响。项目可能需要同时处理两者。

5. What should a 24-hour warehouse tenant put in the tenancy agreement? 24小时仓库租户应在租约写入什么?
The permitted use, round-the-clock access, delivery rights, utilities, security, external plant, alteration consent, nuisance controls, reinstatement, compliance responsibility and any conditions precedent should be clearly addressed by the tenant’s lawyer.
应由律师明确处理准许用途、全天门禁、收发货权、公用设施、保安、户外设备、改造同意、滋扰控制、复原责任、合规分工及适用的先决条件。

6. Can the purchase or lease be conditional on confirming 24/7 feasibility? 买卖或租赁能否以确认24小时可行为条件?
It may be possible to negotiate due-diligence access, approval conditions, landlord consents or other protections. The appropriate structure depends on the transaction and should be drafted by a Malaysian lawyer.
双方可视交易协商尽调权限、批准先决条件、业主同意或其他保障。具体结构应由马来西亚律师按交易情况拟定。
