A practical guide to network proximity, demand and pressure, connection routes, gas installations, approvals, commercial terms and alternatives for heat-intensive manufacturers.
从管网距离、用量与压力、接驳路线、燃气装置、审批、商业条款到替代燃料,为高热能制造企业提供实用选厂指南。
Answer first: a nearby gas pipe is not a supply confirmation
先说答案:附近有燃气管,不代表这间厂房可以用
A Malaysian factory can use piped natural gas only when the proposed consumption, pressure, supply date and connection point are technically and commercially accepted, a lawful route is available, and the downstream gas installation is designed, approved, tested and operated through the required regulatory process.
马来西亚厂房要使用管道天然气,必须先确认拟议用量、压力、供气日期及接驳点在技术与商业上可行;拥有合法可施工的管线路线;并让下游燃气装置按照规定完成设计、审批、测试和营运程序。
Seeing a yellow pipe, meter station or gas-using neighbour is only a screening clue—not proof that the incoming factory can obtain the required gas.
看到黄色管道、调压计量站或邻厂正在用气,只能作为初步线索,不能证明新企业一定可以获得所需供气。
Before paying a non-refundable deposit, the buyer or tenant should give the gas supplier or distributor a credible hourly and annual demand profile; secure written, site-specific feasibility; map the complete connection route; identify who funds and owns each asset; and appoint an Energy Commission-registered gas contractor and competent person for the installation process.
在支付不可退还的订金前,买家或租户应向相关供气或配气单位提交可信的每小时与年度用气曲线,取得针对该地块的书面可行性,绘制完整接驳路线,明确每项设施的付款与所有权,并委任马来西亚能源委员会注册的燃气承包商及合资格人员。
In Peninsular Malaysia, the Energy Commission states that Approval to Install must be obtained before work begins on a new gas installation or extension.
在马来西亚半岛,能源委员会说明,新燃气装置或扩建工程必须在动工前取得安装批准(Approval to Install)。
This issue is commercially important for China-based and Malaysian manufacturers using boilers, furnaces, ovens, kilns, dryers, heat-treatment lines or process heating.
这对使用锅炉、熔炉、烘箱、窑炉、干燥机、热处理线或工艺加热的中国及马来西亚制造企业尤其重要。
A property may be correctly zoned and physically attractive yet still miss its production date because gas feasibility was assumed rather than documented.
厂房即使分区正确、建筑条件不错,也可能因为燃气可行性只是口头假设,而最终错过投产日期。
Why gas availability changes the industrial-property decision
为什么燃气会改变工业地产选择
Fuel choice affects far more than the utility bill. It can change the site layout, building design, ventilation, fire strategy, process emissions, equipment selection, operating cost, carbon planning, maintenance capability and commissioning programme.
燃料选择不仅影响每月账单,也会改变厂区总图、建筑设计、通风、消防策略、排放控制、设备选型、营运成本、减碳计划、维修能力及投产时间。
Typical gas-intensive users include:
常见高用气行业包括:
- food and beverage processors using steam, baking, frying or drying;
使用蒸汽、烘焙、油炸或干燥工艺的食品饮料企业;
- ceramics, glass and mineral-product manufacturers;
陶瓷、玻璃及矿物制品制造商;
- metal heat treatment, coating and finishing operations;
金属热处理、涂层及表面处理企业;
- textile, paper, rubber and chemical processes;
纺织、纸业、橡胶及化工;
- factories with central steam or thermal-oil systems; and
使用中央蒸汽或导热油系统的工厂;以及
- facilities replacing diesel, fuel oil or LPG with piped natural gas.
希望以管道天然气取代柴油、燃料油或LPG的工厂。
The correct property question is therefore not:
所以真正要问的不是:
“Does this industrial estate have gas?”
“这个工业区有没有天然气?”
It is/ 而是:
“Can the required gas volume and pressure reach this exact lot by the required date, through an approvable route, at an acceptable total cost and with a compliant installation?”
“所需气量与压力能否在目标日期前,通过可获批准的合法路线,以可接受的总成本送到这一个地块,并配合合规的燃气装置?”
The 10 checks before buying or leasing
购买或租赁前的10项检查

1. Convert the production plan into a gas-load profile 把生产计划转换成用气负荷曲线
Do not begin with a rough monthly bill. Prepare an equipment schedule showing every burner, boiler, furnace, oven and future line.
不要从粗略月度用量开始。应列出每台燃烧器、锅炉、熔炉、烘箱及未来生产线。
Record rated input, expected utilisation, minimum and maximum flow, operating hours, simultaneity, start-up behaviour, required inlet pressure, fuel quality sensitivity and phased expansion.
记录额定输入、预计使用率、最低与最高流量、运行时间、同时使用系数、启动特性、设备入口压力、燃料品质要求及扩建阶段。

Use engineering units consistently and state whether figures are gross calorific value, net calorific value, standard volume or energy.
工程单位必须统一,并注明数据使用的是高位热值、低位热值、标准体积还是能源单位。
Let the supplier and appointed professionals confirm the conversion basis.
换算基础应由供应商及受委任专业人士确认。
2. Obtain written, site-specific network feasibility 取得针对具体地块的书面管网可行性
Ask the relevant licensed supplier or distributor to assess the actual lot, not merely the industrial park.
要求相关持牌供气或配气单位评估实际地块,而不是只评估整个工业园。
The written response should address, as far as the process allows:
书面回复应尽量说明:
- proposed connection point;
拟议接驳点;
- indicative available volume and pressure;
初步可提供气量与压力;
- upstream reinforcement or extension needs;
上游强化或延伸工程;
- meter and pressure-regulating requirements;
计量及调压设备要求;
- preliminary route and land needs;
初步路线及土地需求;
- customer and utility scope;
客户与公用事业单位的工作范围;
- key studies, agreements and deposits;
所需研究、协议及保证金;
- indicative programme; and
初步时间表;以及
- conditions that could change feasibility.
可能改变可行性的条件。
Malaysia’s regulated gas market distinguishes activities such as transportation, distribution and shipping, and the Energy Commission publishes lists of registered licence holders.
马来西亚受监管的天然气市场区分输气、配气及Shipping等活动,能源委员会也公布持牌单位名单。
Confirm the correct counterparties for the proposed supply arrangement rather than relying on an owner’s historical account.
应确认实际供气安排涉及哪些正确持牌单位,而不是只依赖业主过去的账户资料。

3. Trace the complete route to the factory boundary 查清从管网到厂界的完整路线
The nearest pipe may sit across a highway, drain, railway, river, reserve or third-party land.
最近的燃气管可能隔着高速公路、排水沟、铁路、河流、保留地或第三方土地。
A technically short route can become legally or financially difficult.
技术上看似很短的接驳路线,在法律和成本上可能非常复杂。
Commission an appropriate survey and identify:
应安排适当测量,并确认:
- public-road and highway crossings;
公共道路及高速公路穿越;
- drainage, river and utility reserves;
排水、河流及公用设施保留地;
- railway or bridge interfaces;
铁路或桥梁接口;
- third-party land and easements;
第三方土地及地役权;
- existing underground utilities;
现有地下公用设施;
- gate, fire-access and truck-movement conflicts;
大门、消防通道及货车动线冲突;
- future building expansion areas; and
未来建筑扩建范围;以及
- a protected approach to the metering station.
调压计量站的安全接近路线。
The Gas Supply Regulations contain detailed duties concerning excavation near gas installations, location information, notification, hand digging, protection and emergency response.
《1997年燃气供应条例》对靠近燃气设施进行开挖时的资料、通知、人工探测、防护和紧急处理责任设有规定。
A title plan alone does not show every buried constraint.
地契图本身无法显示所有地下限制。
4. Reserve a compliant site for the gas station and pipework 在总图预留合规的调压计量站和管线路径
The concept plan should show the meter, pressure-reduction equipment, isolation valves, security fence, maintenance access, crash protection, ventilation, emergency approach and downstream pipe route.
概念总图必须显示计量器、调压设备、隔离阀、安全围栏、维修通道、防撞设施、通风、紧急入口及厂内管线路径。
The position must be coordinated with buildings, boundaries, drains, electrical equipment, ignition sources, loading yards, fire-appliance access and proposed extensions.
设施位置必须与建筑、边界、排水、电气设备、点火源、装卸场、消防车通道及未来扩建协调。
Do not accept “put it beside the gate” as a design solution.
不要接受“放在大门旁边就可以”作为设计答案。
A poor location can obstruct container traffic, consume expansion land, conflict with fire access or require a long internal pipeline exposed to vehicle impact.
位置选择不当,可能阻碍货柜车流、占用扩建土地、影响消防通道,或导致厂内管道过长并暴露于车辆撞击风险。

5. Verify approvals before installation and operation 在安装与营运前核实审批
The Energy Commission states that a registered gas contractor must submit the Approval to Install application.
能源委员会说明,安装批准(Approval to Install)必须由注册燃气承包商提交。
It also identifies the Gas Supply Act 1993, Gas Supply Regulations 1997, Energy Commission requirements and relevant standards as the governing framework.
设计与施工还须符合《1993年燃气供应法令》《1997年燃气供应条例》、能源委员会规定及相关标准。
Its published conditions include valid competent persons, approved fittings and equipment, and accredited welders.
相关条件还包括合资格燃气人员、获批准的配件与设备,以及符合资格的焊工。
The regulatory sequence may include design, Approval to Install, construction, inspection, testing, certificates and Approval to Operate, depending on the installation.
具体流程视装置而定,可能包括设计、安装批准、施工、检查、测试、证书及营运批准(Approval to Operate)。
Coordinate this with local-authority building works, BOMBA requirements, machinery commissioning, environmental controls and the production licence.
同时必须与地方政府建筑工程、BOMBA消防、机器调试、环保控制及制造执照协调。
Never treat a previous occupier’s gas account as permission for a new installation or process.
旧租户曾经使用天然气,不代表新企业可以自动沿用原有批准或工艺。
6. Audit any existing gas installation 审核现有燃气装置
For a second-hand factory, request:
购买二手厂房时,应索取:
- approved drawings and calculations;
核准图及计算书;
- Approval to Install and Approval to Operate records;
安装批准及营运批准记录;
- completion, testing and commissioning certificates;
完工、测试及调试证书;
- meter and regulator data;
计量及调压设备资料;
- pipe material, route and pressure class;
管材、路线及压力等级;
- equipment approvals;
设备批准;
- inspection, maintenance and repair records;
检查、维修和修理记录;
- incident and shutdown history;
事故和停机历史;
- current supply agreement and bills; and
当前供气协议及账单;以及
- confirmation of asset ownership.
资产所有权确认。
Then compare the documents with the physical installation.
之后把文件与现场装置逐项比较。
Look for abandoned branches, corrosion, damaged coatings, unapproved modifications, missing labels, blocked ventilation, vehicle exposure and equipment that has exceeded its intended service condition.
应检查废弃支管、腐蚀、保护层损坏、未经批准的改装、缺失标签、通风受阻、车辆撞击风险,以及设备是否已经超过合理使用状态。
Historical operation is evidence—not a warranty of future suitability.
过去能够运行只是历史证据,不是未来适用性的保证。
7. Separate supply price from total delivered cost 把供气价格与完整到厂成本分开计算
Budgeting only the commodity price is incomplete.
只预算天然气本身价格是不完整的。
The commercial model may include/ 商业模型可能包括:
- gas commodity price; 天然气商品价格;
- transmission or transportation charges; 输气或运输费用;
- distribution capacity charges; 配气容量费;
- taxes; 税项;
- meter or station costs; 计量或调压站费用;
- connection works; 接驳工程;
- deposits; 保证金;
- minimum commitments; and 最低承购义务;以及
- customer-side installation costs. 客户侧安装费用。
Published figures can change by period and are not a quotation for a particular factory.
公开费率会随时期调整,也不能当作某一间厂房的正式报价。
For example, the source article notes Gas Malaysia’s 2026 transmission tariff of RM1.204/GJ, distribution capacity charge of RM2.114/GJ excluding service tax, and Q2 2026 Malaysia Reference Price of RM33.053/MMBtu.
例如,原文列出Gas Malaysia 2026年输送费RM1.204/GJ、配气容量费RM2.114/GJ(未含服务税),以及2026年第二季度Malaysia Reference Price RM33.053/MMBtu。
These figures should not be copied directly into an investment model without checking the applicable agreement, period, units and taxes.
这些数字不能直接复制进投资模型,仍须按实际合约、时期、单位及税项重新核实。
8. Align gas timing with property and production timing 把燃气时间表与交房和投产时间合并
Prepare one integrated programme covering property completion, vacant possession, design, wayleaves, authority submissions, upstream works, customer installation, testing, first gas and equipment commissioning.
制作一份整合时间表,涵盖成交、空置交付、设计、Wayleave、政府申请、上游工程、客户侧安装、测试、首次供气及机器调试。
The Energy Commission publishes a 15-working-day processing target for a complete Approval to Install application, but that is only one regulatory step.
能源委员会公布完整安装批准申请的处理目标为15个工作日,但这只是其中一个审批环节。
It does not represent the total time needed for feasibility, design, route rights, utility construction, equipment procurement, testing or Approval to Operate.
它并不代表整项供气项目只需要15个工作日,因为还包括可行性、设计、路线权利、公用事业施工、设备采购、测试及营运批准。
Treat any promised first-gas date as conditional until the complete critical path is documented.
在完整关键路径获得文件确认前,任何首次供气日期都应视为有条件。
9. Allocate cost, ownership and reinstatement in the transaction 在交易文件分配成本、所有权与恢复责任
The letter of offer, sale agreement or tenancy should identify:
意向书、买卖协议或租约应写明:
- which gas assets are included in the property;
哪些燃气设施包含在交易内;
- who owns the meter, station and upstream and downstream pipework;
谁拥有计量站及上下游管道;
- who applies, pays and provides land rights;
谁负责申请、付款及提供土地权利;
- who bears reinforcement, relocation and road-opening costs;
谁承担强化、迁移和道路开挖成本;
- access rights for utility and maintenance personnel;
公用事业及维修人员的进入权;
- responsibility for inspections, repairs and emergency works;
检查、维修和紧急工程责任;
- what happens if supply is delayed or refused;
供气延误或被拒时如何处理;
- transfer or termination of the supply agreement;
供气合约如何转移或终止;
- landlord consent to installation and alteration; and
业主对安装和改造的同意;以及
- removal or reinstatement at lease expiry.
租约结束时的拆除或复原责任。
Legal documents should be prepared by Malaysian lawyers using the actual technical and commercial arrangement.
法律文件应由马来西亚律师根据真实技术及商业安排拟定。
A property brochure should never be the only evidence supporting a gas-dependent investment.
对于依赖天然气的投资,物业宣传册绝不能成为唯一证据。
10. Design an alternative before treating the site as feasible 在确认物业可行前先设计替代燃料方案
If piped gas is unavailable or late, alternatives may include LPG, LNG, diesel, electricity, biomass or another process technology.
如果管道天然气无法提供或延迟,替代方案可能包括LPG、LNG、柴油、电力、生物质或其他工艺技术。
Each changes storage space, delivery traffic, fire separation, emissions, approvals, equipment and operating cost.
每一种方案都会改变储存空间、运输车流、消防间距、排放、审批、设备及营运成本。
The alternative must be independently engineered; it is not automatically acceptable because fuel can be delivered by truck.
替代燃料必须独立进行工程评估,不能因为“可以用卡车送来”就认为一定可行。
For a production-critical facility, define the backup duration, switching method, storage capacity, replenishment logistics and approval status.
对于生产关键设施,应明确备用时间、切换方式、储存容量、补充物流及审批状态。
Price both the interim solution and the permanent conversion.
临时方案及最终转换方案都必须计入成本。
Property red flags 物业警示信号
- “Gas available” is supported only by a yellow pipe or neighbour’s meter.
“有天然气”唯一证据只是黄色管道或邻厂计量站。
- No one can identify the licensed supplier, distributor or connection point.
没有人能说明持牌供气或配气单位及接驳点。
- Demand is described only as a monthly estimate with no hourly maximum.
只有每月用量估计,没有每小时最大需求。
- The required equipment pressure is unknown.
不知道设备所需压力。
- The route crosses third-party land without documented rights.
管线需要经过第三方土地,却没有书面权利。
- The proposed station conflicts with truck turning or fire access.
调压计量站与货车转弯或消防通道冲突。
- Existing pipework has no approved drawing or test record.
现有管道没有核准图或测试记录。
- The previous account is assumed to transfer automatically.
假设旧账户可以自动转移。
- The owner promises connection after signing but accepts no responsibility if it fails.
业主承诺签约后接通天然气,但如果失败却不承担责任。
- The investment model uses one commodity price and ignores network, tax, station and installation costs.
投资模型只采用单一气价,忽略输配费、税项、计量站及安装成本。
- The first-gas date excludes design, procurement, crossings or upstream work.
首次供气日期没有包括设计、采购、道路穿越或上游工程。
- The “backup” fuel has no storage area, delivery route or approval plan.
所谓备用燃料没有储存位置、送货路线或审批计划。
A practical decision sequence 实用决策顺序
Define the production process and gas-load profile.
定义生产工艺和用气负荷。
Obtain site-specific written network feasibility.
取得具体地块的书面管网可行性。
Survey the proposed connection and internal routes.
测量拟议接驳路线及厂内管线。
Reserve an approvable gas-station and pipeline layout.
预留可获批准的调压计量站和管线路径。
Audit existing assets and regulatory records.
审核现有设施与监管文件。
Obtain preliminary capital, tariff and programme information.
取得初步资本开支、费率及时间资料。
Compare piped gas with a properly engineered alternative.
将管道天然气与完整工程设计的替代方案比较。
Align property completion with first-gas and commissioning dates.
对齐成交、交房、首次供气及投产日期。
Put unresolved matters into conditions precedent and responsibility clauses.
把未解决事项写入先决条件及责任条款。
Make the final property decision only after technical, legal and commercial review.
完成技术、法律及商业审查后才决定物业。
Frequently Asked Questions 常见问题
1. Does a yellow gas pipe outside a Malaysian factory prove that natural gas is available? 厂房外有黄色燃气管,是否代表天然气已经可用?
No. It indicates possible infrastructure only.
不是。它只表示附近可能有燃气基础设施。
Capacity, pressure, connection point, route, cost, programme and the customer’s installation still require site-specific written confirmation and regulatory approval.
供气容量、压力、接驳点、路线、成本、时间及客户侧安装仍须取得针对该地块的书面确认和监管批准。
2. Who may submit an Approval to Install application? 谁可以提交安装批准申请?
The Energy Commission states that Approval to Install applications must be made by registered gas contractors through its online system.
能源委员会说明,安装批准必须由注册燃气承包商通过其网上系统提交。
Use the Commission’s register to verify the contractor and competent-person status.
应在能源委员会登记册核实承包商及合资格人员的注册状态。
3. Can a buyer reuse the seller’s existing gas installation? 买家可以沿用卖家的燃气装置吗?
Possibly, but only after verifying ownership, approvals, drawings, test and maintenance records, physical condition, new process demand and the required transfer or new supply arrangements.
有可能,但必须核实所有权、批准、图纸、测试及维修记录、实体状况、新工艺需求,以及账户转移或新的供气安排。
A previous operating history does not confirm suitability for the buyer.
旧用户过去可以使用,并不能证明系统适合新买家。
4. How long does a factory gas connection take? 工厂接通天然气需要多久?
There is no universal period.
没有统一时间。
The Energy Commission’s published processing target for a complete Approval to Install application is one component only.
能源委员会公布的完整安装批准申请处理目标只是其中一个环节。
Network studies, route rights, design, upstream works, equipment procurement, construction, testing and operating approval may control the overall programme.
管网研究、路线权利、设计、上游工程、设备采购、施工、测试及营运批准都可能决定总进度。
5. Is piped natural gas always cheaper than LPG or electricity? 管道天然气一定比LPG或电力便宜吗?
No. 不一定。
Compare the complete delivered and lifecycle cost using the factory’s load profile, tariff structure, connection capital, minimum commitments, efficiency, taxes, backup requirements and maintenance.
必须根据工厂实际用气曲线、费率结构、接驳资本开支、最低承购、效率、税项、备用系统及维修比较完整到厂和全生命周期成本。
Obtain current quotations for the actual site.
应取得针对实际地块的最新报价。
6. What should a China-based manufacturer provide when asking XPillar to find a gas-ready factory? 中国制造企业请XPillar寻找“可用天然气厂房”时,应提供什么?

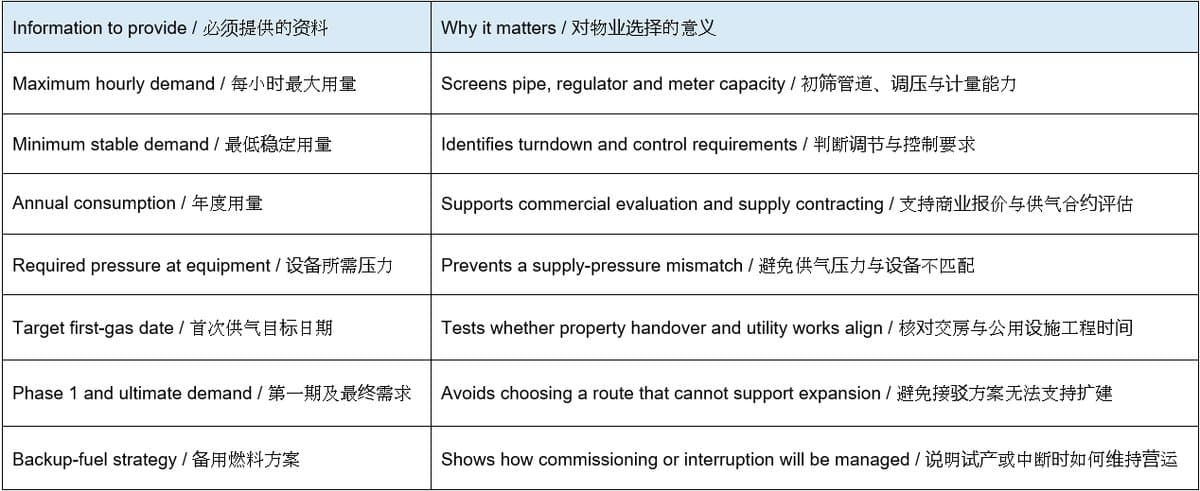

Provide the Malaysian target location, process description, equipment list, maximum hourly and annual demand, required pressure, target first-gas date, Phase 1 and ultimate load, purchase-or-lease preference, site size and backup-fuel strategy.
请提供马来西亚目标地区、生产工艺、设备清单、每小时最大与年度用量、所需压力、首次供气目标日期、第一期及最终需求、购买或租赁偏好、土地或建筑面积,以及备用燃料方案。
This enables a more credible property shortlist and utility enquiry.
这样XPillar才能更准确地筛选物业并进行公用事业初步查询。
Conclusion 结论
Natural-gas suitability is a chain of evidence: demand, network, pressure, route, land rights, station layout, installation approvals, commissioning, commercial terms and timing.
天然气适用性是一条完整证据链:需求、管网、压力、路线、土地权利、计量站布局、安装审批、调试、商业条款及时间。
If one critical link is missing, a “gas-ready factory” may not be ready for the incoming production line.
任何一个关键环节缺失,“天然气就绪厂房”都可能无法配合新生产线。
XPillar can help manufacturers, investors and industrial-property decision-makers organise the property brief, shortlist suitable factories or industrial land, collect owner-provided information and coordinate the correct utility and professional questions.
XPillar可协助制造商、投资者及工业地产决策者整理物业需求、筛选合适厂房或工业土地、收集业主资料,并协调正确的公用设施及专业问题。
Final gas feasibility and compliance must be confirmed by the relevant licensed parties, authorities and qualified professionals.
最终供气可行性及合规仍须由相关持牌单位、主管机关及合资格专业人士确认。
Explore Malaysia industrial properties on XPillar and state your operational requirements before arranging site inspections.
欢迎通过XPillar浏览马来西亚工业地产,并在安排看厂前先提供完整营运需求。
This article provides general industrial-property information only. It is not engineering, gas-safety, regulatory, legal, environmental, tax or investment advice.
本文仅提供一般工业地产资讯,不构成工程、燃气安全、监管、法律、环保、税务或投资意见。
Requirements and commercial terms vary by location, installation, activity and date. Obtain current property-specific confirmation.
规定及商业条款会因地点、装置、活动和日期而不同,请针对具体物业取得最新确认。
