Can This Factory Get Piped Natural Gas? 10 Checks Before Buying or Leasing in Malaysia | 这间马来西亚厂房能接管道天然气吗?买或租之前必须检查的10项条件

A practical bilingual due-diligence guide to network availability, demand, pressure, connection routes, station space, approvals and transaction protection.

Aug 17, 2026
Can This Factory Get Piped Natural Gas? 10 Checks Before Buying or Leasing in Malaysia |  这间马来西亚厂房能接管道天然气吗?买或租之前必须检查的10项条件

A natural-gas pipeline near a factory does not prove that the property can be connected on the required capacity, pressure, cost or schedule. This guide shows Malaysian factory buyers and tenants how to verify the complete route—from the distribution network and boundary station to the internal piping, approvals and operating equipment—before committing.

Can This Factory Get Piped Natural Gas? 10 Checks Before Buying or Leasing in Malaysia 这间马来西亚厂房能接管道天然气吗?买或租之前必须检查的10项条件

A practical due-diligence guide to network availability, demand, pressure, connection routes, station space, approvals and transaction protection.
从供气网络、用量与压力、接驳路径、调压计量站空间,到审批与交易保障的实用尽调指南。

Answer first: a nearby gas pipeline is not a connection guarantee
先说结论:附近有天然气管道,不代表这间厂房一定能接通

Before buying or leasing a Malaysian factory that needs piped natural gas, obtain written confirmation on four separate matters:
如果拟购买或租赁的马来西亚厂房需要使用管道天然气,签约前必须分别取得以下四方面的书面确认:
- whether a suitable distribution network can serve the exact property;适用的天然气分配网络能否服务到该地块;
- whether the required peak flow and delivery pressure can be made available;所需的高峰流量和供气压力能否提供;
- whether a lawful, buildable route and adequate site area exist for the connection and gas facilities; and从公共管网到厂区是否存在合法、可施工的接驳路径,并有足够空间设置相关供气设施;以及
- whether the downstream gas installation can be designed, approved, tested and operated for the proposed process. 厂内燃气系统能否根据拟议工艺完成设计、审批、测试和合法投运。

Do not treat a yellow pipe, a neighbouring factory's gas supply, a map pin or an agent's statement as proof. The relevant distributor or supplier must assess the actual property, demand profile and connection arrangement. The customer must also deal with the land, building, equipment and regulatory requirements inside the site.
不要因为路边看见黄色管道、邻厂正在用天然气、地图显示附近有管线,或代理说“这里有 gas”,就当作已经确认。相关供气方或分配网络营运方仍需根据具体地块、用气曲线及接驳方案进行评估;客户也需要处理厂区内的土地、建筑、设备和监管要求。

For a gas-dependent manufacturer, this is a property feasibility issue, not merely a utility-account transfer. A cheaper factory can become the more expensive choice if it requires a long service extension, road crossing, new metering station, restricted wayleave, major internal piping or an alternative-fuel system.
对于依赖天然气生产的制造商,这属于厂房可行性问题,不只是更换公用事业账户。如果需要延长支管、穿越道路、设置新的调压计量设施、取得地役权,或大幅改造厂内管道,表面租金较低的厂房可能反而更昂贵。

Practical rule: Do not sign unconditionally because “gas is nearby.” Commit only after the critical technical, land, approval, cost and timing assumptions have been tested in writing.
实用原则: 不要因为“附近有天然气”就无条件签约。必须先用书面资料核实技术、土地、审批、费用和时间条件。
Important: This article provides general industrial-property information, not gas-engineering, process-safety, legal, fire, insurance or investment advice. Requirements vary by location, installation classification, process and equipment. Engage the relevant gas distributor or shipper, a registered gas contractor, an appropriately registered gas competent person, legal advisers and other qualified Malaysian professionals for the specific property.
重要说明: 本文只提供一般工业地产信息,并非燃气工程、工艺安全、法律、消防、保险或投资意见。具体要求取决于地点、安装类别、生产工艺和设备。请就目标厂房咨询相关天然气分配或供应单位、注册燃气承包商、合资格且已注册的燃气专业人员、律师及其他马来西亚专业顾问。

Why piped gas can materially affect factory selection 为什么管道天然气会直接影响选厂
Gas Malaysia describes natural gas as serving industrial uses including furnaces, boilers, food processing, glassmaking, hydrogen and fertiliser production, and cogeneration. These operations may require more than a fuel source: they may depend on a defined hourly flow, stable pressure, safe continuity and a commissioning date linked to production ramp-up.
Gas Malaysia列出的工业用途包括炉窑、锅炉、食品加工、玻璃制造、制氢、肥料生产和热电联产。此类项目需要的不只是“有燃料”,还可能要求明确的每小时流量、稳定压力、连续供应和配合投产计划的接驳日期。

A property search should therefore begin with the process requirement, not with the estate name. Two factories on the same road may have different connection feasibility because of their load, distance to the usable main, pressure tier, road and drain crossings, station area, title boundaries, landlord consent and internal layout.
因此,找厂必须从生产工艺开始,而不是先看工业区名称。同一条路上的两间厂房,也可能因为用量、与可用主管的距离、压力级别、道路和排水沟穿越、设施用地、产权边界、业主同意及厂内布局而出现完全不同的接驳条件。

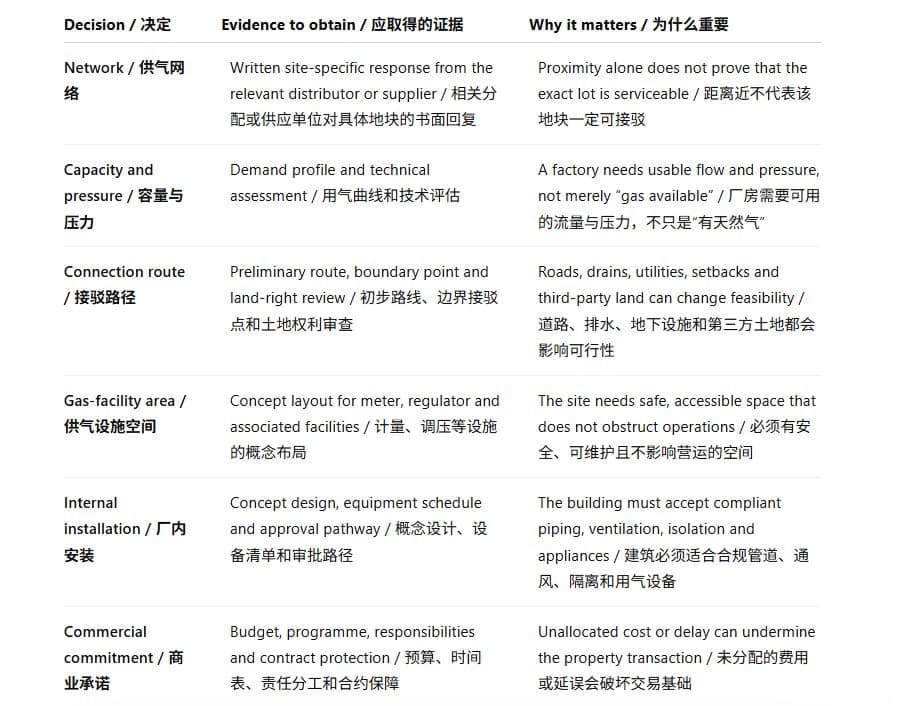

The six decisions to verify before signing签约前必须核实的六项决定

Article image
Article image

1. Define the factory's gas requirement before asking about availability 先定义厂房的用气需求

Prepare a one-page process brief. At minimum, record:
准备一页生产工艺说明,至少列出:
- each gas appliance or process: boiler, oven, furnace, dryer, kiln, burner, CHP unit or feedstock use;每一项用气设备或工艺,例如锅炉、烘炉、熔炉、干燥机、窑炉、燃烧器、热电联产装置或原料用途;- normal and maximum hourly consumption;正常和最高每小时耗气量;
- simultaneous operating load and start-up demand;同时运行负荷和启动需求;
- required inlet and burner pressure;设备入口及燃烧器所需压力;
- operating hours, shifts and seasonal changes;每日工时、班次和季节变化;
- commissioning date and future expansion;投产日期及未来扩产计划;
- continuity requirement and acceptable interruption;允许中断程度及连续供气要求;
- equipment make, model, heat input and certification status; and设备品牌、型号、热输入和认证资料;以及
- proposed backup fuel or shutdown strategy.备用燃料或停产方案。

Monthly energy consumption is not enough for a connection study. A plant with short high-load cycles can create a different network and regulator requirement from one with the same monthly consumption spread evenly across 24 hours.
只有月度用量并不足以进行接驳研究。两间工厂的月耗气量可能相同,但短时间高负荷运行与24小时平均运行,对管网及调压设备的要求完全不同。

If the imported machinery specifications are in Chinese, translate the relevant fuel, pressure, connection and safety information into an English technical schedule for Malaysian consultants and authorities. Reconcile units carefully—especially pressure, flow, heat input and heating value.
如果进口设备的规格书只有中文,应把燃料、压力、接口和安全资料整理成英文技术表,供马来西亚顾问和主管单位使用,并仔细统一压力、流量、热输入及热值单位。

2. Confirm the correct network, distributor and supply arrangement 确认正确的分配网络与供气安排Identify who owns or operates the relevant distribution network and which licensed commercial party will supply or arrange delivery of gas to the premises. Under Malaysia's Third-Party Access framework, the physical distribution and the commercial gas-supply arrangement can involve different agreements and parties.查明谁拥有或营运有关天然气分配网络,以及哪一家持牌商业单位会向厂房销售天然气或安排输送。在马来西亚第三方准入制度下,实体管网分配与商业供气可能由不同协议和单位处理。

Gas Malaysia Distribution's published FAQ separates:
Gas Malaysia Distribution 的公开问答把相关安排区分为:
- the Gas Supply Agreement for gas purchase;
用于购买天然气的 Gas Supply Agreement;
- the Gas Connection Manual for the physical connected-facilities arrangement; and
用于实体连接设施安排的 Gas Connection Manual;以及
- the Lease Agreement for the area allocated to gas facilities.
用于分配天然气设施占地的 Lease Agreement。

This distinction matters in a property transaction. “The previous tenant had gas” does not prove that the incoming occupier can simply take over every contract, licence, connection obligation or allocated area. Obtain the existing agreements, account details, disconnection status and equipment-ownership record.
因此,“上一家租户有用天然气”不代表新租户可以自动接手所有合约、执照、接驳责任和设施用地。应取得原有协议、账户资料、断供状态和设备权属记录。

3. Obtain written, site-specific feasibility—not a verbal assurance 取得针对具体地块的书面可行性回复

Give the relevant supplier or distributor the property address, title or lot information, site plan, target demand, pressure, operating profile and required date. Ask for a written preliminary response covering:
向相关供气或分配单位提供厂房地址、地段或产权资料、总平面图、目标流量、压力、营运曲线和要求日期,并要求书面初步回复:
- whether the exact property lies within a serviceable area;该地块是否位于可服务范围;
- the likely connection point and pressure basis;可能的接驳点和压力基础;
- whether a network assessment or reinforcement may be required;是否需要管网评估或强化工程;
- information still needed from the applicant;申请人仍需提供什么资料;
- land or station-area requirements;路径或设施用地要求;
- the indicative application and agreement pathway; and初步申请及协议流程;以及
- the status of any earlier connection at the premises.该厂房之前是否有接驳、目前处于什么状态。

Gas Malaysia Distribution's Access Arrangement explains that available firm capacity is determined for distribution networks and provides mechanisms for network assessment and new-facilities applications. Although the detailed access process is between licensed market participants, it reinforces a useful property lesson: network capacity is assessed; it should not be inferred from distance alone.
GMD 的 Access Arrangement 说明分配网络的可用容量需要计算,并设有网络评估和新设施申请机制。其详细流程主要涉及持牌市场参与者,但对买厂和租厂有一个非常重要的启示:容量必须经过评估,不能仅凭距离推断。

Treat any preliminary response as conditional until design, consents, commercial terms and regulatory approvals are complete.
在设计、同意、商业条款和监管审批完成前,任何初步回复都应视为附带条件。

4. Verify flow, pressure, quality and continuity against the process 把流量、压力、气质与连续性对准生产工艺

The connection must support the equipment at the point where it will operate. Ask the process engineer, equipment vendor and gas specialists to reconcile:
连接系统必须在设备实际运行点满足要求。让工艺工程师、设备供应商和燃气专业人员共同核对:
- minimum and maximum flow;最低和最高流量;
- peak and ramp-up demand;高峰及启动负荷;
- delivery and appliance pressure;交付压力和设备压力;
- allowable pressure fluctuation;可接受的压力波动;
- gas composition or quality assumptions relevant to the process;工艺所采用的气体成分或质量假设;
- metering accuracy and data requirements;计量精度和数据需求;
- planned maintenance or interruptible-service implications; and计划检修或可中断供气的影响;以及
- future production expansion.未来扩产需求。

A simple statement such as “the factory uses natural gas” does not establish that the existing connection is adequate for a larger kiln, new production line or simultaneous boiler operation. Obtain historic gas bills and interval or peak data where available, but model the incoming operation, not only the previous occupier's consumption.
“原厂使用天然气”并不能证明现有接驳足以支持更大的窑炉、新生产线或多台锅炉同时运行。可以索取历史账单和高峰数据,但最终必须按新业主或新租户的生产方案重新计算。

Article image

5. Prove the connection route and land rights 核实完整接驳路径与土地权利

Map the full physical route from the usable distribution main to the termination point, meter or regulator station, then into the factory. Check:
从可用主管开始,绘制到终止点、计量或调压设施,再进入厂房内部的完整路线,并检查:
- public road and reserve crossings;公共道路和保留地穿越;- drains, culverts, sewers, water mains, power cables and telecommunications;排水沟、涵洞、污水管、水管、电缆和通信线路;
- title boundaries, common property and neighbouring land;地界、共用区域和邻地;
- industrial-park management or developer consent;工业园管理方或发展商同意;
- easement, wayleave, lease or access rights;地役权、通行权、租赁或检修权;
- building setbacks, fire access and emergency routes;建筑退界、消防通道和紧急路线;
- pavement, landscaping and security-fence reinstatement;路面、绿化和围栏恢复;
- pipe protection from vehicle impact and future excavation; and防止车辆撞击和未来挖掘损坏的措施;以及
- responsibility for maintenance access.长期维护进入权由谁负责。

The Gas Supply Regulations 1997 contain specific provisions on locating gas installations, obtaining information before excavation, notification, supervision, hand digging, protection, damage and emergency action. A route that appears simple on an estate map may become expensive or delayed when it crosses congested utilities or land controlled by another party.
《1997年天然气供应条例》对燃气设施位置、挖掘前索取资料、通知、监督、人工确认管位、防护、损坏处理和紧急行动设有规定。工业区地图上看似简单的路线,可能因为地下设施拥挤或第三方土地而显著增加费用与时间。

Ask the property lawyer to confirm that the required rights will survive a sale, financing, landlord change or lease expiry. A technical route without durable land rights is not a bankable connection plan.
还应让律师确认有关权利在出售、融资、更换业主或租约届满后仍然有效。只有技术路线、没有长期土地权利的方案,并不能构成可靠的接驳计划。

6. Reserve safe and accessible space for gas facilities 为调压、计量等设施保留安全空间

The property may need a dedicated area for metering, pressure regulation, isolation, filtration, telemetry and other connected facilities. The final arrangement is site-specific, but the concept layout should address:
厂区可能需要专用区域设置计量、调压、隔离、过滤、遥测及其他连接设施。最终方案因项目而异,但概念布局应考虑:
- equipment footprint and clearances;设备占地和安全间距;
- permanent distributor and emergency access;分配单位及紧急人员的长期进入权;
- ventilation and safe discharge locations;通风与安全排放位置;
- impact protection and security;防撞和保安;
- separation from ignition sources, openings and incompatible activities;与点火源、开口及不相容活动的分隔;
- flood level, drainage and ground stability;洪水、排水和地基稳定;
- maintenance lifting and vehicle access;维护吊装及车辆进入;
- interface with guardhouse, parking and truck circulation; and与警卫室、停车位和货车动线的关系;以及
- expansion or additional meter requirements.未来扩展或增加计量设备的可能。

Do not assume an unused corner of the yard is available. It may be inside a setback, future road reserve, fire-appliance route, drainage area or landlord-retained space. GMD's published FAQ confirms that a separate lease agreement can formalise the area used to station gas facilities; property documents should therefore allocate that area clearly.
不要把院子里一个看似空置的角落直接当作可用地。该位置可能属于建筑退界、未来道路、消防车道、排水范围或业主保留区域。GMD 的公开问答确认,另行签署 Lease Agreement 可用于正式确定天然气设施占地,因此交易文件也应明确分配该范围。

7. Assess the building and internal piping route 检查建筑与厂内管线路径
After the boundary connection, the gas still has to reach each appliance safely. Review:
天然气在进入地界后,仍须安全输送到每台设备。应检查:
- entry point into the building;进入建筑物的位置;
- above-ground and internal pipe route;地面上及室内管线路径;
- supports, sleeves, isolation and protection;支架、套管、隔离和防护;
- ventilation, detection and emergency shut-off strategy;通风、探测和紧急关断策略;hazardous-area and electrical interfaces where relevant;危险区域及电气接口;
- combustion-air and exhaust/flue requirements;助燃空气和排烟要求;
- fire compartment and escape-route interfaces;防火分区与逃生路线;
- roof, wall and floor penetrations;屋顶、墙体和地板穿孔;
- access for inspection and maintenance; and检查和维护空间;以及
- future machinery relocation.将来移动设备的影响。

The Energy Commission states that Approval to Install applications for new installations or extensions must be made by a registered gas contractor. It cites applicable safety and design requirements under the Gas Supply Act 1993, Gas Supply Regulations 1997, Commission guidance and relevant standards.
能源委员会说明,新燃气装置或延伸工程的 Approval to Install(ATI)必须由注册燃气承包商申请,设计和施工须符合《1993年天然气供应法令》《1997年天然气供应条例》、委员会指南及相关标准。

Do not appoint a general M&E contractor to “add a pipe later” without confirming the required registered gas contractor and competent-person scope.
不要在未确认注册燃气承包商及合资格人员的范围前,让一般机电承包商承诺“以后加一条管就可以”。

Article image

8. Map the approval, testing and commissioning pathway 把审批、测试和投运流程纳入项目时间表

The approval sequence should be part of the project programme before the property agreement becomes unconditional.
在物业协议转为无条件之前,应先把整个审批路线放进项目进度表。

The Energy Commission's current public guidance states:
能源委员会目前的公开说明包括:
- Approval to Install (ATI) is required before work begins on a new gas installation or extension;
新燃气装置或延伸工程动工前需要 ATI;
- ATI applications are made by registered gas contractors;
ATI 由注册燃气承包商申请;
- work must be performed within the relevant contractor and competent-person classes;
工作必须由相应等级的承包商及合资格人员执行;
- after completion, Approval to Operate (ATO) is applied for with a Certificate of Completion and Test Certificate signed by the appropriate competent person; and
完工后申请 Approval to Operate(ATO),并提交由适当合资格人员签署的完工证书和测试证书;以及
- the installation, testing and commissioning must meet the applicable safety and technical requirements.
安装、测试与调试须符合适用的安全和技术要求。

The Commission publishes processing targets of 15 working days for a complete ATI application and seven working days for a complete ATO application. These are application-processing targets, not the total connection programme. Network study, design, land rights, civil works, equipment procurement, inspections, corrections and commercial agreements can add substantial time.
能源委员会公布,在申请文件完整的情况下,ATI 处理目标为15个工作日,ATO 为7个工作日。这只是审批处理目标,并非整个接驳工程所需时间。管网评估、设计、土地权利、土建、设备采购、检查、整改和商业协议都可能增加项目周期。

The Energy Commission also states that work on gas pipelines and installations must be supervised by a registered competent person employed by the gas contractor carrying out the work. Verify the registration and permitted scope rather than accepting a company profile alone.
能源委员会也说明,燃气管道和装置工程必须由执行该工程的燃气承包商所聘用、并已注册的合资格人员监督。应核实注册状态和允许工作范围,而不是只看公司简介。

9. Integrate process safety, fire, maintenance and insurance 同步处理工艺安全、消防、维护和保险A gas connection does not make the whole process safe or approved. The incoming occupier must coordinate the gas system with the machinery, burner management, ventilation, fire strategy, emergency plan and workplace controls.
接通天然气并不代表整套生产工艺已经安全或获得批准。新使用者必须把燃气系统与机器、燃烧器管理、通风、消防策略、紧急预案和工作场所控制整合。

Before occupation, confirm:
进场前应确认:
- gas detection and alarm philosophy where required;必要时的气体探测和警报策略;
- automatic and manual isolation;自动及手动隔离;
- burner-management and flame-failure protection;燃烧器管理和熄火保护;
- ventilation and combustion-air provision;通风与助燃空气;
- emergency contacts and response procedures;紧急联络和应变流程;
- inspection, test and preventive-maintenance plan;检查、测试和预防性维护计划;
- modification-control procedure;设备改造控制流程;
- staff competency and operating instructions;员工能力和操作指示;
- insurer notification and risk-engineering conditions; and 是否已经通知保险公司及风险工程条件;以及
- responsibilities during shutdown, vacancy or lease termination. 停产、空置或租约终止时的责任。

Also check whether boilers, pressure equipment, chimneys, emissions, hazardous materials or the manufacturing activity trigger separate approvals or licences. Gas approval is not a substitute for building, planning, environmental, fire or occupational-safety compliance.
同时检查锅炉、压力设备、烟囱、排放、危险物料或制造活动是否需要其他审批或执照。燃气审批不能替代建筑、规划、环保、消防或职业安全合规。

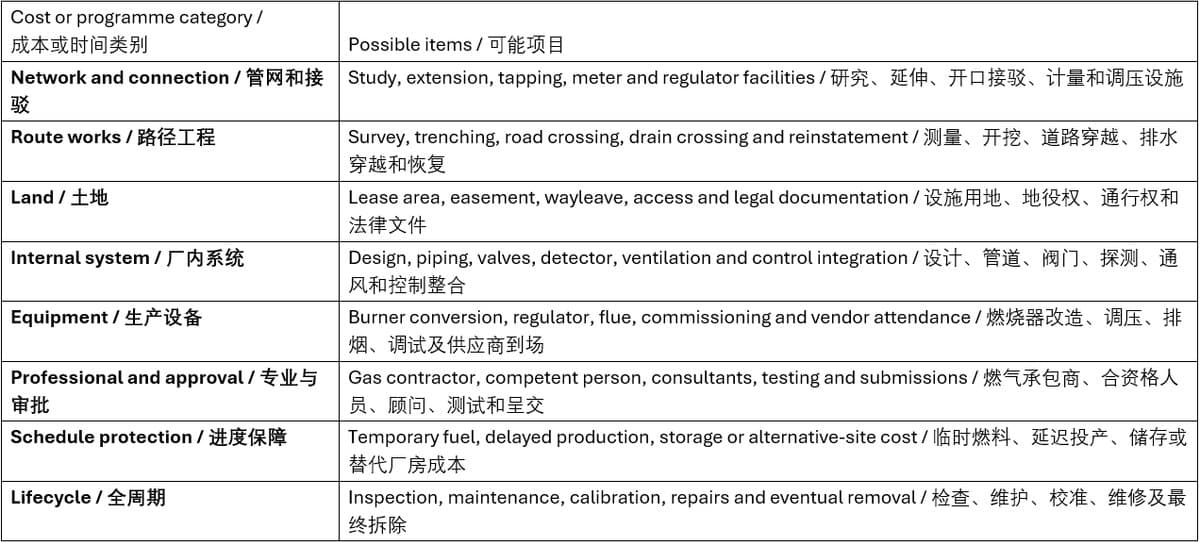

10. Price the complete project and protect the transaction  计算完整成本,并在交易文件中设置保障

Compare properties using the complete gas-enablement cost, not only the fuel tariff.
比较厂房时应计算完整的天然气启用成本,而不是只比较燃料价格。

Article image

Where gas is critical, consider project-specific provisions in the sale and purchase agreement, tenancy or offer covering:
如果天然气是生产关键条件,买卖协议、租约或要约可在律师建议下处理:
- a due-diligence period and site access;尽调期限和进场权;- satisfactory written gas feasibility;满意的书面供气可行性;
- the defined demand and pressure basis;明确的流量与压力基础;
- landlord consent and allocation of station area;业主同意和设施用地分配;
- rights for route surveys, submissions and works;路线测量、申请和施工权;
- responsibility and cost cap for external and internal works;外部及内部工程的责任和费用上限;
- transfer, replacement or termination of existing gas agreements;原有燃气协议的转移、更换或终止;
- handover of drawings, certificates, test records, bills and maintenance data;图纸、证书、测试记录、账单和维护资料交接;
- a long-stop date linked to critical approvals or connection milestones; and与关键审批或接驳里程碑挂钩的最后期限;以及
- extension, price adjustment or termination rights if a required connection cannot be secured.无法取得关键接驳时的延期、调价或终止权。

The exact drafting requires legal advice. The commercial objective is simple: do not allow an unverified utility assumption to become the buyer's or tenant's unlimited obligation after signing.
具体条款须由律师起草。商业目标很简单:不要让一项未经验证的公用事业假设,在签约后变成买方或租户没有上限的责任。

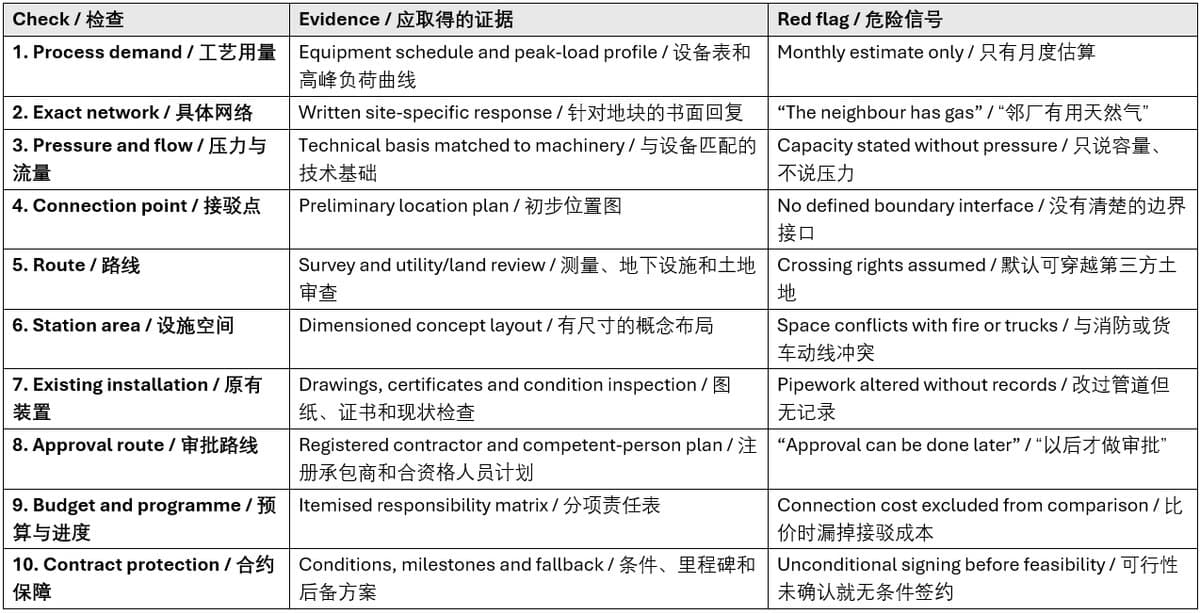

A 10-point buyer and tenant checklist买家和租户的10项检查表

Article image

Conclusion总结Piped natural gas can make a Malaysian factory highly suitable for heat-intensive manufacturing, but availability must be proven across the entire chain: network, capacity, pressure, route, site area, internal piping, equipment, approvals and commercial agreements.
管道天然气可以让一间马来西亚厂房非常适合高热能制造,但必须证明整条链条都可行:网络、容量、压力、路径、设施用地、厂内管道、生产设备、审批和商业协议。

The safest property decision follows three steps:
最稳妥的选厂方式有三步:
- define the incoming process requirement;先定义新使用者的生产工艺和用气要求;
- obtain written site-specific feasibility and a preliminary connection concept; and取得针对具体地块的书面可行性及初步接驳概念;以及
- protect the transaction until the critical technical, land, approval, cost and timing conditions are satisfactory.在关键技术、土地、审批、费用和时间条件满意前,以交易条款保护买方或租户。

XPillar can help Malaysian and China-based manufacturers shortlist factories by location, building specification, utility requirements, logistics access and expansion needs before specialist gas, engineering and legal due diligence begins.
XPillar可协助马来西亚及中国企业按地点、建筑规格、公用事业、物流通道和扩产需求初筛厂房,再由燃气、工程和法律专业人员进行项目尽调。

Frequently Asked Questions常见问题

1. Does a gas pipeline beside the road mean the factory can connect?

道路旁有天然气管道,是否代表厂房一定可以接?

No. It indicates possible proximity, not confirmed
serviceability, capacity, pressure, route, cost or timing. Obtain a written
site-specific assessment from the relevant gas parties.

不是。附近有管道只代表可能接近网络,并没有确认该地块的可服务性、容量、压力、路线、费用和时间。必须向相关单位取得针对具体厂房的书面评估。

2.Can a new tenant take over the previous occupier's gas supply?

新租户可以直接接手上一家租户的天然气吗?

Do not assume so. Review the supply agreement, physical
connection arrangement, gas-facility lease, account, licences or exemptions,
disconnection status and internal-installation records. Some items may require
a new application or agreement.

不能假设可以。应检查供气协议、实体接驳安排、设施用地协议、账户、执照或豁免、断供状态和厂内安装记录。部分项目可能需要重新申请或签署新协议。

3. What information is needed for a preliminary gas assessment?

初步天然气评估需要提供什么资料?

Provide the exact property, site plan, process and
equipment schedule, normal and peak demand, pressure, operating hours,
commissioning date, expansion plan and proposed station location.

通常应提供准确物业资料、总平面图、工艺及设备表、正常和高峰用量、压力、营运时间、投产日期、扩产计划及建议设施位置。

4. Is Approval to Install required before gas piping work begins?

燃气管道动工前需要 Approval
to Install 吗?

The Energy Commission states that ATI is required before
work on a new gas installation or extension, and that the application must be
made by a registered gas contractor.

能源委员会说明,新燃气装置或延伸工程动工前需要
ATI,并由注册燃气承包商提出申请。

5. Is Approval to Operate the same as completing construction?

工程完工是否等于可以投运?

No. After a new installation is completed, the ATO
application includes the Certificate of Completion and Test Certificate signed
by the appropriate competent person. Construction completion alone is not
authority to operate.

不是。新装置完工后,ATO
申请还须附上由适当合资格人员签署的完工证书和测试证书。工程完工本身不等于已经获准运行。

6. How long does a factory gas connection take?

厂房天然气接驳需要多长时间?

There is no universal total duration. The Energy
Commission publishes processing targets for complete ATI and ATO applications,
but the overall project also depends on network assessment, design, land
rights, civil works, equipment, testing, corrections and commercial agreements.

没有统一答案。能源委员会虽然公布完整
ATI 和 ATO 申请的处理目标,但总时间还取决于管网评估、设计、土地权利、土建、设备、测试、整改和商业协议。

7. Should gas feasibility be checked before paying a deposit?

是否应该在支付订金前检查天然气可行性?

For a gas-dependent operation, investigate it before
making an unconditional commitment. Obtain legal advice on due-diligence
conditions, access rights, milestones and fallback options.

如果生产依赖天然气,应在作出无条件承诺前调查,并向律师咨询尽调条件、进场权、里程碑和后备方案。
